Forum

Welcome to ProjeQtOr new Forum. We migrated old forum to the new website.
You will find all your posts here, with your usual account.
Just one point : you’ll have to reinitialize your password. Use “Lost password” feature.

Planned start date

Notifications
Clear all

Planned start date

8 Posts
2 Users
0 Reactions
8,939 Views
(@hoss)
Posts: 4
Active Member
Topic starter

[#1818]

Hello,
I'm wondering if it is possible for the entire project timeline to shift to the left or right as appropriate when planned tasks are completed ahead of or behind schedule.
Thank you.



Posted : 21 May 2014 22H59
(@babynus)
Posts: 14952
Member Admin


Recalculating planning will do this.



Posted : 21 May 2014 23H10
(@hoss)
Posts: 4
Active Member
Topic starter


I am having difficulty having a follow on phase of a project shifting when a predecessor milestone is reached. Re-Calculating does not shift the project even though the milestone is 'done'. Am I missing a requirement? Please advise.



Posted : 24 May 2014 1H24
(@babynus)
Posts: 14952
Member Admin


"Reach" of milestone is not enough : it could be late (delayed).
You must set it to "done".
Then real end date will be automatically set and planning will take it into account.



Posted : 24 May 2014 23H08
(@hoss)
Posts: 4
Active Member
Topic starter


I have a three phase project ongoing with up to 30 dependent tasks (activities) per phase. I have the project built so that the phases have completion milestones as predecessors to follow on phases. Even though all activities and the completion milestone have been set as done, the follow on phases have not/will not shift (left) to the earliest available date for earliest project completion upon recalculating planning. What am I missing? Please advise.

Hoss



Posted : 05 Jun 2014 23H35
(@babynus)
Posts: 14952
Member Admin


Could you please post a screenshot ?



Posted : 06 Jun 2014 18H30
(@hoss)
Posts: 4
Active Member
Topic starter

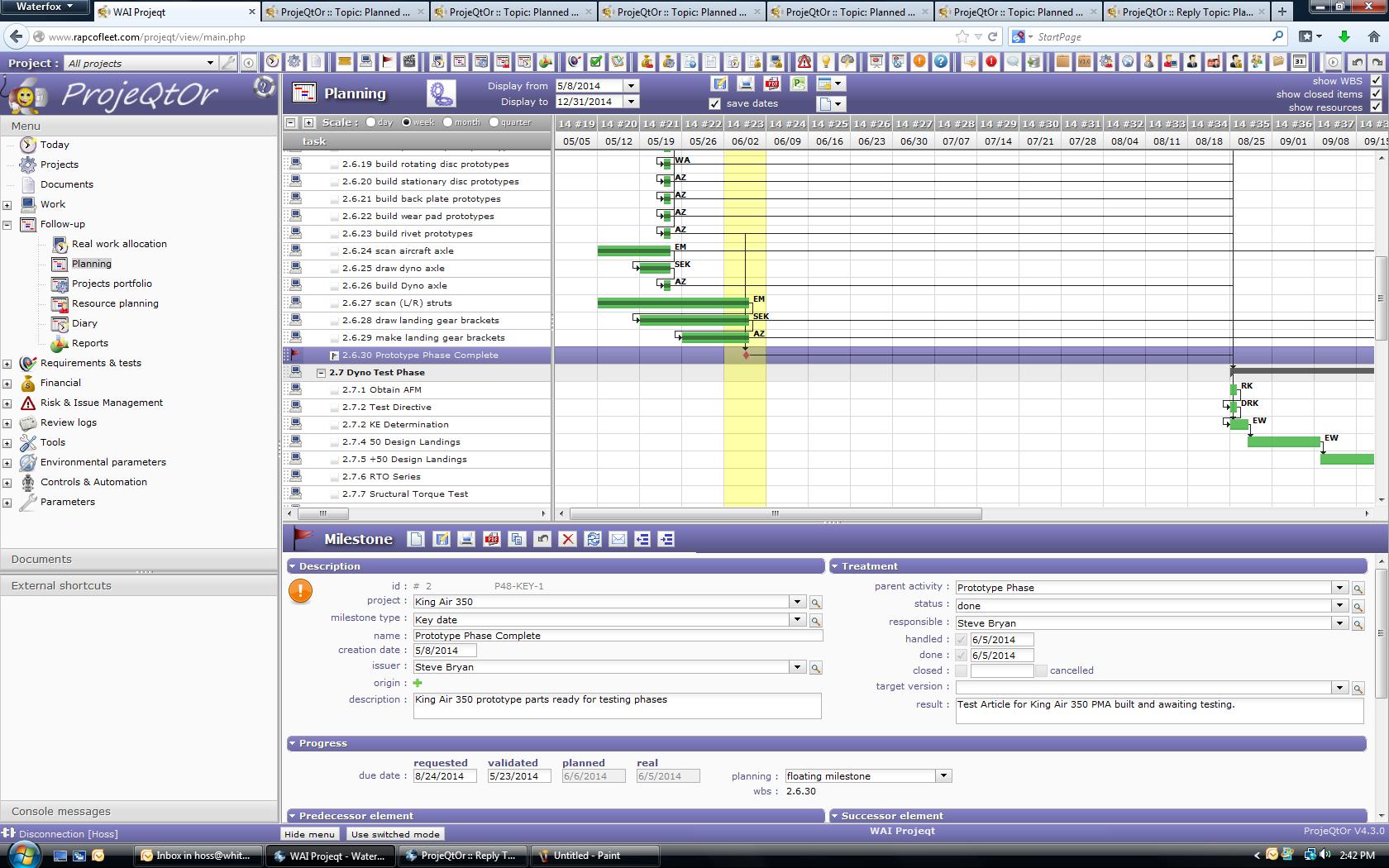

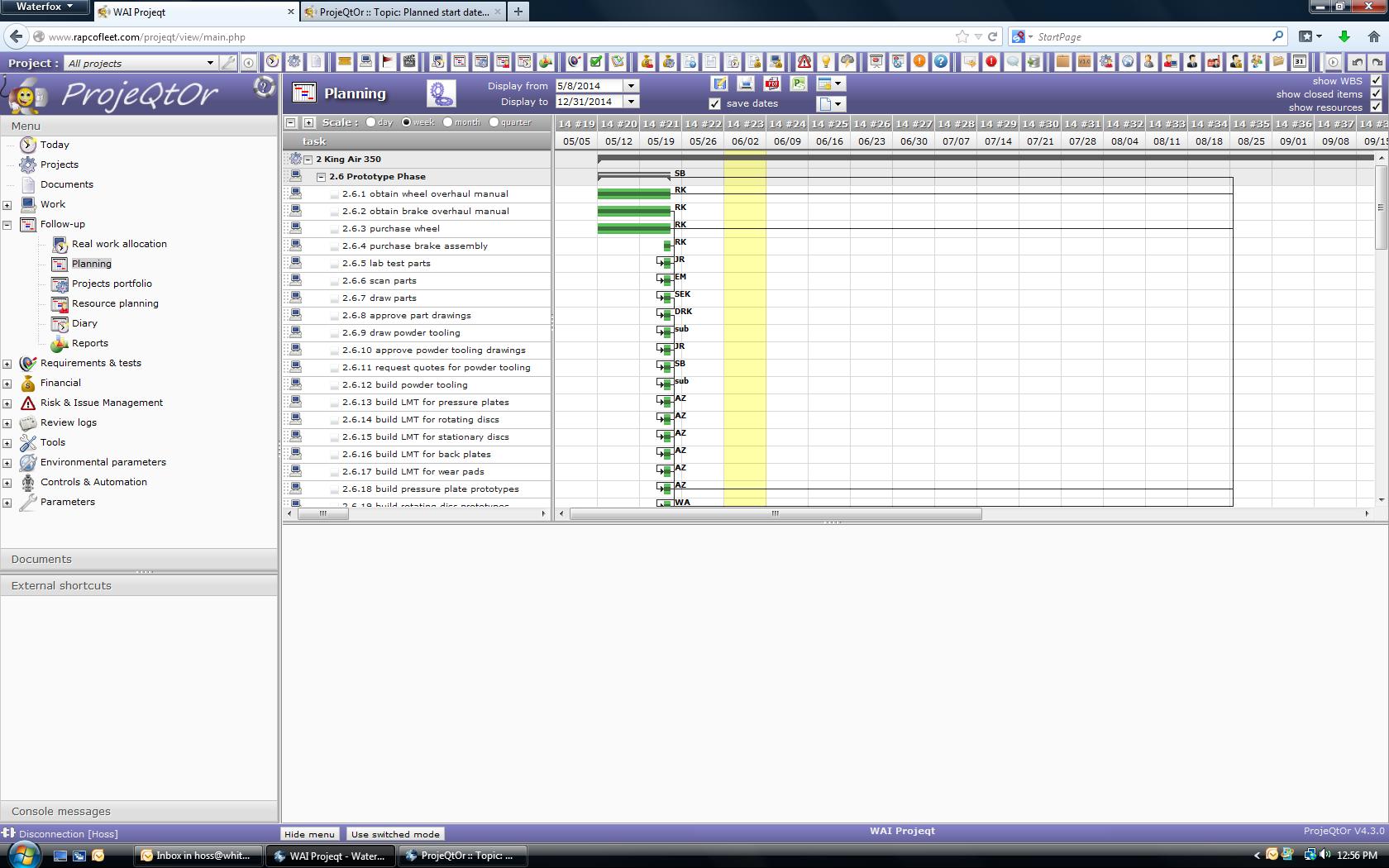

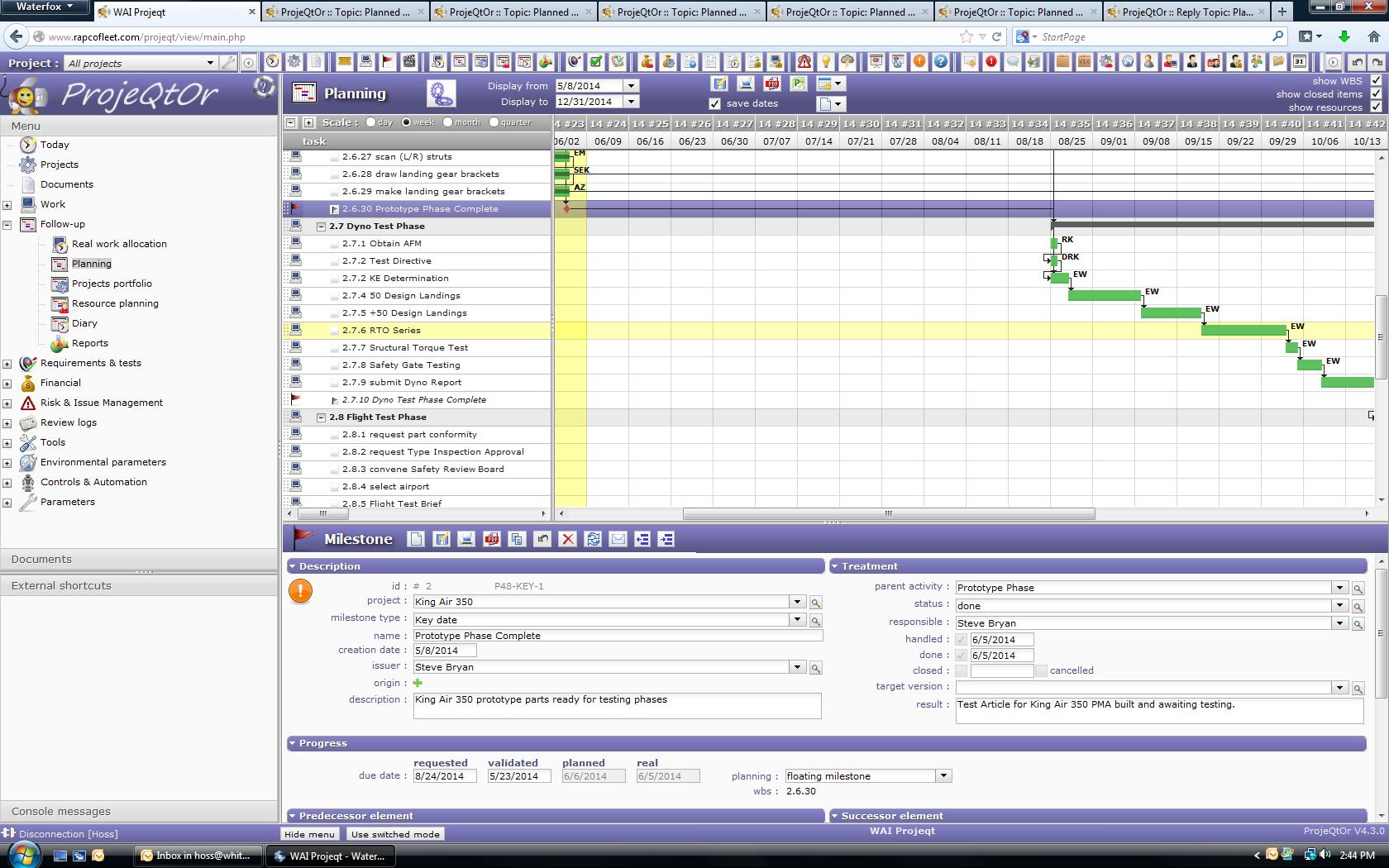

Please see the screenshots I've provided. Thank you for your support.



Posted : 06 Jun 2014 23H46
(@babynus)
Posts: 14952
Member Admin


Thanks for screen shots.
Clear it seems strange.

1) Did you re-run the planning calculation ?
2) Could you check dependencies predecesors of task 2.7 : is there a dependency with some delay ?



Posted : 07 Jun 2014 0H03
Share:

Scroll to Top
