How to fix assignation for a meeting / comment fixer l'assignation à une réunion

14 Posts
2 Users
0 Reactions
23.8 K Views
(@noisette)
Posts: 24
Active Member
Topic starter

[#3960]

Dear all,
I am Christophe Noisette, a French journalist specialized on issues related to GMOs and seeds. I try to used projeQtor but i have several understanding problem.
By example, we have a CA (board meeting), in 2017, January, 9th. The duration of the meeting is 7.5 hours. But when I ask for the "planning", I have several errors. I can't manage to oblige the planification to use all the ressources to the meeting. The meeting is not an option... So I want to precise it, but where... and is it possible ?
All the best
Christophe
noisette-at-infogm-dot-org

PS : I will be happy if one of you could send me a private email to "discuss" about ProjeQtor. I think I don't well understand some bases, but the manual is quite light.



Posted : 22 Dec 2016 14H07
(@babynus)
Posts: 14952
Member Admin


Please post errors reported.



Posted : 26 Dec 2016 2H11
(@noisette)
Posts: 24
Active Member
Topic starter

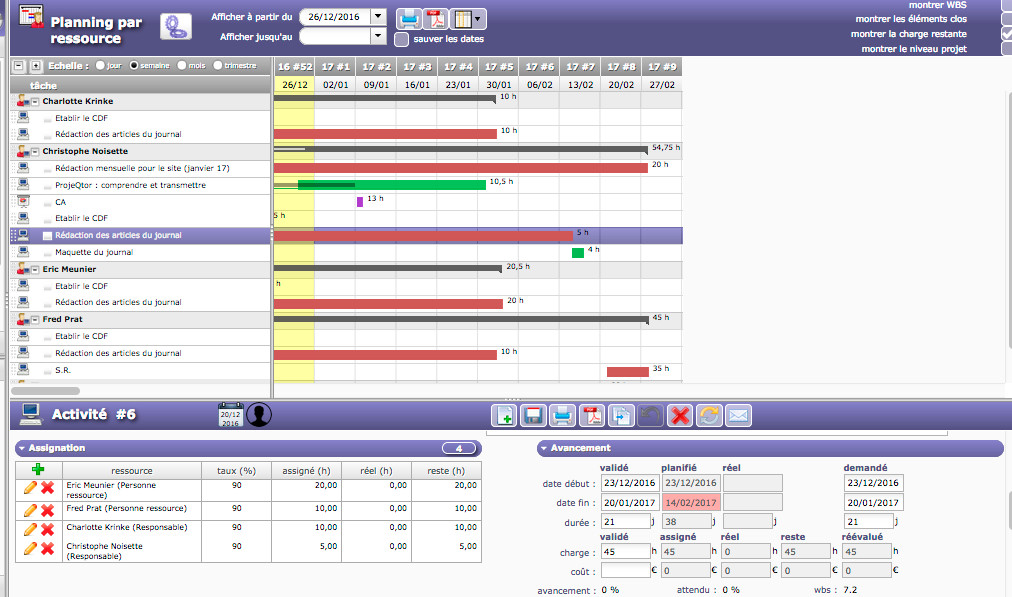

Please find enclose two pictures which explain better than I can the pb I meet with this meeting.



Posted : 26 Dec 2016 13H08
(@noisette)
Posts: 24
Active Member
Topic starter

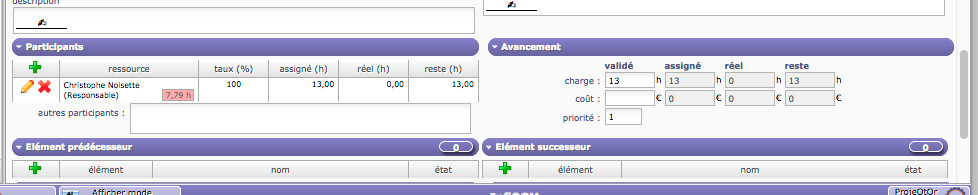

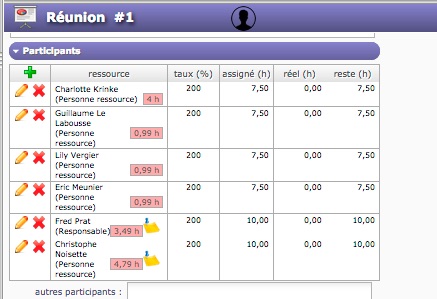

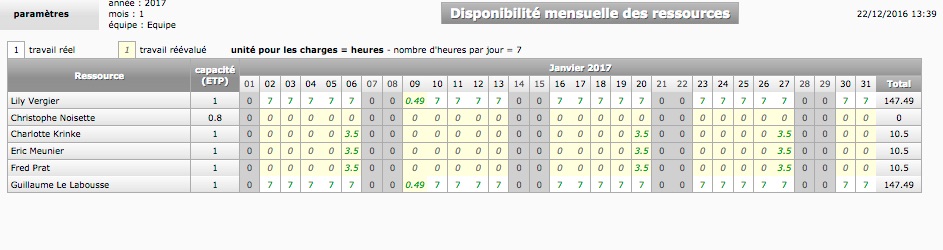

Sorry, I sent two pic which is not concerned by my pb... My pb is that I want to impose some plannification, and I can... and when ProjeQtor decide to plan some ressources, I can't change it. Even if I reduce assignation... Even If I delete some task. I ask for a new plannification, but nothing change.



Posted : 26 Dec 2016 13H14
(@babynus)
Posts: 14952
Member Admin


1) Do you run planning calculation for concerned project ?
2) What is project type ?
3) has project "fixed planning" ?



Posted : 26 Dec 2016 13H22
(@noisette)
Posts: 24
Active Member
Topic starter


1) Do you run planning calculation for concerned project ?
2) What is project type ?
3) has project "fixed planning" ?

1) Yes, I did it.
2) I change the project type : i have created a new one which is "projet ponctuel". I didn't know that "project type" has an influence on the plannification. Where could I see the consequences of a special type to the plannification process?
3) Yes, Journal 144 is "fixed planning"



Posted : 26 Dec 2016 13H40
(@babynus)
Posts: 14952
Member Admin


3) Yes, Journal 144 is "fixed planning"

Then planning is never recalculated for this project 😉
Uncheck this option, it should fiw your issue.



Posted : 26 Dec 2016 13H45
(@noisette)
Posts: 24
Active Member
Topic starter


Yes, now the planning is recalculated. Thanks.
Now i would like to know why the meeting (January, 9th) has still a "problem".

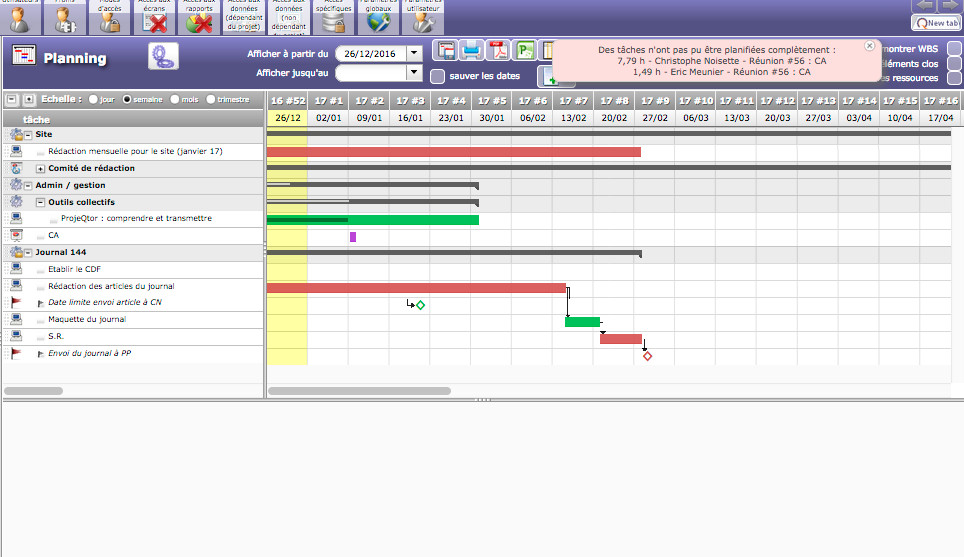

I have on planning issue, an alert : "Des tâches n'ont pas pu être planifiées complètement :
7,4 h - Christophe Noisette - Réunion #56 : CA"... why? I have enough ressources, so I don't understand why the planning can allow all the necessary ressources to this meeting.
Thanks again
Christophe



Posted : 26 Dec 2016 14H10
(@babynus)
Posts: 14952
Member Admin


Check real work allocation for this user (see previous message)



Posted : 26 Dec 2016 14H13
(@noisette)
Posts: 24
Active Member
Topic starter


Check real work allocation for this user (see previous message)

If real work allocation is imputations (in French), I checked it yet.

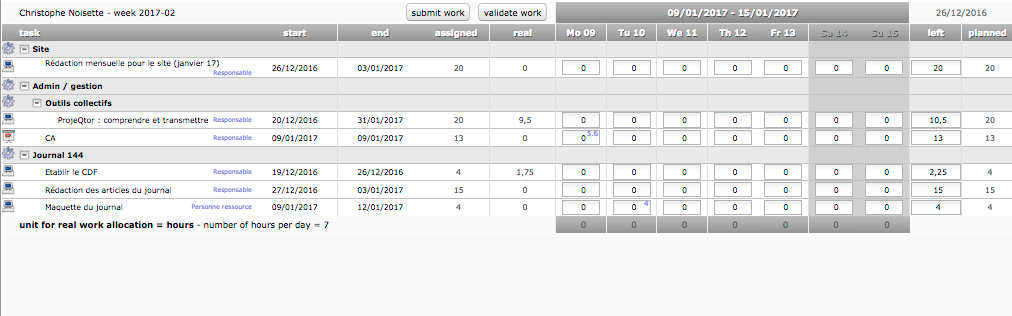

Please find the screen capture for this user, for January, 9th, when the meeting is going to occur.
You will see that just 5,4 hours are planned, and no other task is planned at that day. And I need more more resources, more time for this meeting.
I assigned 13 hours because in our organisation some travel are calculated as "working time", so I need to assign the travel to calculate with precision the available resources.



Posted : 26 Dec 2016 14H23
(@babynus)
Posts: 14952
Member Admin


What is the type for project "Admin / Gestion" ?
=> If it is "Administratif", it explain the issue : "Adminsitrative" projects are not planned. Just change type for project. (for instance you may create new "internal" type)

What is affectation rate of "Christophe noisette" on project "Admin / Gestion" ?
=> If it is zero ,it explians the issue : rate to zero forbid to reserve some work on the project.



Posted : 26 Dec 2016 14H32
(@noisette)
Posts: 24
Active Member
Topic starter


What is the type for project "Admin / Gestion" ?
=> If it is "Administratif", it explain the issue : "Adminsitrative" projects are not planned. Just change type for project. (for instance you may create new "internal" type)
/quote]

No, "admin / gestion" is not a "administrative" projects, but a "projet récurrent", a type of project I have created and which code is OPE (I think it is for "Operational project", isn't it?)

What is affectation rate of "Christophe noisette" on project "Admin / Gestion" ?
=> If it is zero ,it explians the issue : rate to zero forbid to reserve some work on the project.

No, Christophe Noisette has a 200% rate. I put a such rate because I want that for some project, the working day is more than a normal working day. I did it so to manage "over time work".



Posted : 26 Dec 2016 15H49
(@babynus)
Posts: 14952
Member Admin


No, Christophe Noisette has a 200% rate. I put a such rate because I want that for some project, the working day is more than a normal working day. I did it so to manage "over time work".

It won't change a thing compared to 100%.
Allocation rate is not a capacity, it is just a limit...



Posted : 26 Dec 2016 15H58
(@noisette)
Posts: 24
Active Member
Topic starter


No, Christophe Noisette has a 200% rate. I put a such rate because I want that for some project, the working day is more than a normal working day. I did it so to manage "over time work".

It won't change a thing compared to 100%.
Allocation rate is not a capacity, it is just a limit...

OK I put back 100% ... but I have still an alert saying that "Following tasks could not be completely planned :
7,4 h - Christophe Noisette - Meeting #56 : CA"... so the pb is not here...



Posted : 26 Dec 2016 16H20
