I assigned Resource one 1 days to one activity,why the planned duaration is 3 days?

5 Posts
2 Users
0 Reactions
4,749 Views
(@larryjq)
Posts: 6
Active Member
Topic starter

[#990]

I assigned Resource one 1 days to one activity,why the planned duaration is 3 days?



Posted : 28 Feb 2013 6H30
babynus
(@babynus)
Posts: 14954
Main Contributor Admin


Hi,

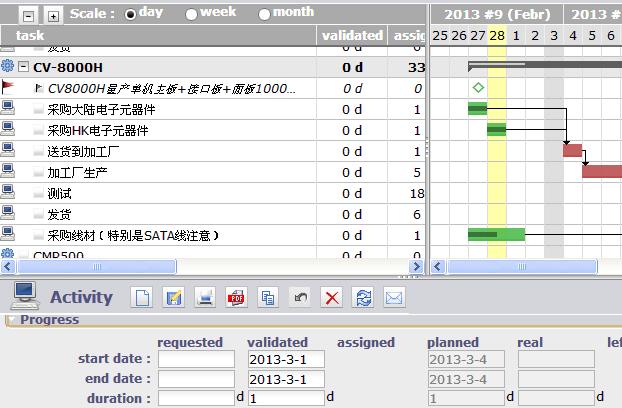

On your print screen, you don't dispayed the expected activity.
(the one with SATA in the name is expected)

But it gives me enough information to understand.
Your first activity, on 2013-2-27 is finished.
Your second activity, on 2023-2-28 is also finished
The "%SATA%" activity is started : apparently, 1/2 day is real work, on 2013-2-27, so you should have 1/2 day left.
Resource should have no availability left, so planning finished "%SATA%" activity on 2013-3-1 (as soon as possible).
This activity starts on 2013-2-27 (real work) and ends on 2013-3-1 (planned left work) : duration = 3 days !!! B)
What is not pointed out, is that there is no work on this task on 2013-2-28. You could see this is respource planning or work plan reports, on real work allocation for the resource...

Regards.



Posted : 28 Feb 2013 15H17
(@larryjq)
Posts: 6
Active Member
Topic starter


Thanks for your quick reply.As my understanding,Projectorria is resource driven software,right?Even if you assign the resource and the resource didn't input the real work or the resource has no availibility,the plan will delay according the resource limitation.This has advantage and disadvantage.The advantage:if reflect the process of the project.The disadvantage:You can't assign the resource accurately when the project starts.So it means that the due date change day by day.It confused the project leader.



Posted : 01 Mar 2013 4H39
babynus
(@babynus)
Posts: 14954
Main Contributor Admin


it means that the due date change day by day

Not the due date, but the planned date. Yes, it is the real project life ! 😛
And the target of Project'Or RIA is to reflect as near as possible the real situation, to let the project leader take the good decisions, and be able reach his target.

A project leader should not be confused when planned dates don't respect target dates. It is real life.
It is his duty to adapt project constraint to put project on the rails and get back to the target.



Posted : 01 Mar 2013 11H23
(@larryjq)
Posts: 6
Active Member
Topic starter


Thanks very much for your reply.To be frank,this is the best PM software I am looking for long time.Not one of the best,it is the BEST until now.I am studying step by step.Hope that we can deploy it in my job.Thanks again for your great job. 🙂



Posted : 01 Mar 2013 12H30
