You just diudn't run planning calculation, that will update planned dates.
It's exactly what I did but same problem.
I also validate the planning.
I haven't got any scheduled date in the task. Validate date (start and end) are inserted.
I guess you used "Administrative " for project type.
Administrative projects are not planned, there are used to store "out of duty" work (holidays, hillness, ...)
This is not an administrative project but an internal project.
Just to be sure your project is calculated : change something on allocation of a task (left work for instance).
The icon of the project should change : get an orange center.
Then calculate planning : does icon of project is still with orange center or does it go back to normal white center ?
I've change left work --> still have the project icon center white. (not orange)
Then i (re)calculate the planning --> still have the project icon center white. (not orange), no scheduled dates
Then I (re)change left work and (re)calculate the planning -->still have the project icon center white. (not orange), no scheduled dates.
You just did not run planning calculation.
Hi, Yes I did. I run it today but still same problem.
I've the same problem on differents projects. Same process to create project and task but on some task (not all) I have this problem.
1) Check if "fix planning" is checked on project.
Fixed project are not calculated.

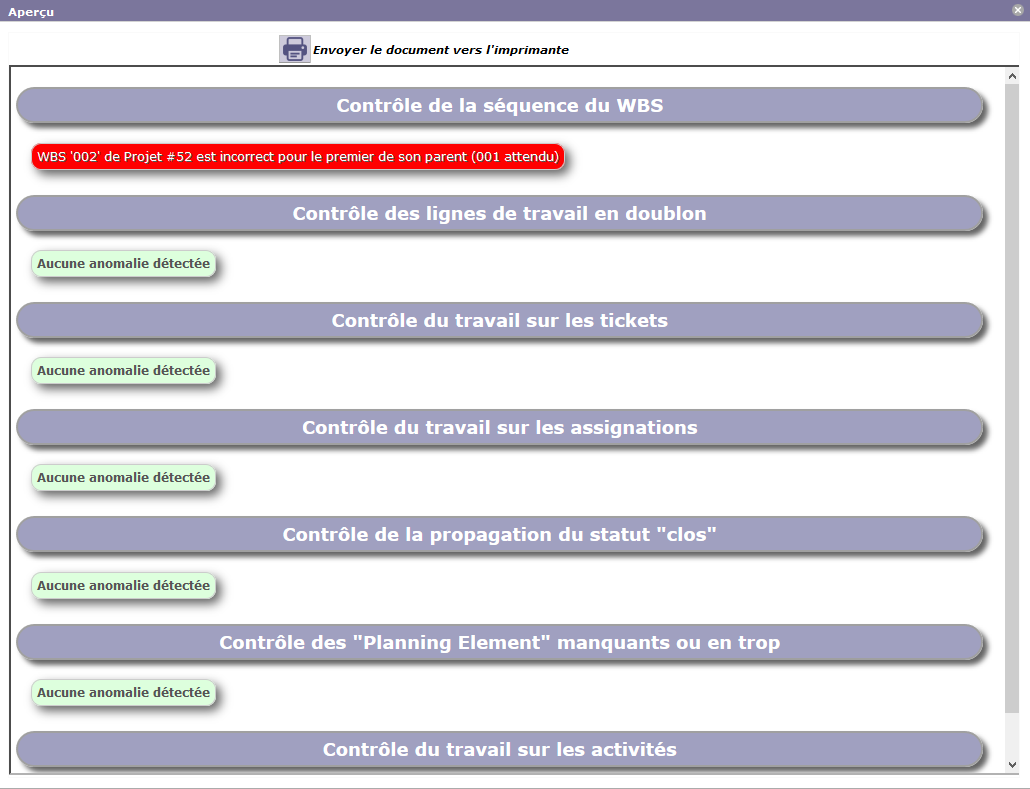

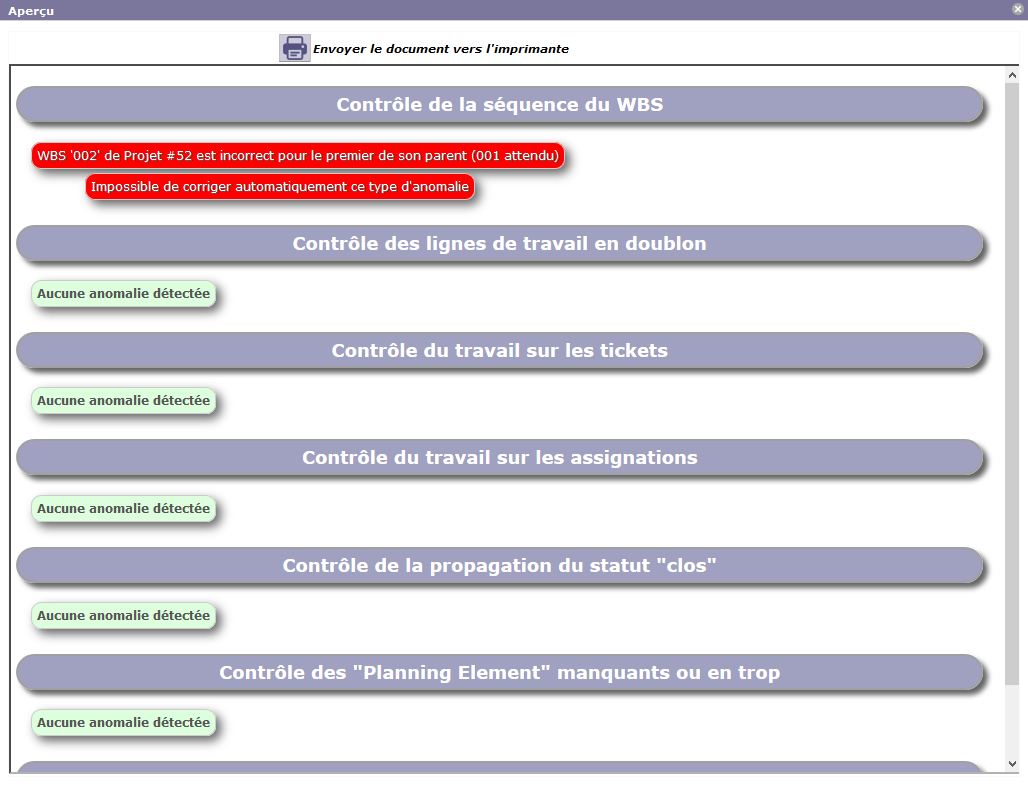

2) Check that WBS of structure is correct : run Consistency Check on Administrative screen.
Be sure to use V7.3.3 are issues exist up toi 7.3.2
Hi,
Strange.
What is the Capacity of the resource ?
Are you sure you have rights to calculate planning for this project ?
Check specific access right for your profile, and possibly for the profile allocated to the project.

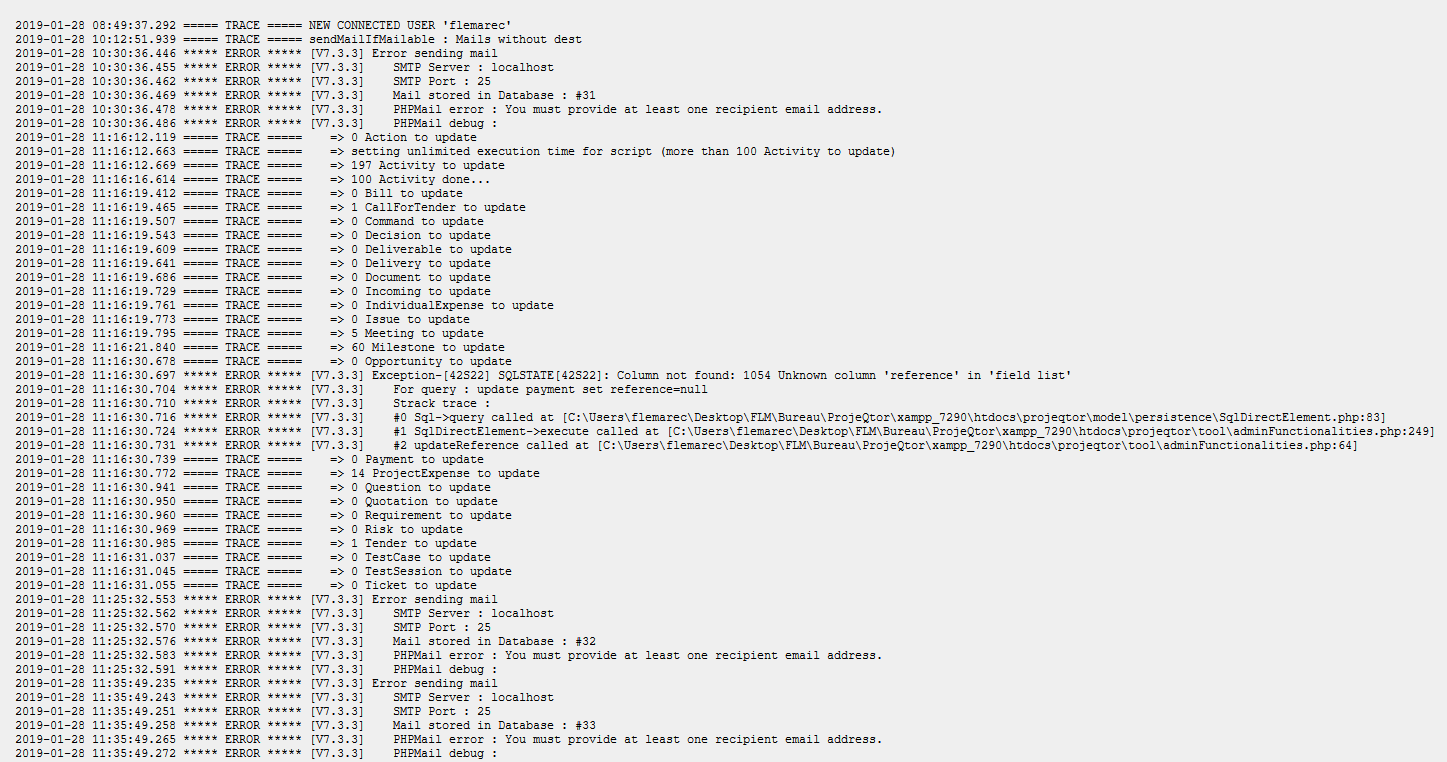

Also check for errors in log file.
There is nothing on log file that could explain the issue.
Only error logged is fixed on V7.3.4 and has no effect on planning.
Hi,
I had a llok a latet planning.
It is a "resource planning" view.
Does this issue occurs only for some resources ?
Can you post screenshot of resource definition.
If this resource is the one used on fist print, behavior is normal.

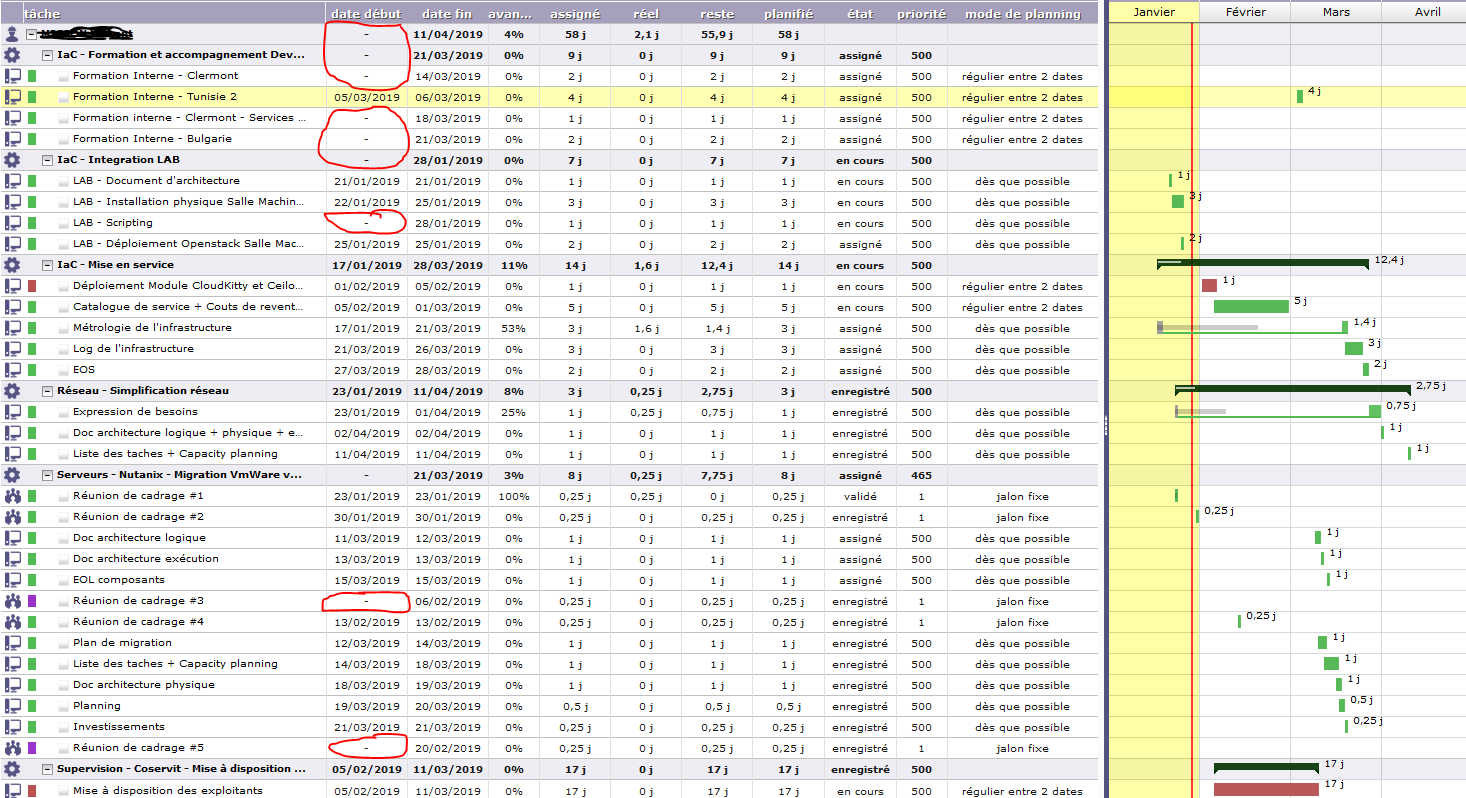

Resource is allocated to the corresponding project from 21/01/2019 to 08/03/2019
So this ressource cannot be planned of an activity "regular between dates" from 13/03/2019 to 14/03/2019.
Many thanks babynus. Everything works perfectly !
Evolution : is it possible to have a message when task can't be planned (with explanation) ?
If fact, it exists when planning cannot be "finished".
In your case, it cannot be even "Started".
We'll have a look to improve this to get message in both case (Ticket #3822).
