[SOLVED] How to detect surcharge on the same task?

9 Posts
2 Users
0 Reactions
7,389 Views
Martin
(@el-wallos)
Posts: 220
Active Member
Topic starter

[#2661]

Hi

How can I check if one ressource is assigned on two different tasks at the same time (100%)?

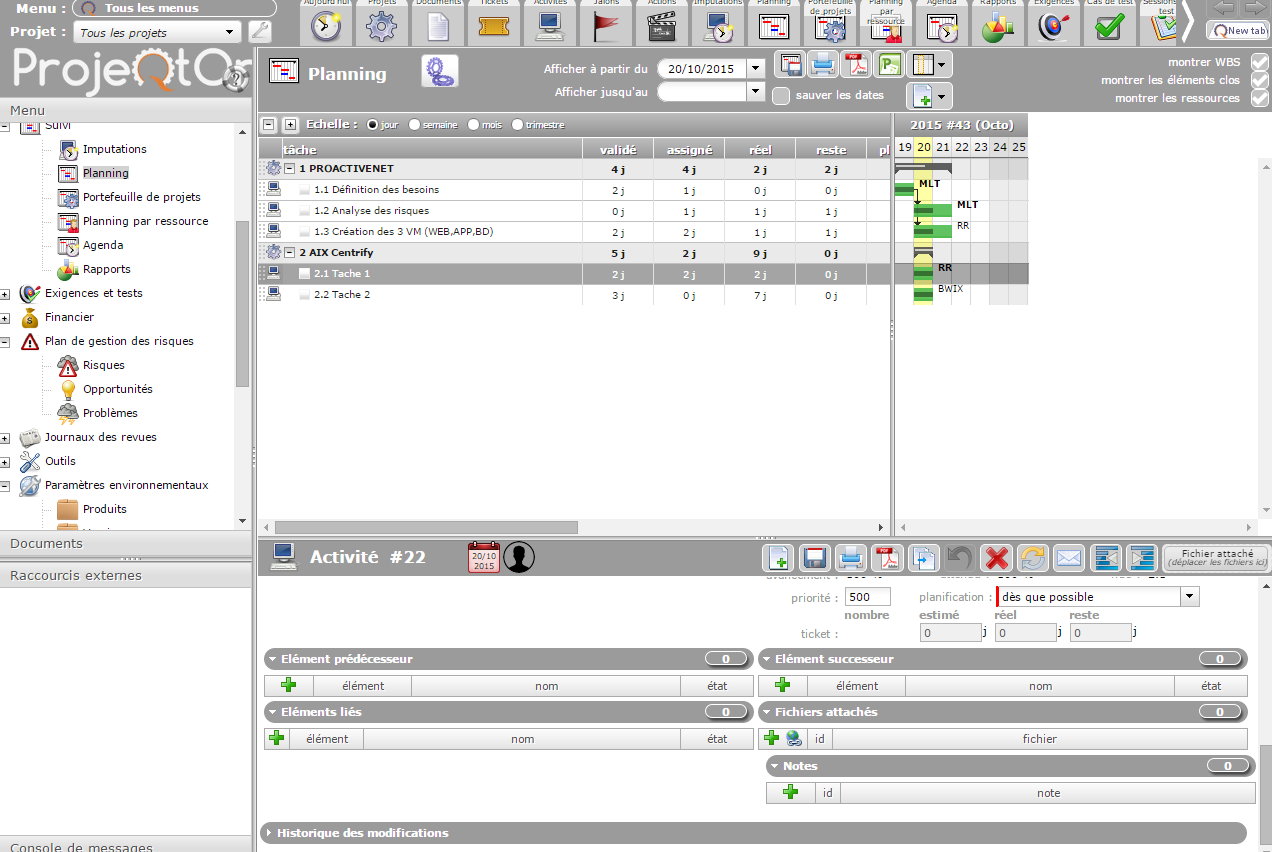

For example, RR is assigned on two projects the same day (20 Oct 2015) and no alert is displayed, so what is the way to detecte it?

Martin



Posted : 20 Oct 2015 18H14
Martin
(@el-wallos)
Posts: 220
Active Member
Topic starter


Sorry for my english, the question was:

How to detect overload on the same ressource?



Posted : 20 Oct 2015 19H05
(@babynus)
Posts: 14952
Member Admin


How can I check if one ressource is assigned on two different tasks at the same time (100%)?
For example, RR is assigned on two projects the same day (20 Oct 2015) and no alert is displayed, so what is the way to detecte it?

There is no alert because it is not an issue : resource can be affected on same period on several projects, and total affectation can be more than 100%.
You can see affectation summary on resource screen.

How to detect overload on the same ressource?

There is not overload of resource in ProjeQtOr planning !!!
If resource is planned on 2 tasks that should come same day then one of the two is extended on following days (witch is delayed depends on priority of tasks, have a look at priority in planning calculation in the user manual).



Posted : 21 Oct 2015 11H51
Martin
(@el-wallos)
Posts: 220
Active Member
Topic starter


Thanks Babynus, right now, it is more clear for me.

What's happen if the two activities have the same priority? ProjeQtOr choses one with "random logic" to plan?



Posted : 21 Oct 2015 12H20
(@babynus)
Posts: 14952
Member Admin


What's happen if the two activities have the same priority? ProjeQtOr choses one with "random logic" to plan?

Default priority is WBS order.



Posted : 21 Oct 2015 12H24
Martin
(@el-wallos)
Posts: 220
Active Member
Topic starter


Thanks Babynus,

Have a good day



Posted : 26 Oct 2015 11H19
Martin
(@el-wallos)
Posts: 220
Active Member
Topic starter


What's happen if the two activities have the same priority? ProjeQtOr choses one with "random logic" to plan?

Default priority is WBS order.

What's happen if the two activities are on different project and have the same priority?



Posted : 29 Oct 2015 11H41
(@babynus)
Posts: 14952
Member Admin


Always WBS order.



Posted : 30 Oct 2015 10H59
Martin
(@el-wallos)
Posts: 220
Active Member
Topic starter


Perfect, thanks



Posted : 30 Oct 2015 11H25
