About Calculate Capacity Planning

5 Posts
3 Utilisateurs
0 Reactions
1,669 Vu
 Erki
(@kiroglu)
Posts: 13
Active Member
Début du sujet

[#7569]

Hello,

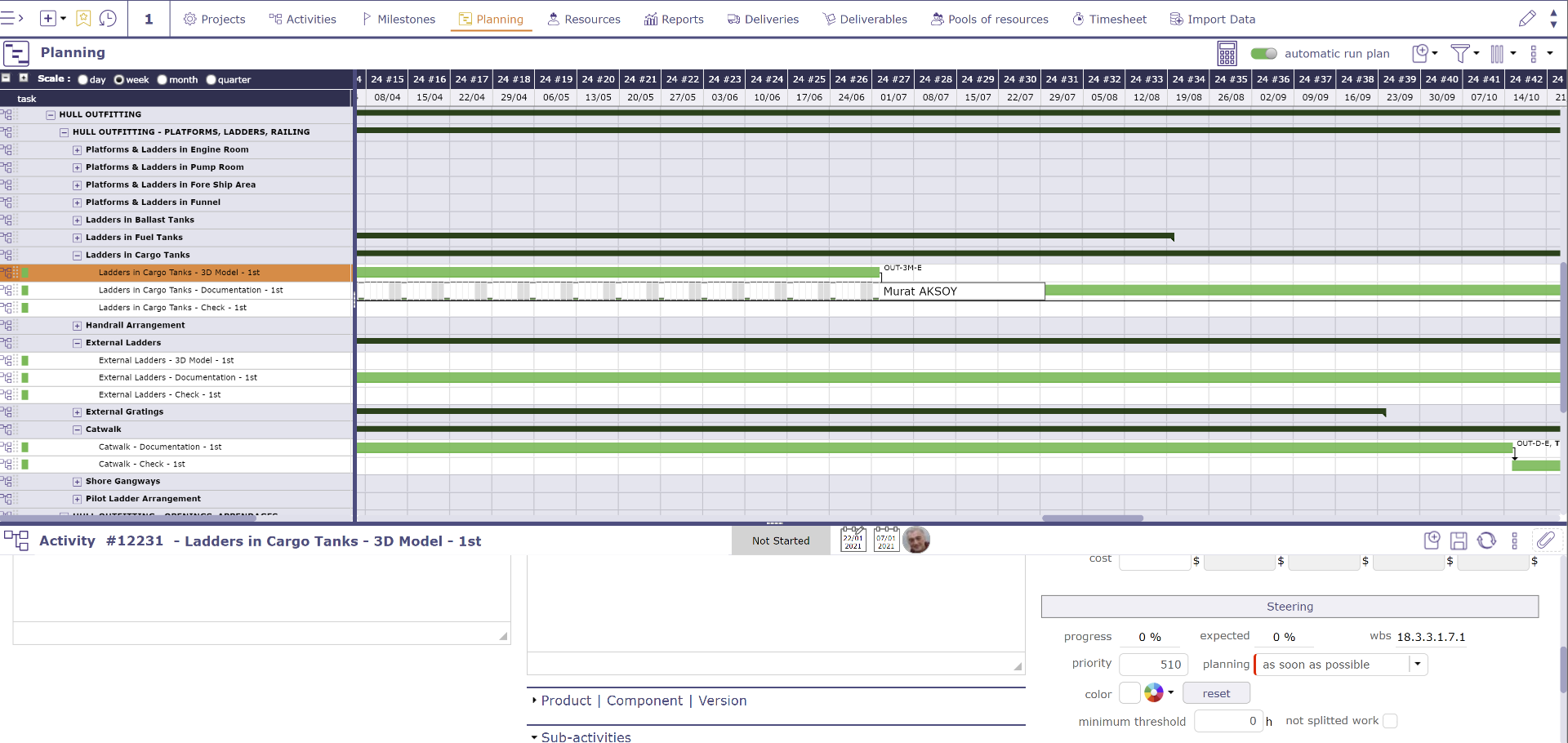

I wonder why lots of activities are being fragmented like in the screenshot attached?
Thanks.




Posté : 4 Juin PM 14:066
Flou
 Flou
(@flou)
Posts: 253
Active Member


Hello,

your resource is possibly planned for other activities, therefore it is only available on its dates.



Posté : 7 Juin PM 14:066
 Erki
(@kiroglu)
Posts: 13
Active Member
Début du sujet


Hello,
All resource allocations are being handled by Projeqtor, therefore if there are already tasks during the same period of a resource, they may be trimmed by the Projeqtor and the new ones are replaced into the trimmed areas. In reality, no one repeatedly works just an hour in a week for an activity of a project.
Can it be a constraint of Projeqtor's algorithm that attempts to make the activity finish according to "as soon as possible" rule?

Thanks in advance.



Posté : 7 Juin PM 15:066
Flou
 Flou
(@flou)
Posts: 253
Active Member


Yes, it is possible that this is the "as soon as possible" planning mode causing the resource to be planned like this. There is the allocation of the resource to the project, the capacity  and calendar  of the resource which can contribute to this result.



Posté : 9 Juin PM 14:066
(@babynus)
Posts: 14952
Membre Admin


Is seems your resource is allocated to project with a very low allocation rate.
Try and set it to 100% to see changes.



Posté : 12 Juin PM 20:066
