Hello,

In this exemple, some activity is cut.

Why "Reprise des fichiers" has charge on tuesday and thursday?

There is only one ressource at 70% on the project. The activity "Développement PGM transco" is the predecessor of "tests unitaires pgm transco".

Others, "Reprise" and "Modification CL", have no predecessor.

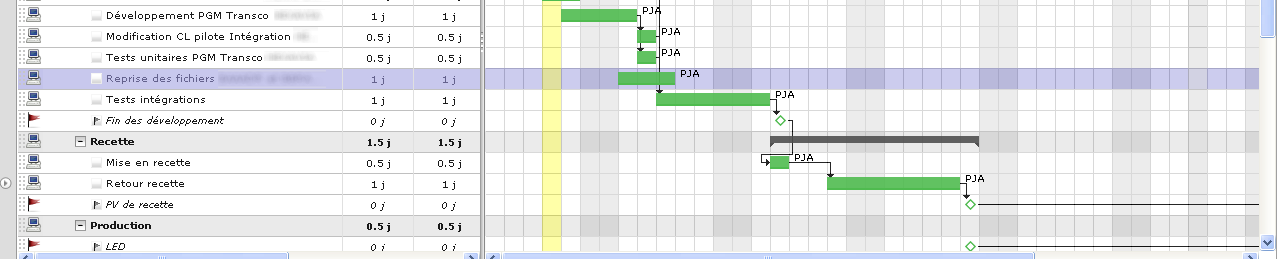

This is the planning:

Thank you for your help,

Drubs2010.

Posté : 21 Nov PM 19:1111
(@babynus)
Posts: 14952
Membre Admin

Could you give information about priority of the activities ?
It they are all the same, then planning seems normal, priority if given by WBS.

So "Développement PGM transco" is planned =>OK
Then "Modification CL" is planned, but cannot start on the sale day because of predecessor constraint.
Then "tests unitaires pgm transco" is planned => OK
Then "Reprise des fichiers" is planned. And as it has no constraint, it used the availability left on tuesday.

If you want to avoid this behavior, you must allow your task "Modification CL" to start same day as predecessor : set delay to -1 in the dependency definition.

Posté : 22 Nov AM 02:1111
(@drubs2010)
Posts: 25
Active Member
Début du sujet

Thank you for this tip.

Regards,

Drubs2010.
