how to calculate %avancement of my project
thanks
ProjeQtOr is work driven.

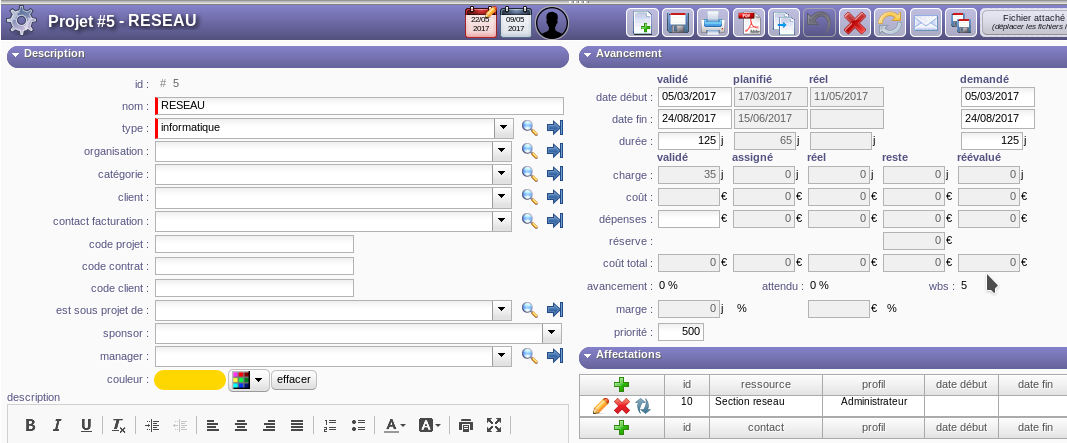

So progress is automatically calculated from work.
On project, add activities.

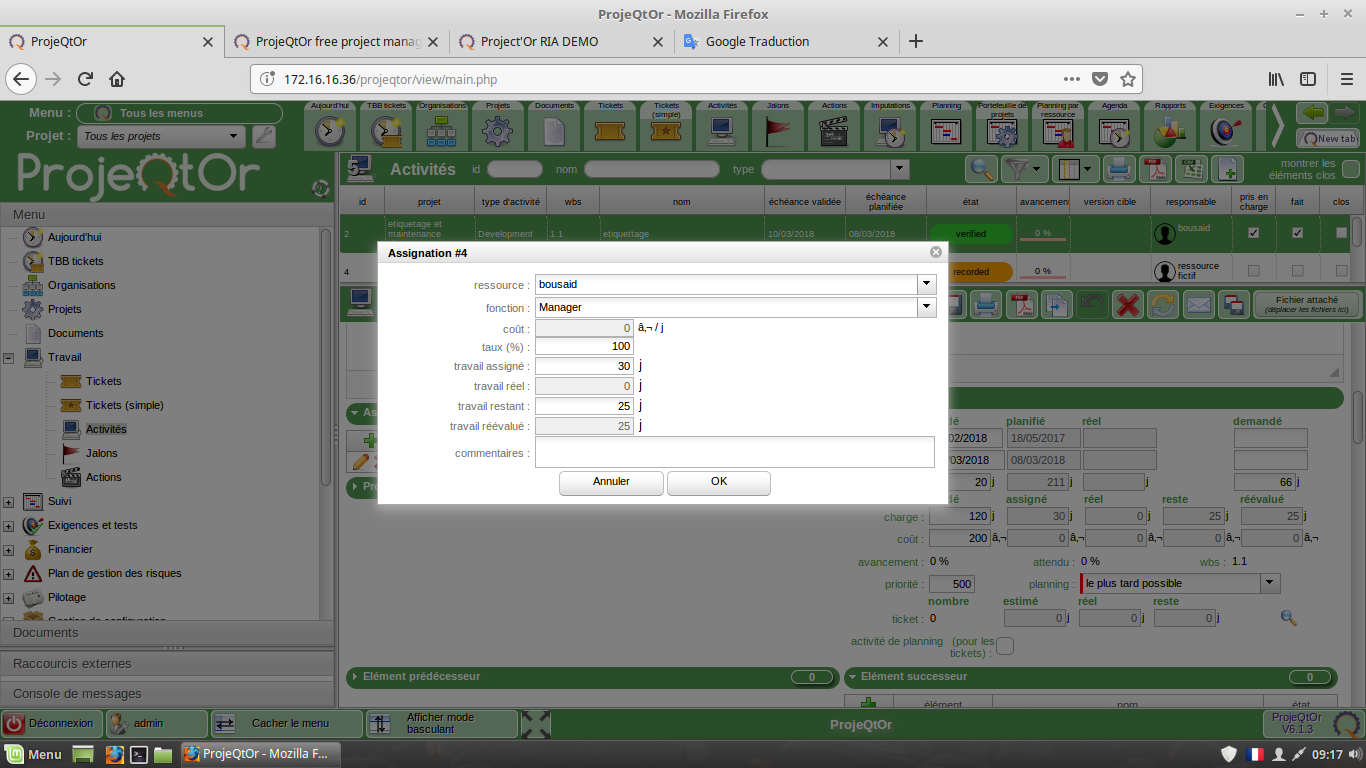

On activities, assign resources (who will work) with assigned work (how much work days to execute the task).
Then resource enters real work in the real work allocation screen.

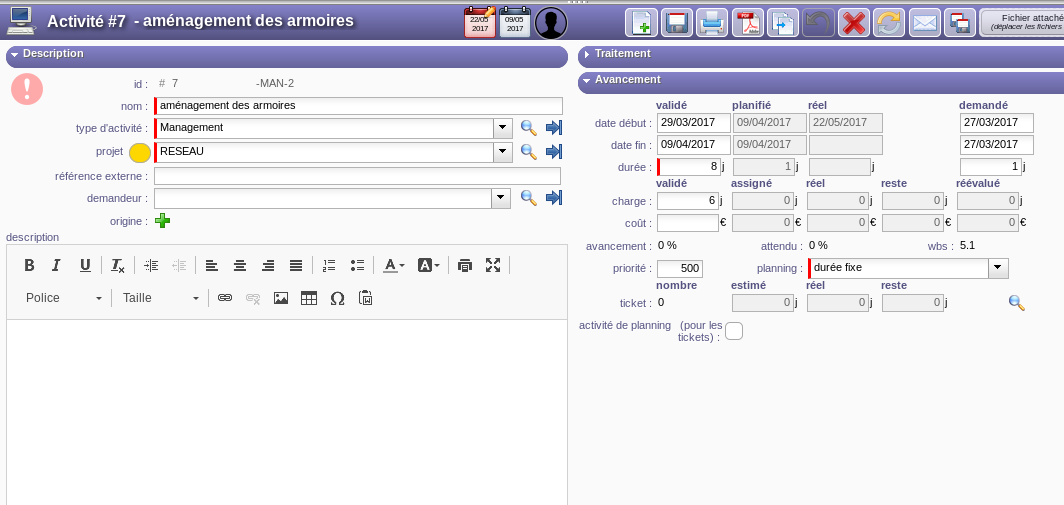

Project progress is then automatically calculated.
Create activity is not enough.
You have to assign work for resources to activities.
Then run planning calcuation.
HI
i can't put real date to my project and activities
thank you
Real dates directly come from Real Work input
(of from item lifecycle for activitites without work)

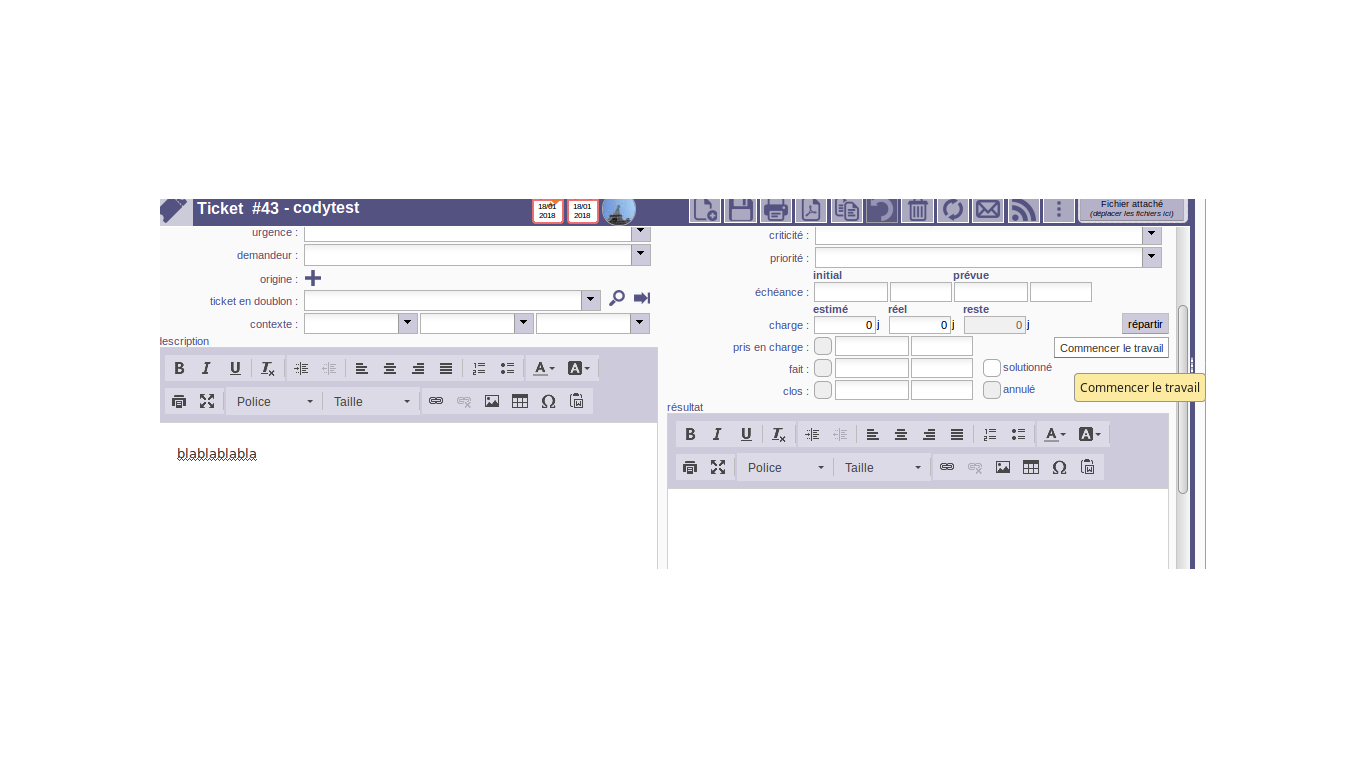

Real Work can only been entered on Real Work Allocation screen.
If you don't see the button, it means you don't have rights to enter work on ticket.
For instance, if global parameters are set so that "only responsible can enter work on ticket", if you are not responsible of the ticket, you cannot enter work.
Also if you're a user and not a resource, you cannot enter work.
