in first I'm sorry for my bad english
my problem is: some responsable of activirty do not folow their tasks on projeQtor (n'ont pas fait les mises à jour à temps) and when dates of end is passed , all the teem (manager and sponsor) can't move status of project and activity .
how must they do (que faut il faire pour debloquer la situation)
think you.
Constraint on status change is due to workflow definition.
Try and change your workflows so that for instance project manager can always change status.
workflow is definied and affected correctly
but the problem is occured only when date of end is passed
There is no treatment that would have impact depending on end date passed or not.
Coul you show print screen ?
Check access rights.
Sponsor has no default rights to update a project.
All depends on PRofile of connected user.
You defined some access mode "superviseur" and some profile with same name "superviseur".
To understand, please show access rights to screen Project for profile "Superviseur"

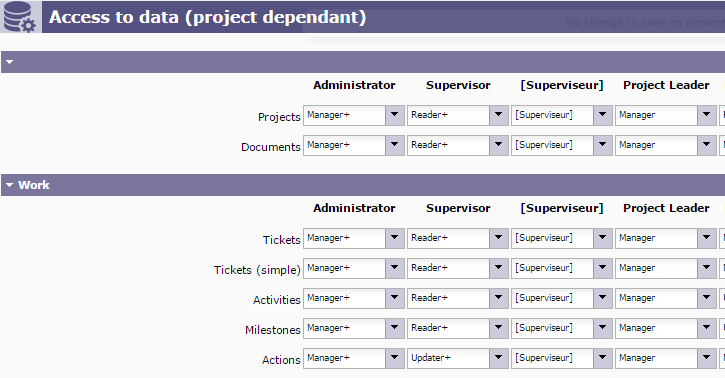

Sorry, was not clear, what I need to see is screen "Accès aux données (dépendant du projet)".
Just one print showing colomn "Superviseur" and line "Projets"
I cannot reproduce with configuration looking like yours.
He is what I did (On Demo).
Create new profile Superviseur

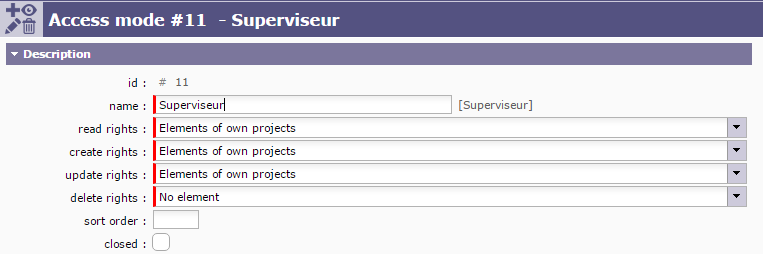

Create new Access Mode Superviseur

Set access to forms to Superviseur profile
Set access to data with access mode Superviseur to Superviseur profile

In workflow default, define access so that Superviseur profile has rights to change status

Create user superviseur with profile Superviseur (in fact it already existed, I just changed profile)

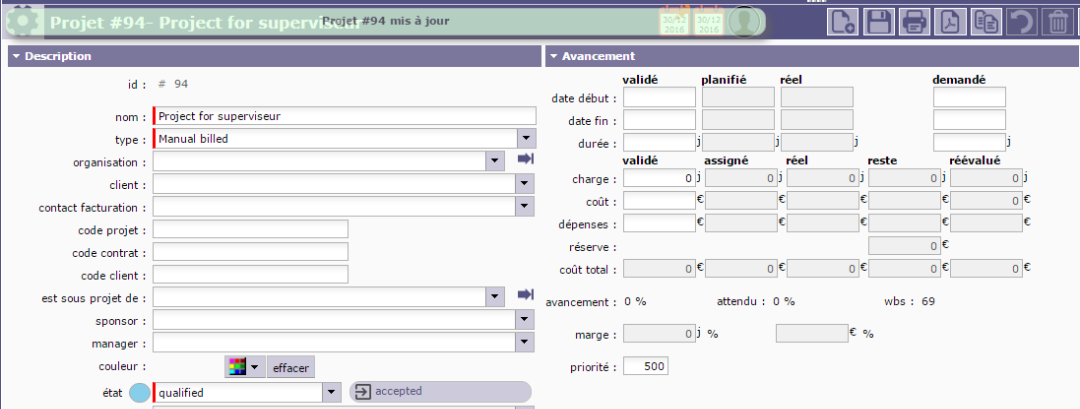

Create new project and allocate Superviseur to this project
Then connect as superviseur,
Go to new project,

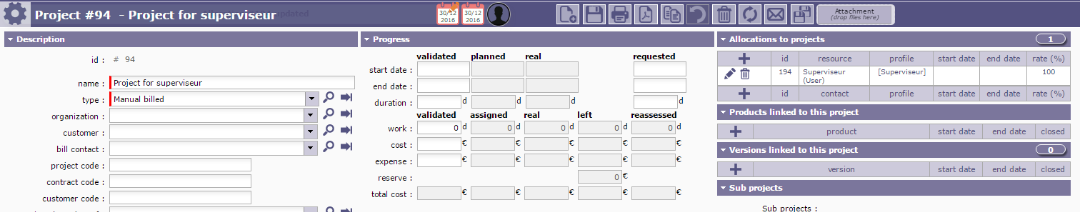

And change Status
So sure all works fine.
You can try on demo.projeqtor.org, with user superviseur/superviseur.
