manual planning & planning calculation

6 Posts
2 Users
0 Reactions
1,632 Views
(@vba)
Posts: 16
Active Member
Topic starter

[#8057]

Hello team.

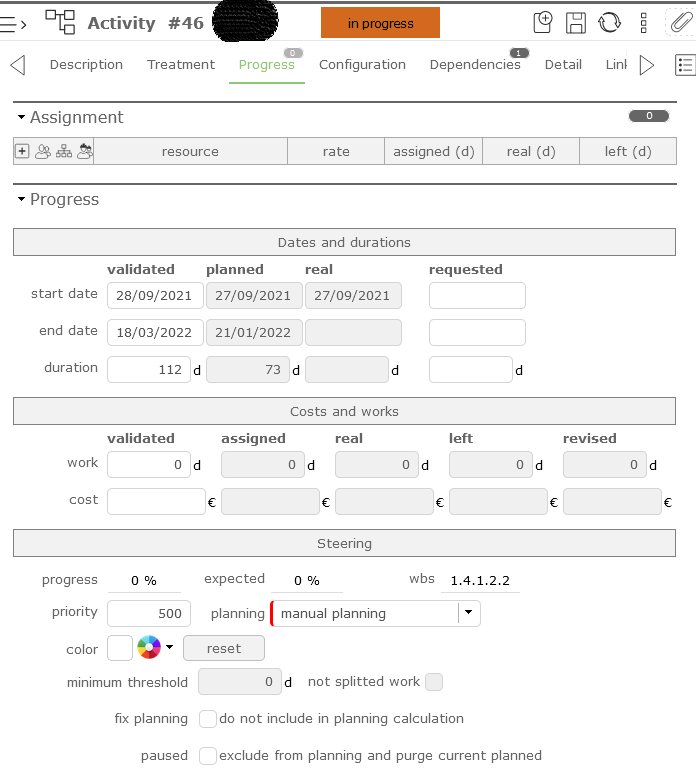

I'm trying to adjust end date of a manual planed task.
There is no assignement, the predecessor is closed, and i do not modify the start date, only the end date to adjust duration.
I ran planning calculation. Others task correctly adjusted but not this one.
AFAIK there are not other constraints on this task.

Is there any way to view some sort of calculation trace to see what could be the cause?
Thank you for your great support



Posted : 31 Jan 2022 18H18
(@marylene)
Posts: 592
Contributor Admin


Hello,

Manual planning, as its name suggests, is planned exclusively by hand and takes priority over all other planning modes even without any constraint.

To modify the planned dates in this mode, edit the assignment on the activity or go to the "planned interventions view" screen to view and modify the assignments.

The schedule calculation will never modify your schedule in this mode.



Posted : 01 Feb 2022 11H12
(@vba)
Posts: 16
Active Member
Topic starter


Thank you for your reply and help.
Does this mean an assignment is mandatory to a manually planned task?
I just would like to manually set start date and end date to this task which represent a given period of time, but with no assignment on it.



Posted : 01 Feb 2022 11H49
(@marylene)
Posts: 592
Contributor Admin


yes, there is no point in working without assignment and assigned workload for the manual planning mode.

the "fixed duration" planning mode should work for you.



Posted : 01 Feb 2022 11H58
(@vba)
Posts: 16
Active Member
Topic starter


Thank you for you reply.
Unfortunately the only way to modify duration -- and end date -- in my case was to drag the bar on the gantt chart. And this, whatever scheduling options i choosed. Then, the dates within the activity, and the gantt reflected correctly the given date/duration.

btw, thank you again for your support.



Posted : 07 Feb 2022 17H12
(@marylene)
Posts: 592
Contributor Admin


I'm not sure why this would be the only solution, but you can drag the bar of an activity in "fixed duration" planning mode directly onto the Gantt.



Posted : 08 Feb 2022 11H35
