[#3044]

Hi...
Is it possible to enter planning in hours instead of days?
Thanks



Posted : 14 Feb 2016 16H45
(@babynus)
Posts: 14952
Member Admin


Yes.

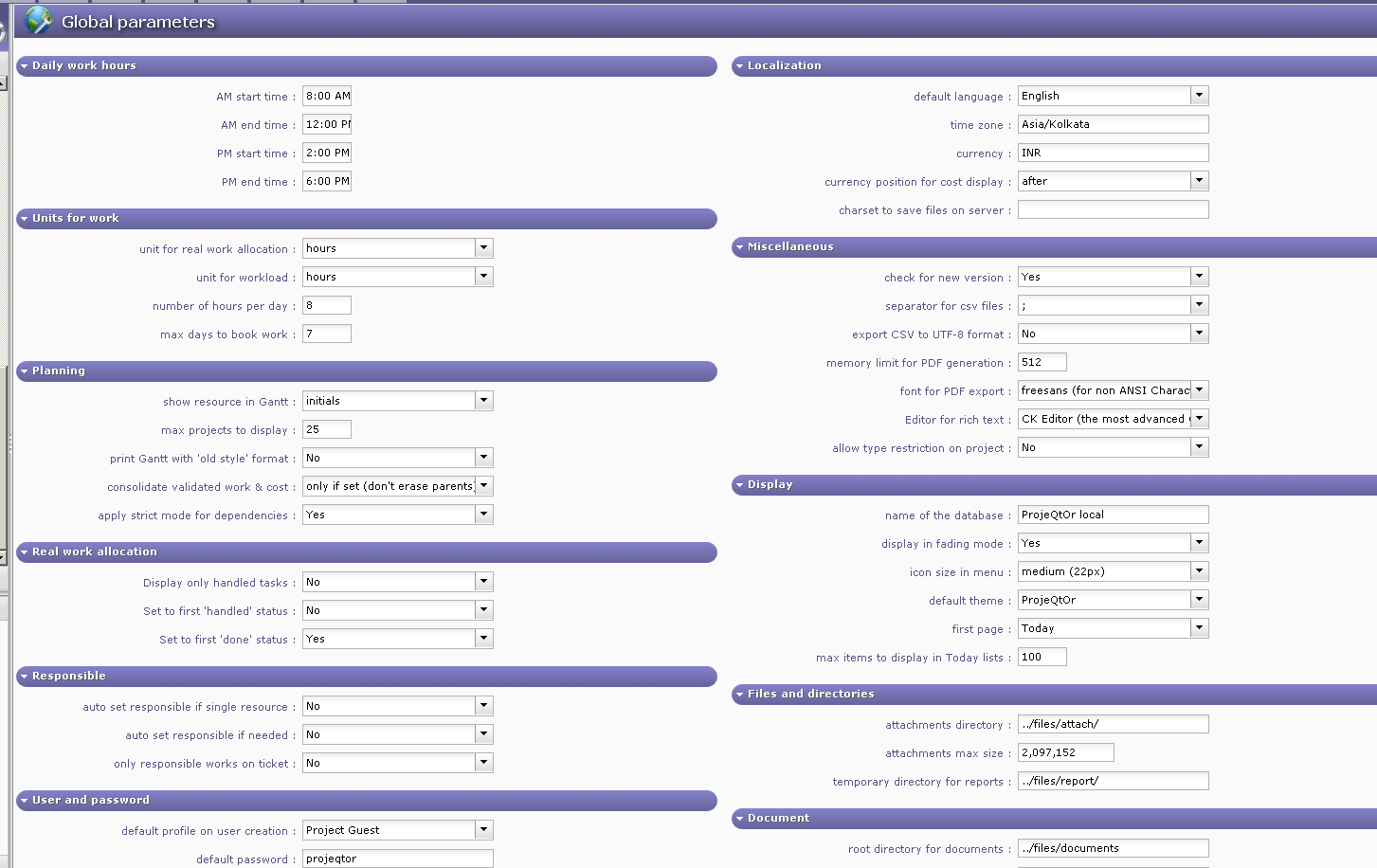

Change unit in Global parameters.



Posted : 14 Feb 2016 17H53
 biju
(@bijugeo)
Posts: 7
Active Member
Topic starter

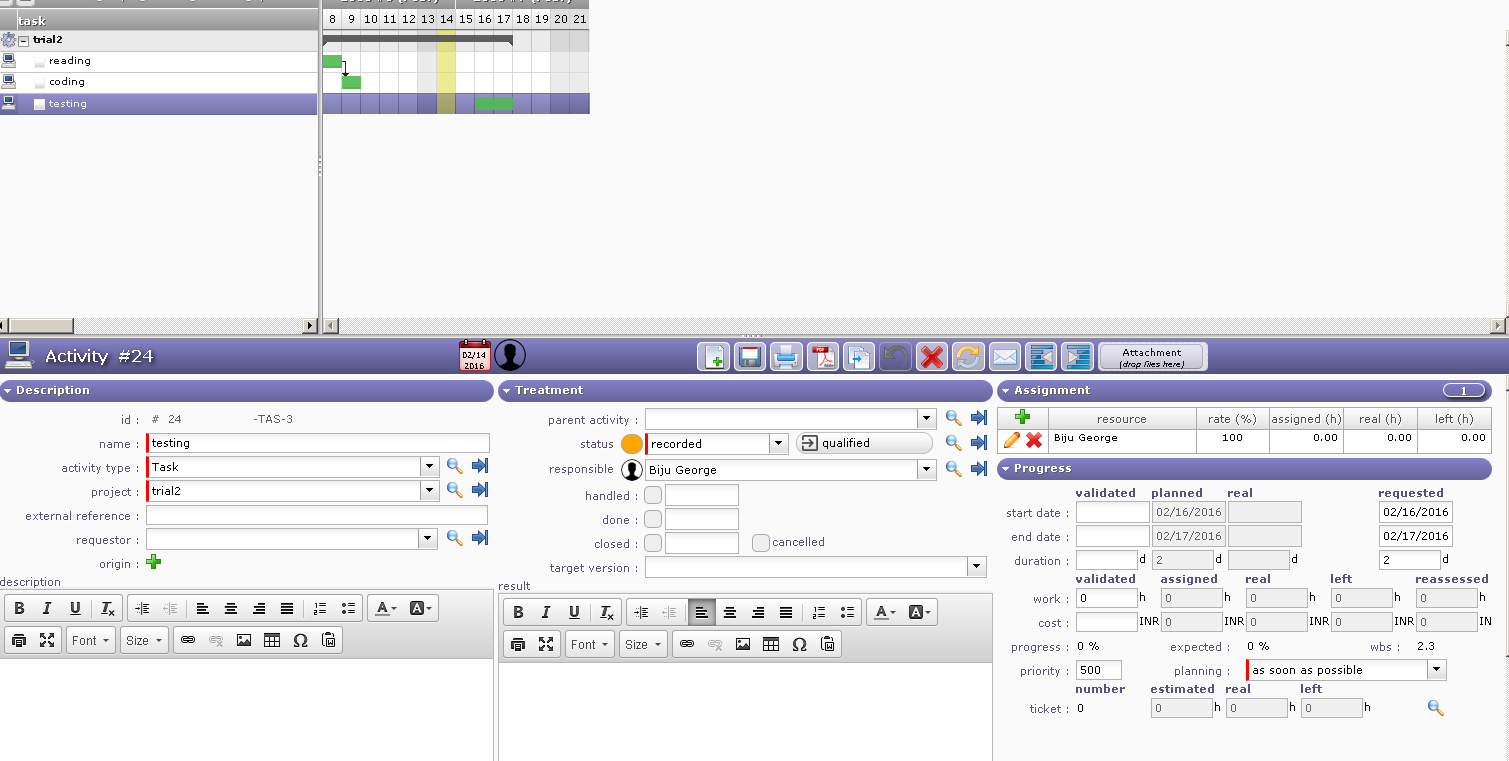

I changed it to hours in parameters. still in activity planning is in days.
Thanks



Posted : 14 Feb 2016 18H30
(@babynus)
Posts: 14952
Member Admin


duration is still in days (this will never change).
work is correctly in hours.



Posted : 14 Feb 2016 18H44
 biju
(@bijugeo)
Posts: 7
Active Member
Topic starter


My activities are of short duration... I dont want to club the activities together.
Any suggestions?



Posted : 14 Feb 2016 19H09
(@babynus)
Posts: 14952
Member Admin


Pay attention : planning very small activities (< 1 day) can be much time consuming.
You may spend more time planning activities than working on them...

But you can plan.
Duration will be 1 day (the smallest in ProjeQtOr) but work can be less.
(don't forget that projeqtor is work driven)
In that situation, you should take care to define "apply strict mode for dependencies" to false



Posted : 14 Feb 2016 19H26
