Hi,

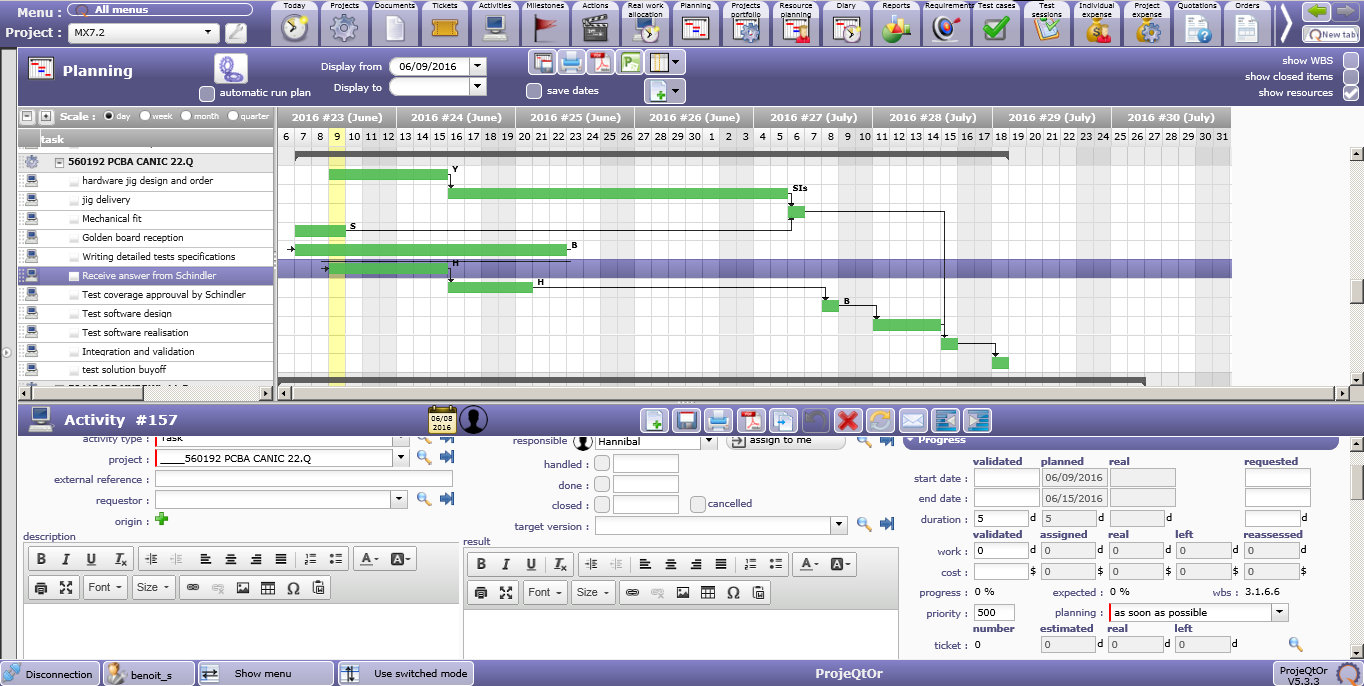

I have a little problem with the task and dependency calculation. I'll add the screenshot. it might help you to understand what I mean.
My problem is that the starting date is always the planning date and not the real flow. and it,s not possible to modify the planned date.
How can i make my project calculate the starting date of every task with the end of the predecessor.

Thanks

Benoit


Benoit


Posté : 9 Juin AM 05:066
(@babynus)
Posts: 14952
Membre Admin


Define some work on each activity (add assignement with assigned work) or set planning mode to "fix duration".
Then run planning calculation.



Posté : 9 Juin AM 10:066
