Hi,
We are currently having an issue, here's the situation :
We have a collegue who badly entered his hours on an activity (he entered multiple days) this cause the entire planning (every next acitivtys) to be shifted because of this bad imputation.
This is very blocking for us
Regards
Sorry, I don't understand what is blocking.
If input is incorrect, just fix the input...
Because of the bad imputation my collegue entered,
The real time on this imputation is now 35,00 hours instead of 7
When whe are using the planning calculator the planified date changes because of that (in the example : 24/09/2019)

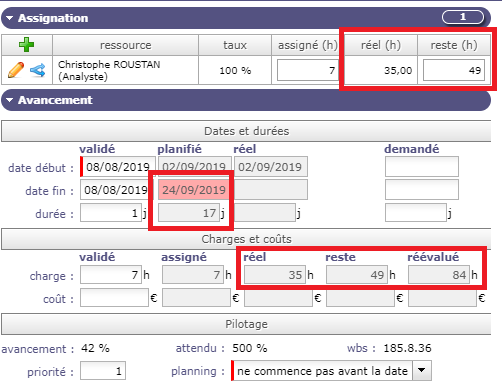

As you can see on the screenshot, we are unable to modify these values neither on the activity nor on the imputation.
Sorry if i'm not explaining very well, I'm doing my best but I'm not sure to understand everything either ...
Issue on planning is due to left 49h work.
You can set this to zero on activity screen.
No more work will need to be replaned so planned end date will be real end date, which is the laste date of input of work in Timesheet.
You must change real work on Timesheet screen.
If it is lock, it should be because Week is submitted or validated. Unvalidate / unsubmit the week to change data.
