progress of an activity how to inform the progress of an activity I have read a

10 Posts
3 Users
0 Reactions
3,669 Views
(@chaours)
Posts: 45
Active Member
Topic starter

[#7686]

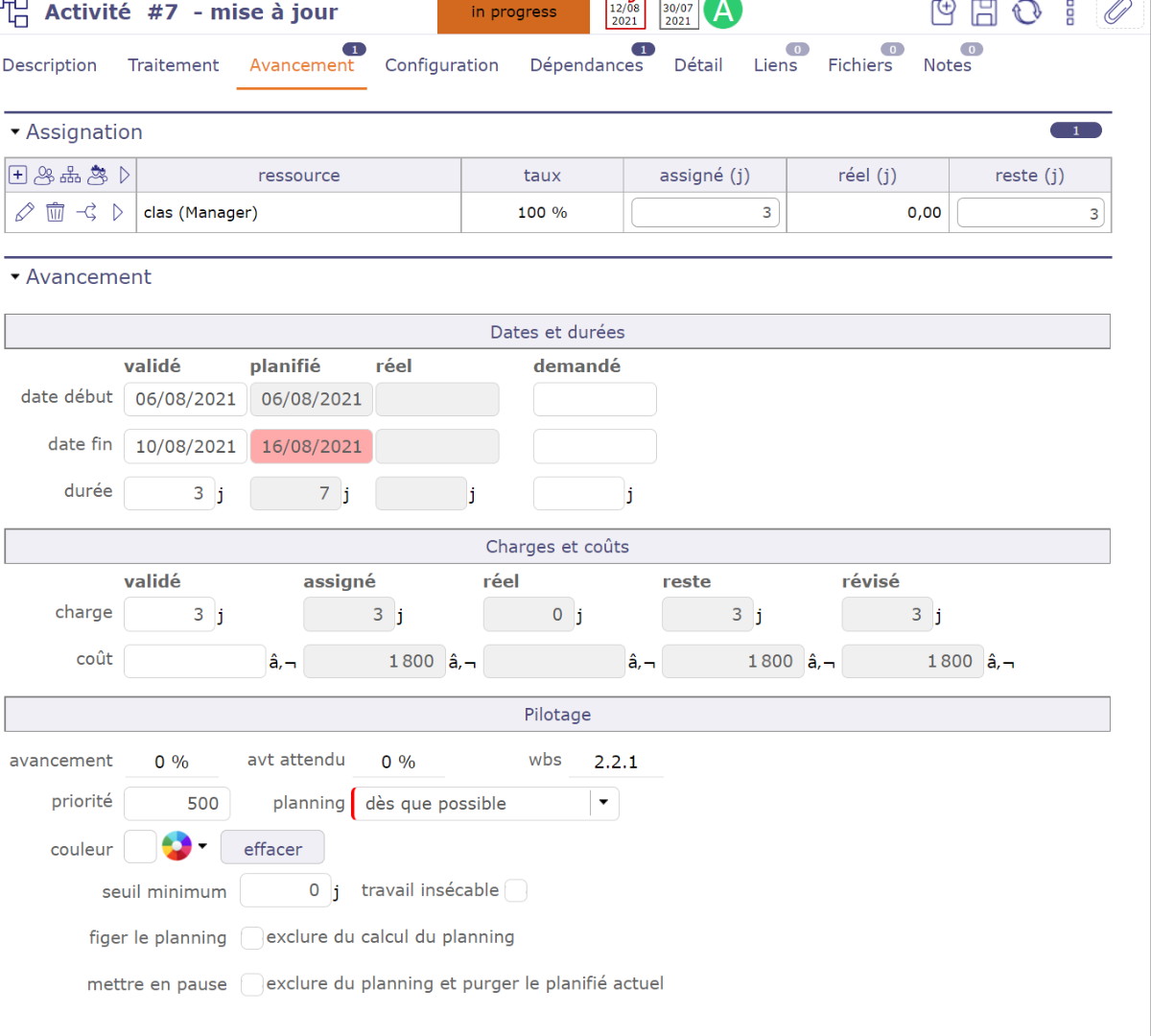

progress of an activity how to inform the progress of an activity I have read and reread the manual I can only find descriptions of the panels but I cannot understand how to inform in the steering section the percentage of progress ...? Thanks for your feedback.
****
progres d'une activité

comment faire pour renseigner le progres d'une activité j'ai lu et relu le manuel je ne trouve que des description des panneaux mais je n'arrive pas à comprendre comment renseigner dans la section pilotage les pourcentage d'avancement ... ? merci pour votre retour.



Posted : 12 Aug 2021 19H09
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


Projeqtor is work driven (effort driven) : when you enter real work, progress is updated.
You can also activate "manual progress for fix duration activities" is global parameters if you don't want to manage real work



Posted : 12 Aug 2021 19H36
(@chaours)
Posts: 45
Active Member
Topic starter


ok thanks but it's grayed out in the real box

ok merci mais c'est grisé dans la case réel



Posted : 12 Aug 2021 19H51
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


Real work must be entered through timesheet



Posted : 12 Aug 2021 20H02
(@chaours)
Posts: 45
Active Member
Topic starter


thank you for this feedback, and "manual progress for fix duration activities" where should we enter it?

***

merci pour ce retour, et "manual progress for fix duration activities" où doit on le rentrer ?



Posted : 12 Aug 2021 20H15
(@alain-fourastie)
Posts: 366
Active Member Moderator


global parameters / activity / planning / The fourth line.



Posted : 13 Aug 2021 11H10
(@chaours)
Posts: 45
Active Member
Topic starter


yes thank you that I found it, no actually I wanted to talk about the percentage of completion

***

oui merci ça je l'avais trouvé, non en fait je voulais parler des pourcentage d'avancement



Posted : 13 Aug 2021 12H26
(@alain-fourastie)
Posts: 366
Active Member Moderator


it is donne automaticly depending on real work and left work (revisable)

DONE WORKLOAD / (DONE WORKLOAD + LEFT WORK ) = REAL PROGRESS
simple as ABC.
so this rate could be fluctuant.



Posted : 13 Aug 2021 12H39
(@chaours)
Posts: 45
Active Member
Topic starter


I often see "left work" written, but what is it?
PS: where does the real work fit? at home the box is grayed out ... thank you

***

je vois souvent écris "travail de gauche" mais de quoi s'agit il ?
PS : où se rentre le travail réel ? chez moi la case est grisée...merci



Posted : 13 Aug 2021 12H43
(@alain-fourastie)
Posts: 366
Active Member Moderator


enter some real work on a line in timesheet.  leftwork will  especially decrease.
you can change manually this leftwork.
this left work will be planified each time you use the calculation
it is endless until the leftwork is zero
Always plan as the day.



Posted : 13 Aug 2021 13H26
