Forum

Welcome to ProjeQtOr new Forum. We migrated old forum to the new website.
You will find all your posts here, with your usual account.
Just one point : you’ll have to reinitialize your password. Use “Lost password” feature.

[SOLVED] Actions in...

Notifications
Clear all

[SOLVED] Actions in Global Plannig

11 Posts
3 Users
0 Reactions
2,931 Views
(@pdecloedt)
Posts: 166
Active Member
Topic starter

[#9310]

Hello,

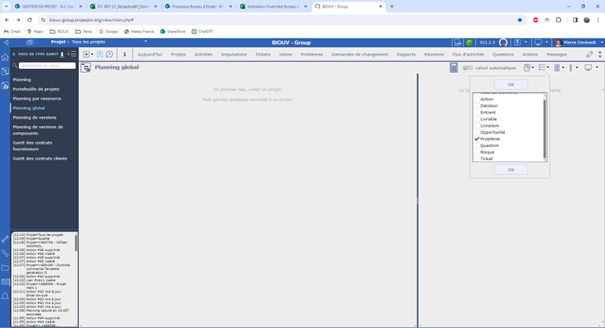

on the Global planning, I cannot see the Action in Global Planning Gantt ?
is it normal ?




Posted : 13 Feb 2024 14H13
(@pdecloedt)
Posts: 166
Active Member
Topic starter


nothing display... ???





Posted : 13 Feb 2024 14H24
(@pdecloedt)
Posts: 166
Active Member
Topic starter


on my previous local database (on V11.1.2) it's works... but on the actual database (V11.1.3) it does not work



Posted : 13 Feb 2024 14H37
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


Check for errors in log file.
Possibly you have to setup or change $paramDbCollation in parameters.php



Posted : 15 Feb 2024 12H42
(@pdecloedt)
Posts: 166
Active Member
Topic starter


when I'am on Global planning view and I click on "show Actions" box, look the log files:
2024-02-15 12:04:00.084 ** ERROR ** [V11.1.3] Exception-[42000] SQLSTATE[42000]: Syntax error or access violation: 1253 COLLATION 'utf8_general_ci' is not valid for CHARACTER SET 'utf8mb4'
2024-02-15 12:04:00.084 ** ERROR ** [V11.1.3] For query : SELECT planningelement.*
FROM
( SELECT cast(id as CHAR) COLLATE utf8_general_ci as id,color,idProject,cast(refType AS CHAR) COLLATE utf8_general_ci as refType,refId,refName,topId,topRefType,topRefId,
priority,elementary,idle,done,cancelled,idPlanningMode,idBill,
initialStartDate,validatedStartDate,validatedStartFraction,plannedStartDate,plannedStartFraction,realStartDate,
initialEndDate,validatedEndDate,validatedEndFraction,plannedEndDate,plannedEndFraction,realEndDate,
latestStartDate,latestEndDate,
initialDuration,validatedDuration,plannedDuration,realDuration,
initialWork,validatedWork,assignedWork,plannedWork,leftWork,realWork,
validatedCost,assignedCost,plannedCost,leftCost,realCost,
progress,expectedProgress,wbs,wbsSortable,isOnCriticalPath,notPlannedWork, needReplan,
null as idType, null as idStatus, null as idResource, 0 as isGlobal , null as paused
FROM planningelement
WHERE ((planningelement.idProject not in (0) or planningelement.idProject is null ) and (planningelement.idProject not in (0) or planningelement.idProject is null or (1=4) ) and (planningelement.idProject not in (0) or planningelement.idProject is null or (1=3) ))
UNION
SELECT coalesce(cast( (pex.id+1000000000) AS CHAR) COLLATE utf8_general_ci,concat('Action','_',action.id)) as id, null as color, action.idProject as idProject, cast('Action' AS CHAR) COLLATE utf8_general_ci as refType, action.id as refId, action.name as refName, null as topId, 'Project' as topRefType, action.idProject as topRefId,
'N/A' as priority, 1 as elementary, action.idle as idle, action.done as done, action.cancelled as cancelled, 8 as idPlanningMode, 'N/A' as idBill,
'N/A' as initialStartDate, 'N/A' as validatedStartDate, 0 as validatedStartFraction, action.actualDueDate as plannedStartDate, 0 as plannedStartFraction, action.handledDate as realStartDate,
'N/A' as initialEndDate, action.initialDueDate as validatedEndDate, 1 as validatedEndFraction, action.actualDueDate as plannedEndDate, 1 as plannedEndFraction, action.doneDate as realEndDate, 'N/A' as latestStartDate, 'N/A' as latestEndDate,
'N/A' as initialDuration, 1 as validatedDuration, 'N/A' as plannedDuration, 'N/A' as realDuration,
'N/A' as initialWork, 'N/A' as validatedWork, 'N/A' as assignedWork, 'N/A' as plannedWork, 'N/A' as leftWork, 'N/A' as realWork,
'N/A' as validatedCost, 'N/A' as assignedCost, 'N/A' as plannedCost, 'N/A' as leftCost, 'N/A' as realCost,
'N/A' as progress, 'N/A' as expectedProgress, coalesce(pex.wbs,concat(pe.wbs,'._#',action.id)) as wbs, coalesce(pex.wbsSortable,concat(pe.wbsSortable,'._#',action.id)) as wbsSortable, 'N/A' as isOnCriticalPath, 'N/A' as notPlannedWork, 'N/A' as needReplan, action.idActionType as idType, action.idStatus as idStatus, action.idResource as idResource, 1 as isGlobal, 'N/A' as paused
FROM action LEFT JOIN planningelement AS pe ON pe.refType='Project' and pe.refId=action.idProject LEFT JOIN planningelementextension as pex ON pex.refType='Action' and pex.refId=action.id WHERE ((action.idProject not in (0) or action.idProject is null ) and (action.idProject not in (0) or action.idProject is null or (action.idResource=3) ) and (action.idProject not in (0) or action.idProject is null or (action.idUser=3) )) and action.idProject not in (0)) as planningelement
WHERE planningelement.idle=0 and (1=1) and ( (planningelement.idProject in (0, 2, 38, 35, 36, 83, 85, 86, 92, 93, 99, 104, 105, 113, 117, 118, 120, 122, 124, 125, 126, 127, 128, 133, 134, 135, 137, 138, 139, 142, 152, 153, 154, 159, 167, 168, 169, 174, 176, 177, 182, 183, 184, 185, 186, 187, 190, 193, 197, 202, 203, 204, 210, 214, 220, 222, 223, 224, 228, 227, 229, 230, 242, 243, 247, 256, 257, 258, 265, 266, 269, 275, 276, 277, 278, 282, 296, 297, 304, 309, 318, 319, 320, 321, 325, 327, 328, 335, 336, 337, 341, 342, 349, 356, 360, 361, 373, 375, 383, 389, 392, 394, 397, 398, 400, 411, 414, 415, 416, 417, 426, 427, 428, 440, 442, 443, 444, 445, 446, 449, 450, 456, 457, 460, 462, 466, 469, 480, 481, 493, 499, 500, 504, 505, 508, 510, 511, 514, 516, 519, 520, 521, 522, 523, 526, 541, 542, 543, 550, 555, 556, 560, 561, 563, 566, 581, 582, 585, 590, 591, 595, 601, 602, 603, 604, 609, 610, 611, 612, 615, 622, 623, 624, 625, 626, 627, 628, 629, 631, 634, 635, 636, 637, 641, 642, 647, 652, 656, 657, 658, 659, 660, 661, 662, 666, 667, 673, 676, 683, 685, 686, 687, 688, 689, 844, 692, 694, 697, 714, 722, 726, 728, 729, 734, 743, 746, 747, 749, 752, 753, 755, 764, 766, 768, 774, 775, 781, 782, 789, 790, 791, 795, 796, 797, 798, 802, 806, 808, 809, 811, 812, 813, 817, 818, 819, 825, 828, 829, 830, 831, 846, 849, 852, 853, 856, 859, 861, 863, 864, 865, 866, 870, 874, 875, 877, 879, 881, 882, 895, 896, 899, 900, 901, 904, 911, 912, 913, 914, 915, 920, 928, 929, 930, 932, 934, 935, 940, 961, 965, 966, 967, 979, 980, 989, 991, 992, 997, 998, 1002, 1003, 1006, 1014, 1265, 1268, 1269, 1270, 1271, 1281, 1282, 1284, 1287, 1288, 1297, 1325, 37, 25, 82, 96, 89, 77, 91, 84, 97, 98, 87, 107, 114, 132, 90, 72, 71, 307, 396, 70, 170, 106, 80, 171, 81, 115, 67, 116, 66, 123, 136, 151, 141, 207, 158, 192, 198, 178, 206, 218, 201, 225, 251, 253, 165, 249, 108, 109, 208, 233, 234, 131, 173, 219, 250, 236, 252, 215, 216, 217, 231, 235, 164, 209, 63, 254, 195, 244, 245, 246, 111, 110, 274, 221, 306, 271, 261, 264, 262, 272, 273, 237, 312, 268, 305, 284, 285, 280, 354, 279, 288, 290, 291, 294, 295, 286, 298, 299, 238, 301, 323, 313, 292, 293, 347, 281, 345, 324, 338, 308, 329, 330, 344, 333, 302, 314, 339, 331, 346, 310, 311, 366, 340, 348, 343, 351, 362, 357, 194, 359, 352, 369, 368, 370, 358, 363, 372, 379, 378, 384, 387, 365, 355, 377, 376, 403, 364, 401, 390, 388, 385, 386, 380, 374, 399, 402, 391, 88, 408, 409, 404, 405, 406, 407, 470, 212, 441, 439, 59, 410, 463, 458, 454, 545, 240, 452, 451, 448, 447, 353, 475, 474, 551, 477, 473, 464, 471, 476, 395, 316, 478, 465, 491, 455, 461, 501, 490, 488, 517, 495, 393, 544, 479, 506, 513, 530, 503, 507, 518, 549, 548, 529, 565, 524, 525, 527, 494, 492, 547, 546, 564, 562, 552, 557, 571, 502, 558, 570, 588, 567, 580, 56, 57, 586, 579, 482, 584, 587, 568, 597, 583, 592, 260, 596, 613, 573, 605, 606, 467, 607, 619, 608, 617, 614, 630, 644, 653, 645, 638, 572, 632, 648, 655, 578, 663, 620, 654, 702, 711, 665, 690, 695, 684, 691, 707, 712, 717, 705, 706, 718, 674, 574, 303, 593, 594, 716, 713, 693, 723, 733, 732, 715, 704, 703, 737, 740, 730, 762, 589, 754, 576, 55, 119, 65, 69, 68, 54, 53, 731, 771, 745, 750, 425, 618, 724, 772, 751, 770, 761, 765, 776, 696, 699, 779, 780, 748, 777, 778, 773, 792, 794, 804, 803, 810, 793, 760, 788, 575, 52, 805, 51, 763, 816, 835, 827, 50, 49, 48, 47, 832, 833, 820, 839, 842, 843, 826, 735, 815, 845, 727, 821, 822, 823, 850, 834, 814, 851, 848, 878, 921, 919, 857, 880, 917, 862, 897, 876, 871, 933, 953, 954, 869, 867, 872, 894, 898, 858, 960, 964, 931, 905, 976, 906, 1057, 1251, 1258, 1257, 1259, 959, 1009, 1298, 1261, 996, 922, 44, 43, 42, 39, 40, 577, 873, 1005, 1279, 1283, 1286, 1327, 1267, 1278, 1280, 1328, 893, 143, 437, 144, 255, 429, 430, 431, 145, 432, 433, 434, 435, 436, 973, 232, 1012, 1013, 999, 1043, 1313, 1044, 1045, 1046, 1047, 1048, 1329, 1049, 1266, 1052, 682, 1312, 1304, 1305, 1306, 1307, 1308, 1309, 1310, 1311, 767, 1255, 1303, 1301, 1302, 1300, 1299, 936, 963, 962, 1000, 1276, 1262, 1274, 1275, 1273, 1272, 1015, 1314, 1021, 1022, 1023, 1024, 1025, 1026, 1027, 1028, 1285, 1316, 1317, 1318, 1319, 1320, 1321, 1322, 1323, 1324, 1030, 1252, 677, 958, 957, 34, 599, 975, 7, 955, 147, 1263, 1253, 824, 969, 783, 785, 923, 924, 925, 784, 926, 927, 787, 786, 836, 837, 838, 840, 841, 854, 855, 103, 424, 725, 639, 31, 472, 267, 739, 196, 799, 75, 1256, 438, 978, 24, 453, 569, 1264, 1039, 140, 20, 983, 334, 995, 984, 985, 986, 987, 993, 1001, 1007, 1037, 1036, 981, 982, 988, 11, 616, 600, 769, 489, 483, 484, 485, 486, 487, 646, 1289, 1290, 1294, 1291, 1292, 1293, 1040, 1041, 738, 633, 199, 741, 742, 744, 970, 972, 1326)) and planningelement.idProject not in (0,1015,1314,1021,1022,1023,1024,1025,1026,1027,1028)) and planningelement.idProject not in (0, 1326)
ORDER BY planningelement.wbsSortable
LIMIT 1000001
2024-02-15 12:04:00.084 ** ERROR ** [V11.1.3] Strack trace :
2024-02-15 12:04:00.084 ** ERROR ** [V11.1.3] #0 Sql->query called at [/var/www/hosted/biouv_group/tool/jsonPlanning.php:310]



Posted : 15 Feb 2024 14H05
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


This is exactly what I wrote before.
set or chage parameter in parameters.php file to

$paramDbCollation='utf8mb4_general_ci';


Posted : 15 Feb 2024 14H08
(@pdecloedt)
Posts: 166
Active Member
Topic starter


how can I modify this parameter, if the database is hosted by you?



Posted : 15 Feb 2024 14H11
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


in parameters.php file



Posted : 19 Feb 2024 11H57
(@pdecloedt)
Posts: 166
Active Member
Topic starter


Ok, in parameters.php file.
But how I can access it if the database is in ProjeQtor location ? database is not in our local server.



Posted : 19 Feb 2024 13H41
(@cecile)
Posts: 161
Active Member Admin


Hello,
We changed it for you. It should work fine, now.
Maybe you sent us your own files which where created long ago (before the utf8mb4 was used for the db).



Posted : 19 Feb 2024 13H48
(@pdecloedt)
Posts: 166
Active Member
Topic starter


it's work fine !



Posted : 19 Feb 2024 13H52
