Hi,
I'm facing the following.

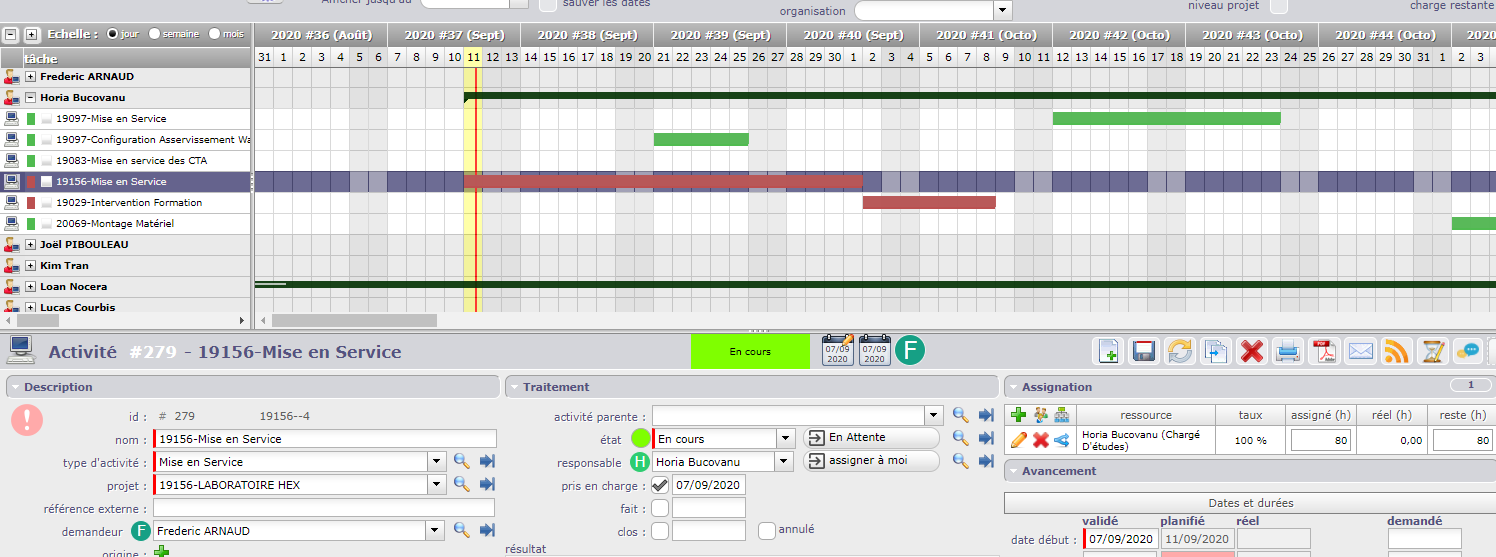

The activity was shedulled to start on 07/09/20.
The responsable of activty, handled the task the exact day when the task started on 07/09/20.
But the task is every day posponed (In this case on 11/09/20)......And the other task sheduled are also postponed.....
The planned date is postponed each day.
I don't understand this stituation..
Any idea too fix it ?
They are a link with reel time.....in Timesheet ?
Thanks
Fred
There is some left work (80 hours).
So Activity is not done...
Postponing it is normal.
