Strangely behavior ...

Notifications
Clear all

Strangely behavior with real work

3 Posts
2 Users
0 Reactions
2,369 Views
Damien
(@dnaton)
Posts: 248
Active Member
Topic starter

[#3932]

Hello,

I have a strange behavior with an activity and real work allocation

My activity : Suivi des temps
Affectation of one ressource, with 12 days assigned

I input the real work (33 days) but Projeqtor tell me that 9 days are still to do

If I input new real work, I have already 9 days still to do 🙁

It is a "test activity" and I would like to supress it but I can't because there is still work to do.......and I don't find a way to input the 9 days still to do 🙁

Each time I input real work allocation, I have already 9 days still to do .

How can I resolve this problem ?

In french now (it's maybe not totally clear in English, I'm not really fluently) 🙂

J'ai un problème avec une activité que j'ai créé pour un test)

J'ai affecté une ressource à cette activité, avec une charge de travail assignée de 12 jours
J'ai saisi les imputations pour cette ressource, à hauteur de 33 jours

Le compteur de travail reel est bien à jour, en revanche, je compteur reste à faire m'indique 9 jours et je ne sais pas pourquoi
Et ce qui est encore plus bizarre, c'est que si j'impute 9 jours de travail supplémentaire (pour combler le reste à faire indiqué)....et bien, le compteur reste à 9 jours de reste à faire (alors que les compteur s"Réel" et "Réévalué' sont eux modifiés correctement.

J'aimera supprimé au final cette activité de test mais je ne peux bien sûr pas car il y a du travail restant à faire. Travail que je ne peux pas enlever car quel que soit l'imputation que je fais, ces 9 jours de travail restant restent présents et m'empêche de supprimer cette tâche.

comment puis-je m'en sortir ?

Regards,
Damien
-----------------------------------------------
.
ProjeQtOr v12.1.0 - Apache v2.4.56 - MariaDB v10.4.28 - PHP v8.2.4
Plugins installed : PersonalizedTranslation 1.6 - ScreenCustomization 7.2

Posted : 15 Dec 2016 13H02
(@babynus)
Posts: 14952
Member Admin

Hi,

I tested, I saw no issue on that point.
Only use case I could see to reproduce you case is :
1) assign 12 days
2) in Real Work Allocation Screen, enter 42 days of work
3) Fix real work to 33 days : there are 9 days left.

Now, this is not a problem as you can set left work to zero manually (eitheir on real work allocation screen or in assignement screen).

To delete the activity, left work does not matter. Only real work does.
Do you have to remove all the left work to be able to delete the activity.

Posted : 15 Dec 2016 13H31
Damien
(@dnaton)
Posts: 248
Active Member
Topic starter

I have done what you say with left work and it's pk.

But for real work allocation, I have still a strange thing

If I go to screen "Affectation", I see for my activity only one people assigned to this activity

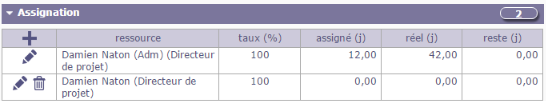

There should be two : in my activity, I have two people assigned

And If I go to the "Allocation" screen, I can allocate real workfor these two people. But I can't find real work already allocated to my ressource who have already real work !!! (and if I generate a rapport for real work for this ressource, it is empty !!!)

I really don't understand :unsure:

ps : I'm connected as Admin to be sure that it is not a problem of access rights

Regards,
Damien
-----------------------------------------------
.
ProjeQtOr v12.1.0 - Apache v2.4.56 - MariaDB v10.4.28 - PHP v8.2.4
Plugins installed : PersonalizedTranslation 1.6 - ScreenCustomization 7.2

Posted : 15 Dec 2016 17H24
