Hello all ,
I have a question concerning plannification.
I want to start my project tomorrow,
So i put into my requested date the date of tomorrow but each time the software chnange the planned date at today.
I don't know why, someone can help me please ?
Have a good day.
The requested date is just informative : the date the customer requested (his Christmas wish list)
The date that should be taken into account is the validated start date. But it is not a constraint to planning calculation.
You need to set a real constraint to planning calculation. For instance, add a "fixed" milestone starting on tomorrow, then make your first task of project start after the milstone (add dependencing link).
Hello
Thank you for you reply, i understand a little more now 🙂

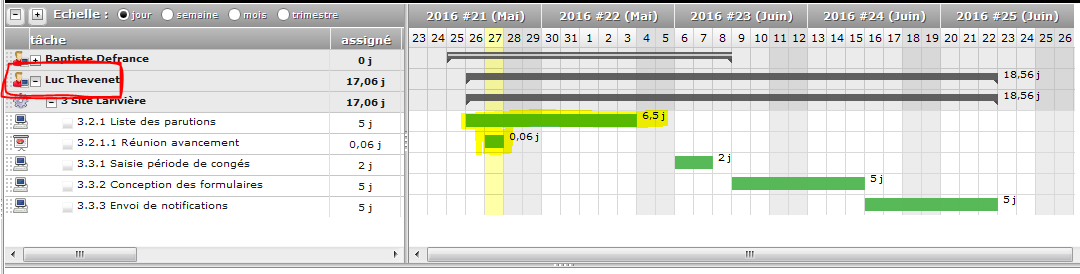

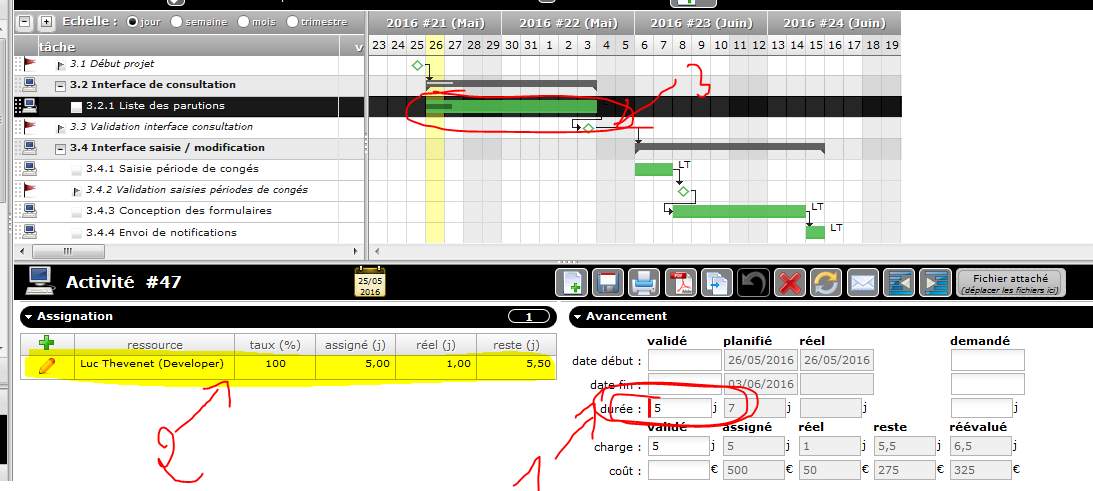

When i want to plannify my ressource i don't understand but when i put 5 days on my "charge" (#1 in my screenshoot) and i modify the assignation of the ressource and fill 5 days (#2 in my screenshoot) the planning is modify and as you can see (#3 in my screenshoot) there is 7 days of work, howerver i want 5 ?
Can you help me please 🙂
And can you tell how the value in yellow is calculate please in my second screenshoot.
Have a good day 🙂
Have a look at report "planning per resource/project/activity" in "planning" report category.
You'll see exacly what the resource does or is planned to do on the oeriod.
Maybe he is busy on another project.

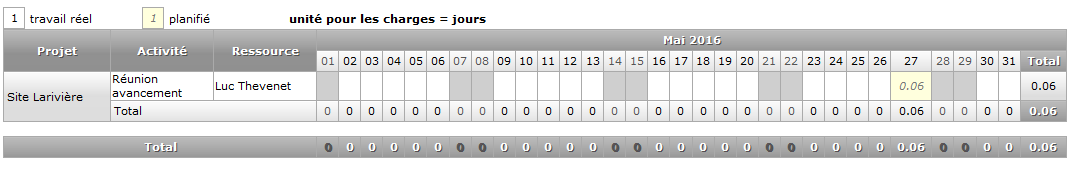

Your resource is attending a meeting, on friday, taking 0,06 days of resource availability.
So this resouce cannot work 5 full days on the task you expect him to work. The 5 work days (as workload) will be planned in more that 5 dayxs (exactly 5,06 days, being reported as 6 day (duration is not rounded but ceilled)
