Forum

Welcome to ProjeQtOr new Forum. We migrated old forum to the new website.
You will find all your posts here, with your usual account.
Just one point : you’ll have to reinitialize your password. Use “Lost password” feature.

Wrong planning calc...

Notifications
Clear all

Wrong planning calculation when recurring (weekly basis)

3 Posts
2 Users
0 Reactions
1,161 Views
(@seminote)
Posts: 29
Active Member
Topic starter

[#9090]

Hi, we have such a problem and can't figure out what it stems from.

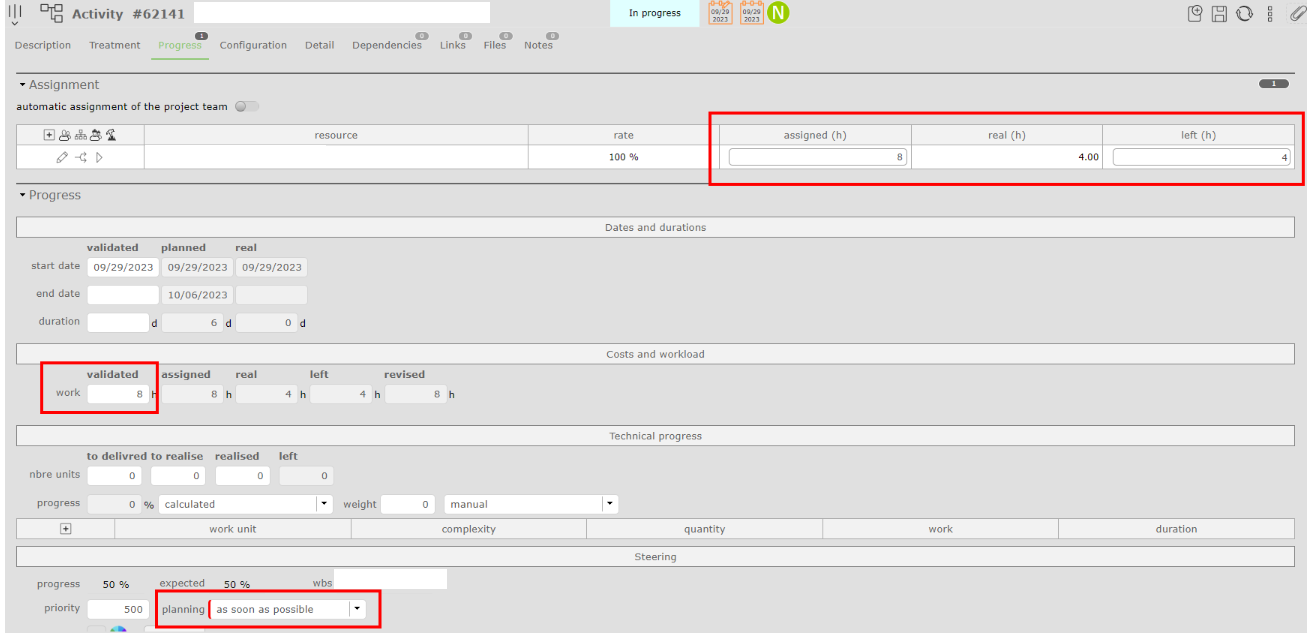

1. When planning is "as soon as possible" and run the calculation : OK

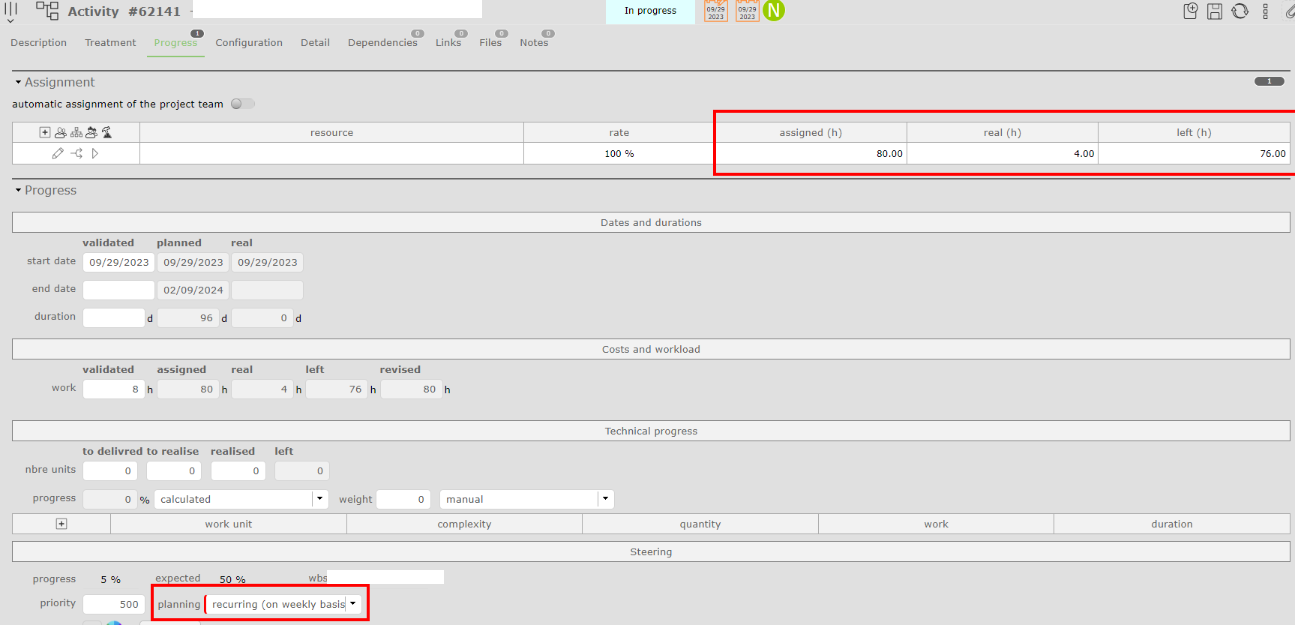

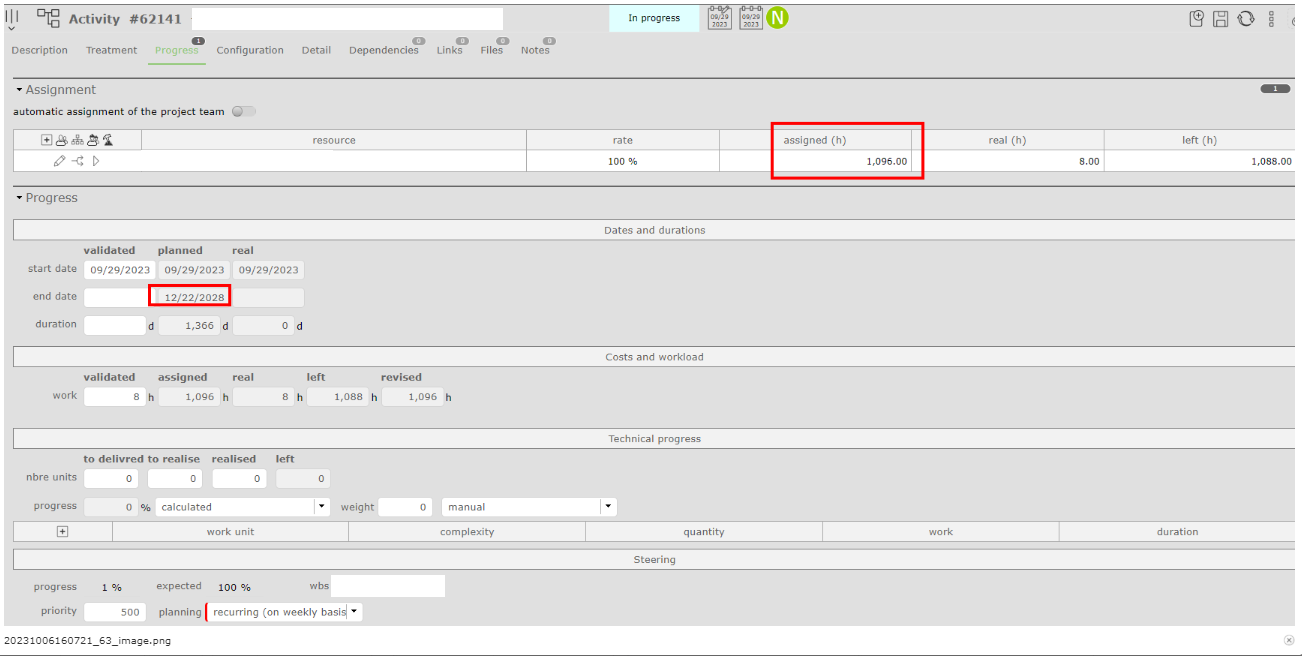

2.If change planning to "recurring (on weekly basis)" - 4h each Friday - and run the calculation : KO, assigned time is not properly calculated - validated is 8h, but automatically is assigned 80h and planned end date is 02/2024. Why is this difference?
What we expect is these 8h to be allocated for 2 Fridays


3. We also don't know why this is changing....






Posted : 10 Oct 2023 11H52
(@alain-fourastie)
Posts: 366
Active Member Moderator


Hello,

Recurrent mode is a special mode planning each week, the same selected workload by day over a week, during the whole project. You can limit this beahavior by two milestones steering this activity beetween two dates.
it takes into consideration the valided workload to planified one day of workload over one opened day if it is the single information it gets. Otherwise it plans with workload given independltly of validated workload, that's happened using recurent mode.
This being said, how did you manage to provide real workload when there is no longer anyone assigned to the activity?  Could i watch too the screen about your project please

bye




Posted : 10 Oct 2023 13H08
(@seminote)
Posts: 29
Active Member
Topic starter


someone is assigned to the activity however I hid our user data and our company data (name, project etc).

Which view exactly do you need? What tab and what data?



Posted : 10 Oct 2023 14H21
Share:

Scroll to Top
