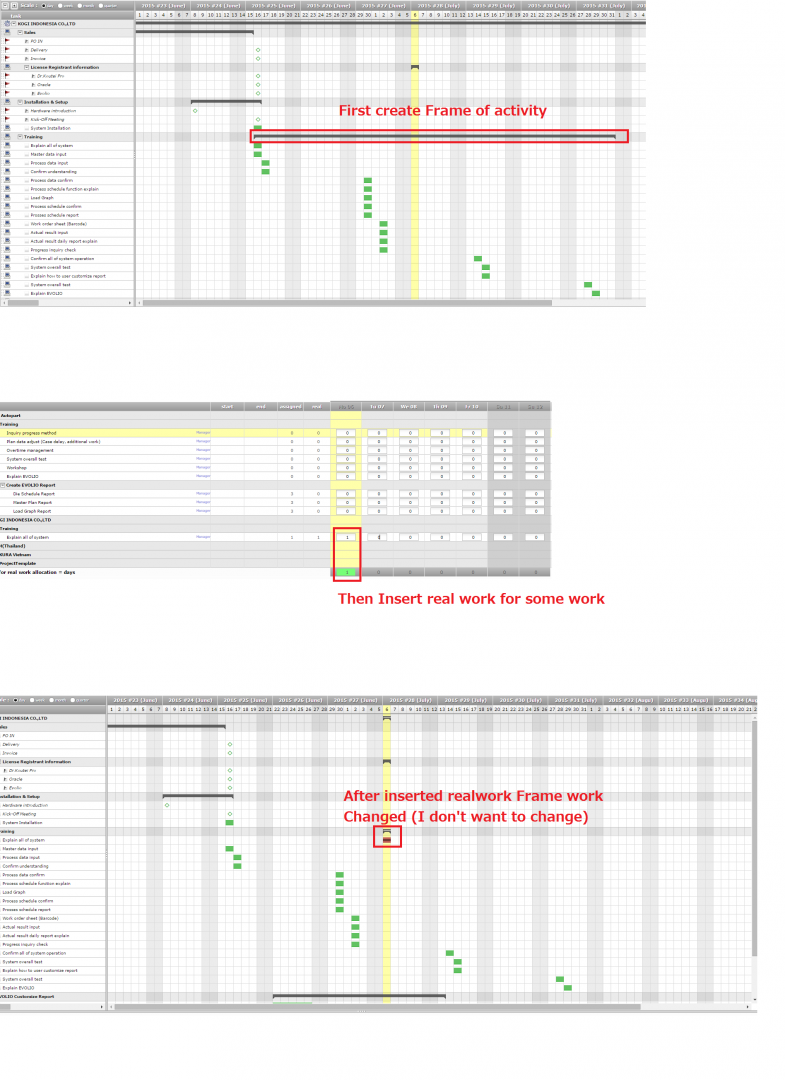

1) Re-run panning calculation to usure new data is correctly taken into account
2) Check for left work : if no left work, start-end dates are the ones corresponding to real inputs
3) Check planning mode :
=> "as soon as possible" (default) will shorten duration
=> "fixed duration" or "regular between dates" may help you preserve duration
