Notifications
Retirer tout
Submit issues
2
Posts
2
Utilisateurs
0
Reactions
3,897
Vu

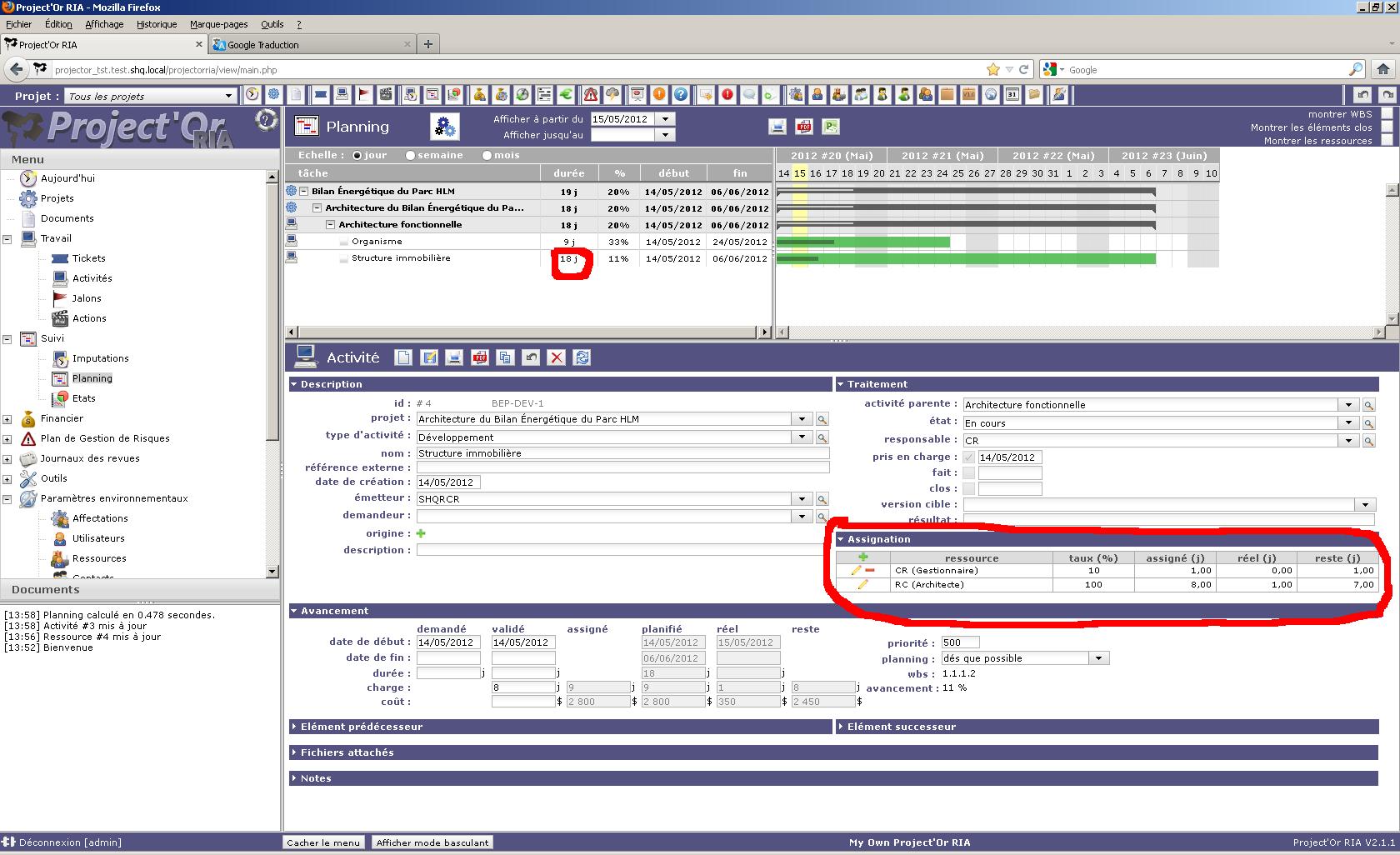

I wanna ask you why Projector calculates the duration on activity like the sum of its resource works duration
Just because it does not ! 😛
I wonder if is not the max of theses durations ?
Neither ! :woohoo:
All depends on availability of resources.
All you can assume is :
- total duration >= max (work for each resources)
On the best case, if resources are not assigned on other tasks, then you're right :
- total duration = max (work for each resources)
Posté : 16 Mai PM 19:055
