Hello,
when i use "Fixing planning", the project doesn't appear anymore in reports and, worse, planned work is ignored...

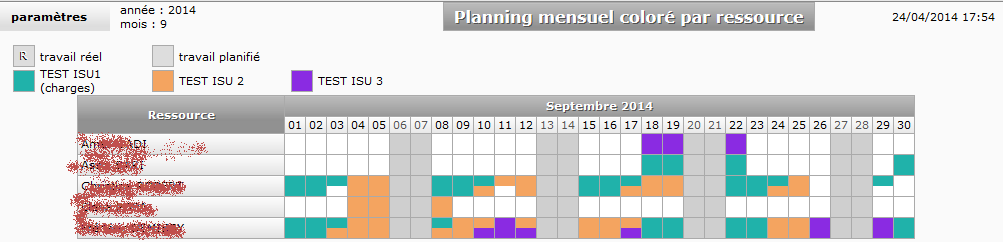

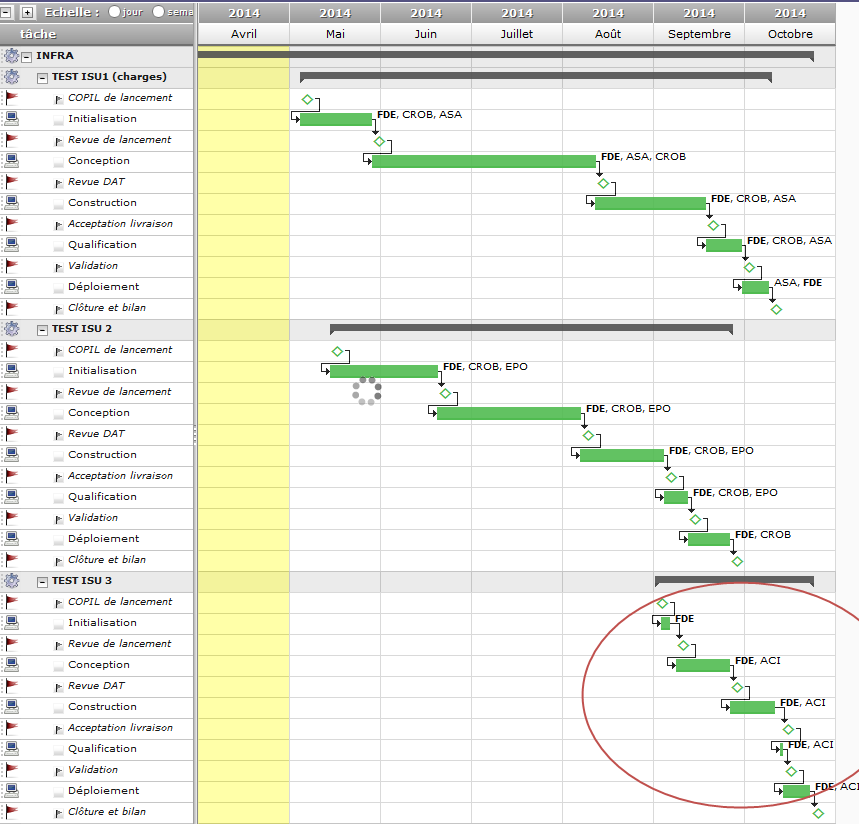

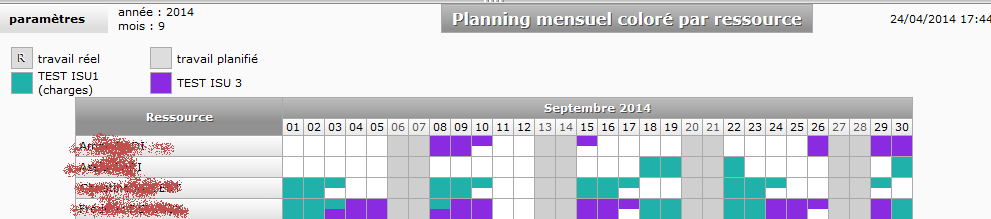

For exemple, in attachment, you see colored planning for a month, with or without fixing planning for project ISU2, in the first case, project ISU2 is not visible.

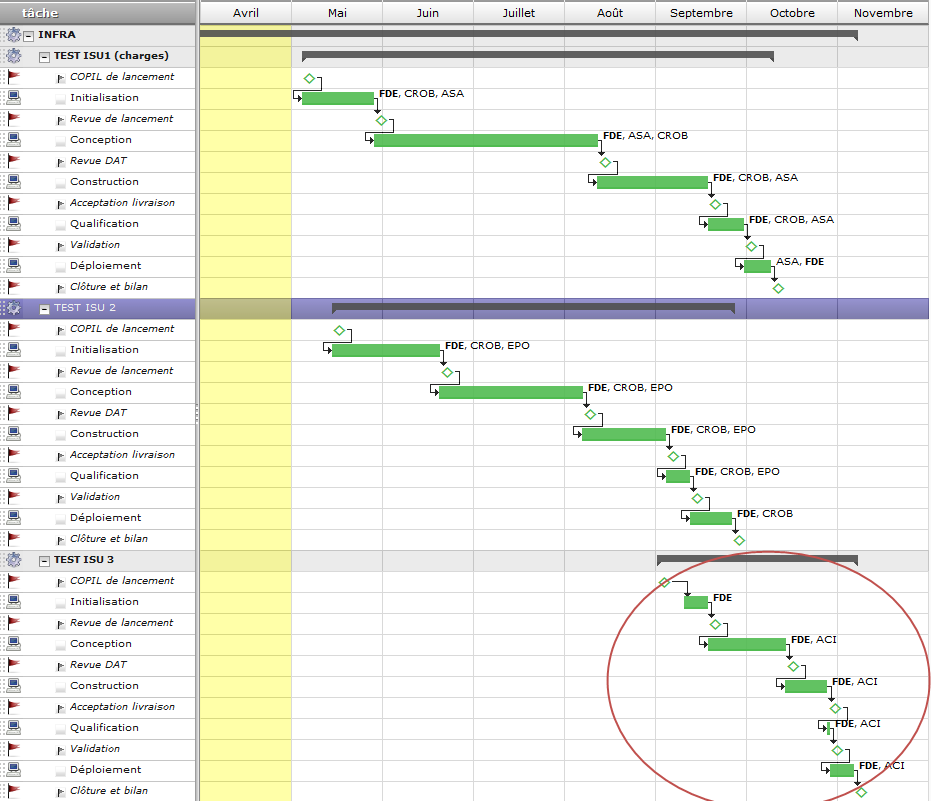

It seems that, when fixing planning, both project and ressources usage are "invisible" for planning calculation, so ressources wich are on duty on fixed planning project appears to be free for use in another project... (see attachment planning with or without project ISU2's planning fixed).
I Think that fixing project is luch more dedicated to fix planning and ressources usage so, whatever the usage of ressource in others projects, your planning become a constraint for them.
Expect that my english wasn't so poor...
You are right : issue is confirmed.
When planning is fixed, planned dates are not changed, but planned work on the project is lost and available for other projects.
Ticket #1372 recorded.
Issue is fixed and will be deployed on V4.3.0.
If you need it, attached is a fixing patch.
