Forum

KPI Deliverable for...

Notifications
Retirer tout

KPI Deliverable for project Report issue

8 Posts
2 Utilisateurs
0 Reactions
4,098 Vu
(@karl-binet)
Posts: 128
Active Member
Début du sujet

[#7942]

Hi,

Projeqtor Version V9.3.4

It's appears that the bottom summary in the report is not accurate, it is not showing the correct value.

Can you have a look at this issue, or maybe i'm just missing something,

Regards

Karl

Posté : 3 Déc PM 16:1212
(@babynus)
Posts: 14952
Membre Admin

We'll have a look.

Posté : 3 Déc PM 19:1212
(@babynus)
Posts: 14952
Membre Admin

Hi,

Global value (%) is weighted average.
The weight is the value of the "importance".
So if all values are zero, weighted average is zero.

Posté : 3 Jan PM 17:011
(@karl-binet)
Posts: 128
Active Member
Début du sujet

Hi

thank you for your answer, here are my comments

We understand well how the calculation is made, our question is more about the results that are displayed seem inconsistent with what we find in the database

So referring to the data in report/kpiDeliverable.php, we understand that the values of the tables kpiHistory and kpiValue are used.

However, these values do not seem to be in harmony

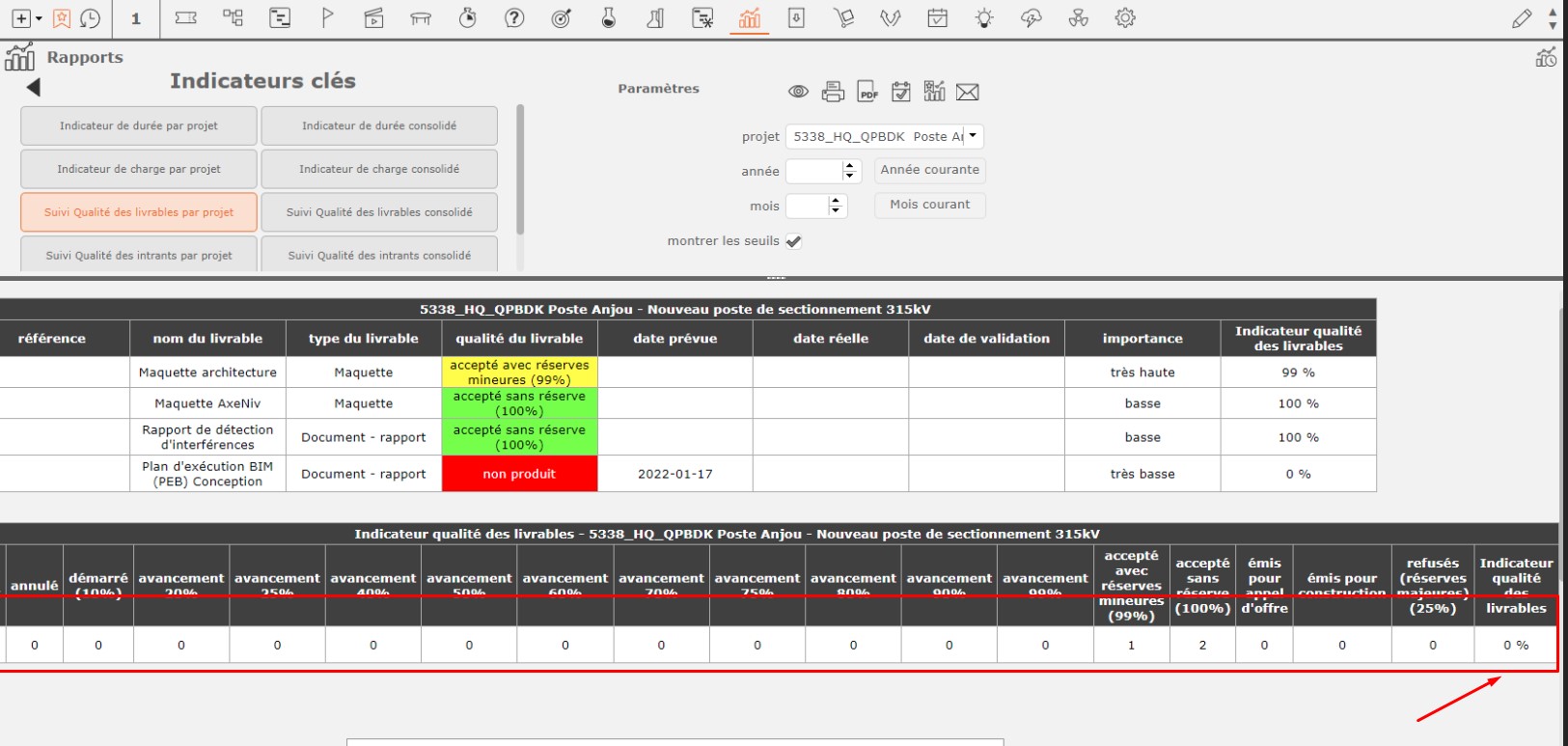

kpivalue

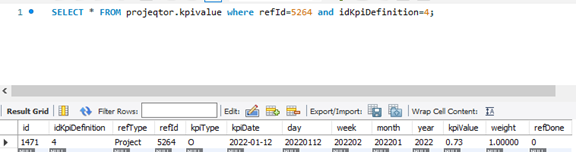

According to our calculations, the value in the database is good è 73% advancement

Our Internal Dashboard that calculates the same thing by compiling the table of deliverables :

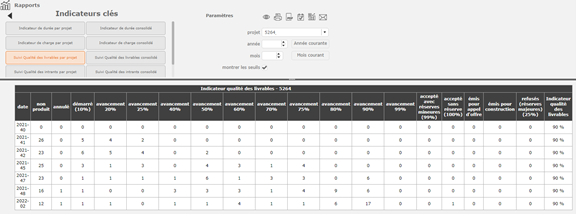

kpihistory

gives us no results

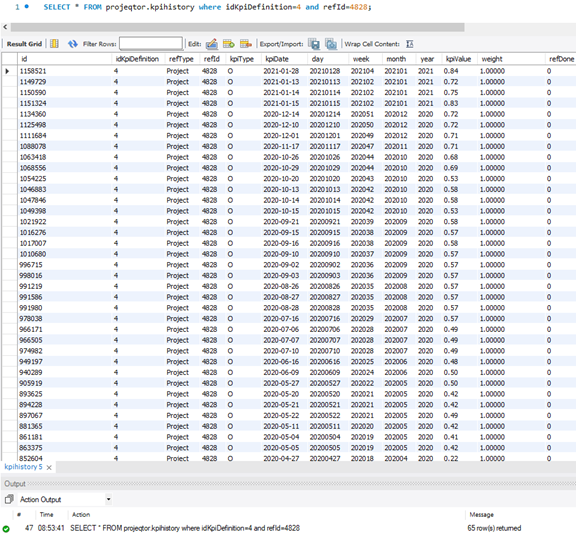

If we look at another project: 4828
Values are incomplete and incorrect  :

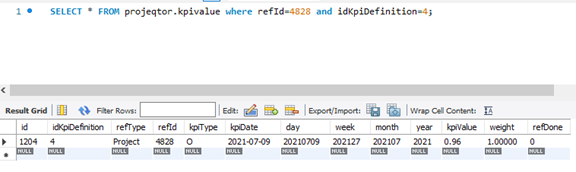

The value of our dashboard and the kpiValue table are good « 96% » :

kpiHistory

So it seems that the assembly of the summary table by weeks in the report does not show the right values, although they are compiled correctly in the database.

Posté : 20 Jan PM 18:011
(@babynus)
Posts: 14952
Membre Admin

Hi,

The difference you mote mayu come from the point that the report always takes the latest value of the Kpi for a period, and not the average of all walues.

Posté : 25 Jan PM 14:011
(@karl-binet)
Posts: 128
Active Member
Début du sujet

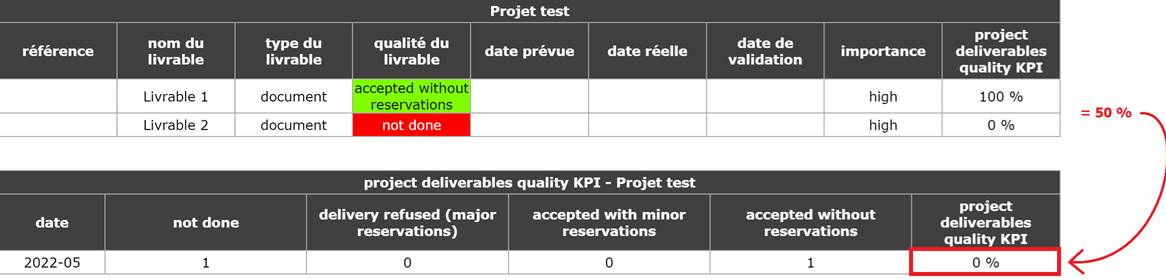

Thanks for your answer. Unfortunately, we are not averaging while doing our calculation. We have tested on a fresh install v 9.4.3. with 2 deliverables of same weight (high) : first one at 100% (completed/accepted without reservations) and the other one not done (0%).

Our understanding of the formulas is :
SUM( status(%) * weight) / SUM(weight)
So, with our example (high weight = 1 – by default) :

((100% *1) + (0% * 1)) / (1 +1) = 50% KPI
1 / 2 = 50% KPI

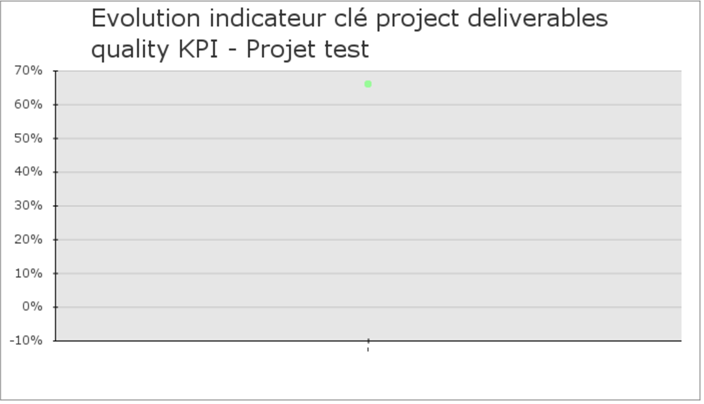

KPI does not seem to reflect our previous result (50%) in the table (0%) neither is the graph (near 65%)

Our question is the following:
Is our understanding of the formula and the report values wrong?

Posté : 10 Fév PM 15:022
(@babynus)
Posts: 14952
Membre Admin

In fact formula is not exactly what you write.
It is :
SUM( status(%) * weight) / SUM(max weight)
Where in fact SUM(max weight) is [number of item] x [max weight value avalable in weight table]

Posté : 12 Fév PM 19:022
(@karl-binet)
Posts: 128
Active Member
Début du sujet

Thanks for the clarification for the formula.What about our last post screenshots: The formula gives a different value in the table view vs the graph with a fresh install of ProjeQtOr.Why do the graph view gives us about 65% and the table view 0% for the same week ?

Posté : 16 Fév PM 22:022
