Forum

Planning Calculatio...

Notifications
Retirer tout

Planning Calculation Logic

11 Posts
2 Utilisateurs
0 Reactions
3,976 Vu
(@rainbow)
Posts: 84
Active Member
Début du sujet

[#7472]

Hi,

I would like to ask whether there are any detail description on the planning calculation logic in addition to the user manual on the "PROJECT PLANNING CALCULATION" ?

I noticed that for some tasks, the planning calculation planned the task to dates and work assignment which differ from the defined validated dates, planning mode, and resource allocation rate. In addition, for some tasks, even with the planning calculation option - "Plan with overuse (infinite overbooking capacity)" selected, the calculation did not plan overuse or skipped allocation on certain days (which the resource still has capacity for allocation) which cannot meet the validated dates with planning mode - "Regular between dates".

Thanks,
Rainbow



Posté : 7 Avr AM 06:044
(@babynus)
Posts: 14952
Membre Admin


I would like to ask whether there are any detail description on the planning calculation logic in addition to the user manual on the "PROJECT PLANNING CALCULATION" ?

No, user manual doies not enter into such detail.
But during our training courses, we explore this subjet. 😉




Posté : 9 Avr PM 17:044
(@rainbow)
Posts: 84
Active Member
Début du sujet


Hi Babynus,

Thanks for your reply. Good to know that training courses would be helpful.

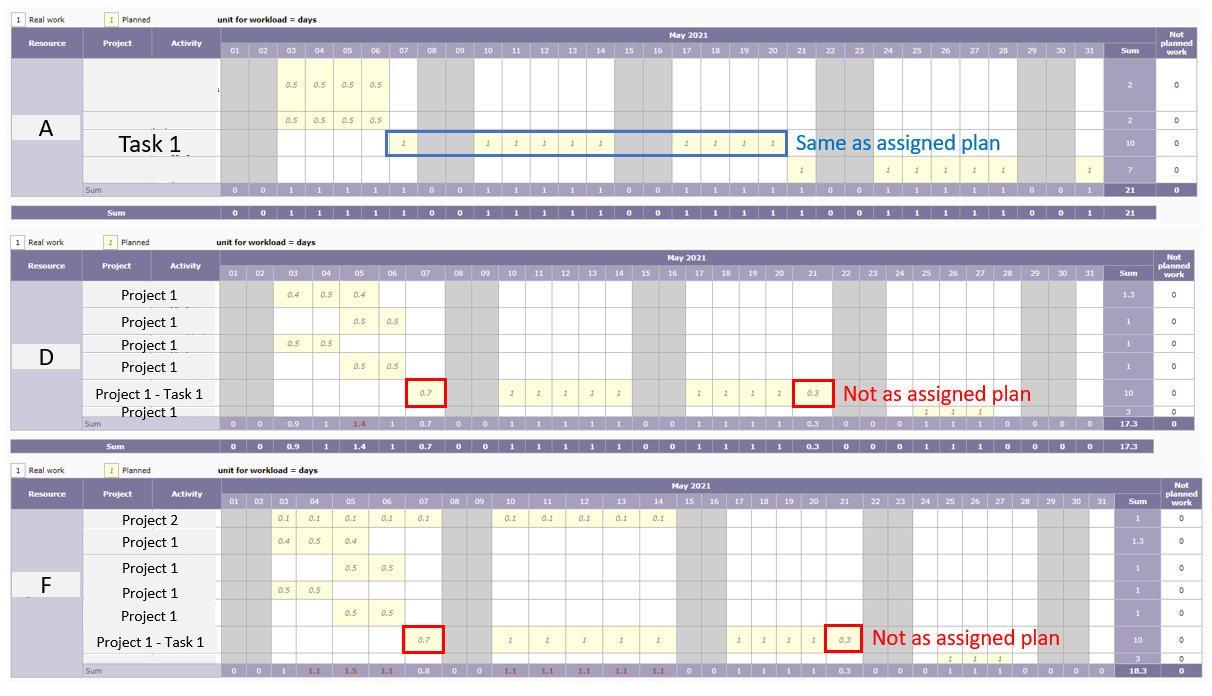

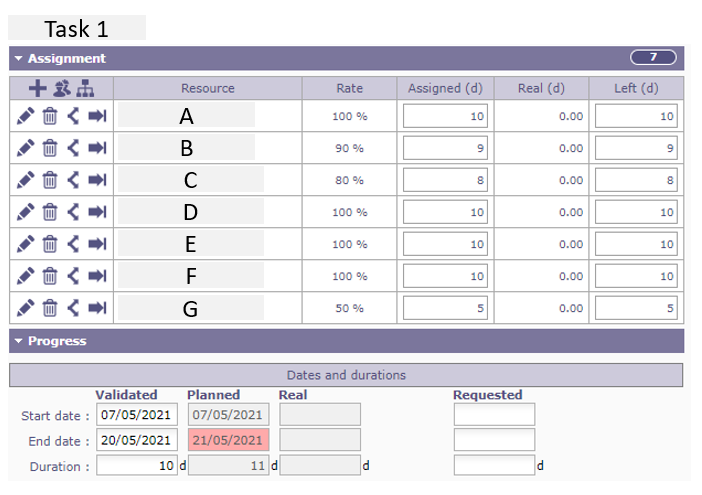

Just want to check if the cases mentioned in previous post are normal or there are bugs/setting issues in the calculation. I tried to repeat a case mentioned and attached the screenshots for your reference. The task validated start date is 2021/5/7 and end date is 2021/5/20 with planning mode as soon as possible. In the assigned resources, a few have work allocated on 2021/5/21 instead, while they have capacity on 2021/5/7 such that the work can be distributed within 2021/5/7 and 2021/5/20. In the plan calculation, the planning calculation option - "Plan with overuse (infinite overbooking capacity)" is selected. Is there any issue in the calculation or settings required?

Appreciate for your advice. Thanks.

Rainbow



Posté : 12 Avr AM 09:044
(@babynus)
Posts: 14952
Membre Admin


Yes, this mays be accurate.
The "Plan with overuse (infinite overbooking capacity)" will have effect only between project.
This means the resource will be planned on several project for its full capacity.
But inside same project, capacity of resource is respected, otherwise, every activity "as soon as possible" will be done in one single day 😉
So the calculation may be correct if the ressource is busy on another activity on same project.



Posté : 13 Avr PM 16:044
(@rainbow)
Posts: 84
Active Member
Début du sujet


Hi Babynus,

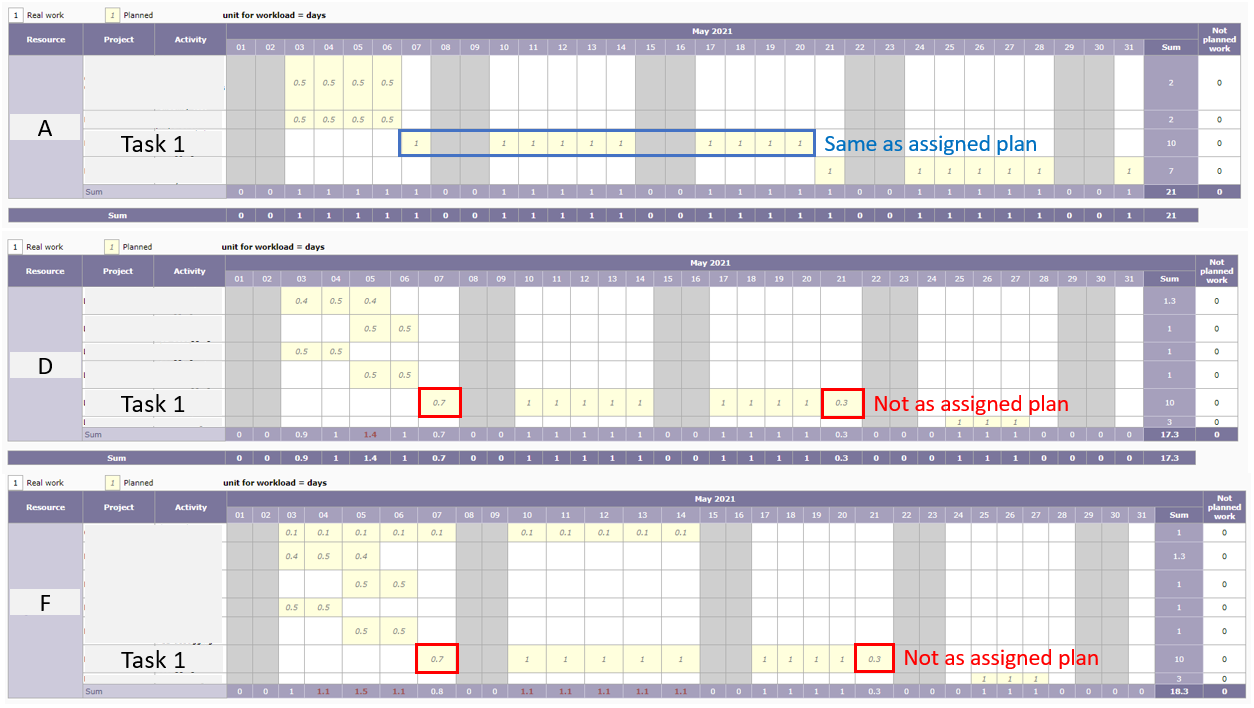

Many thanks for your explanation on the calculation. I think the situation you mentioned does explain for some of the cases, while for the case mentioned in previous post, for resource D and F, all the tasks assigned to them are shown in the screenshot. For resource D, all the task shown in the screenshot belongs to the same project. For resource F, except the first row, other tasks shown in the screenshot are the same project as resource D. If accordingly to your explanation, day May 7 should be able to plan workload = 1 day such that the workload would be allocated through till May20 instead of May 21, right? Please advise there is any misunderstanding. Thanks!





Posté : 14 Avr AM 05:044
(@babynus)
Posts: 14952
Membre Admin


There seem to be something that take 0.3 days for each on may 7th.
A Meeting ?
Some already entered real work ?



Posté : 14 Avr AM 10:044
(@rainbow)
Posts: 84
Active Member
Début du sujet


Hi Babynus,

I rechecked that there are no meetings or real work entered in May, which is why I found it weird.

Thanks,
Rainbow



Posté : 14 Avr PM 12:044
(@babynus)
Posts: 14952
Membre Admin


Seach in the DB.
If id of your resource is X,
To find real work already booked :

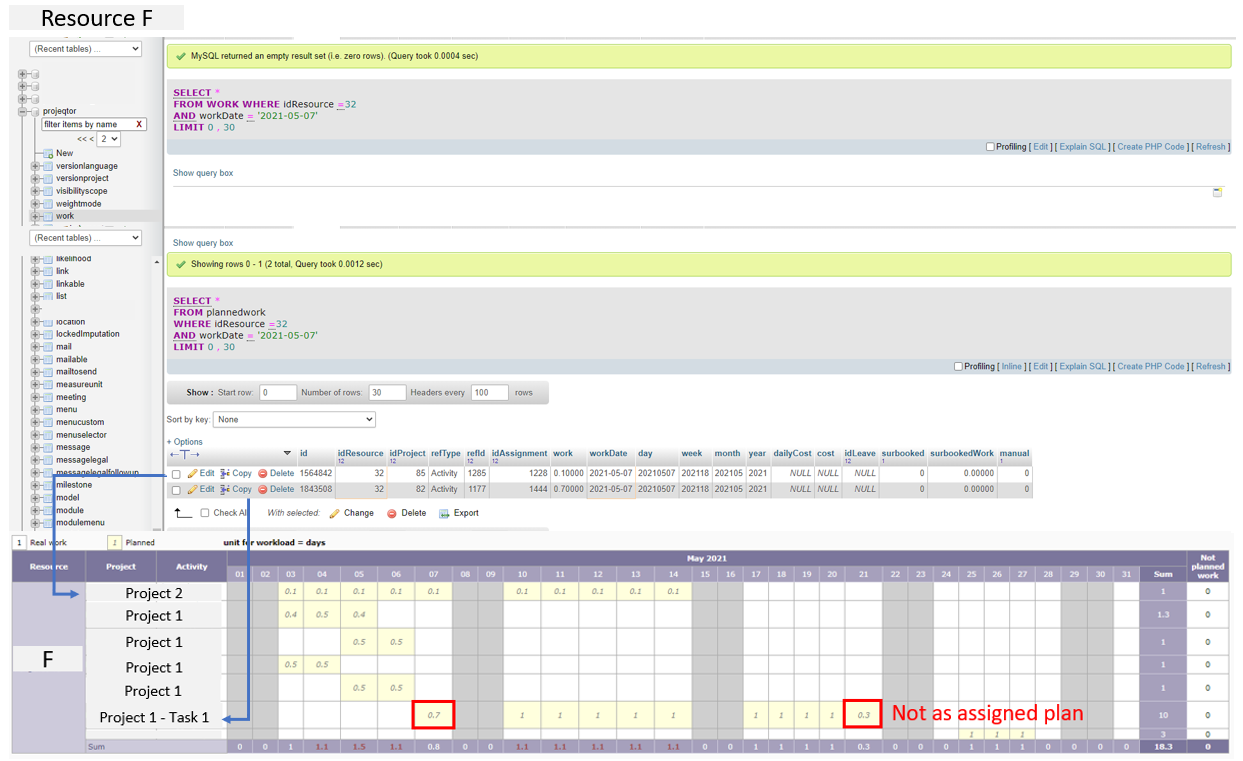

select * from work where idResource=X and workDate='2021-05-07';

Then to find plannd work for the resource :

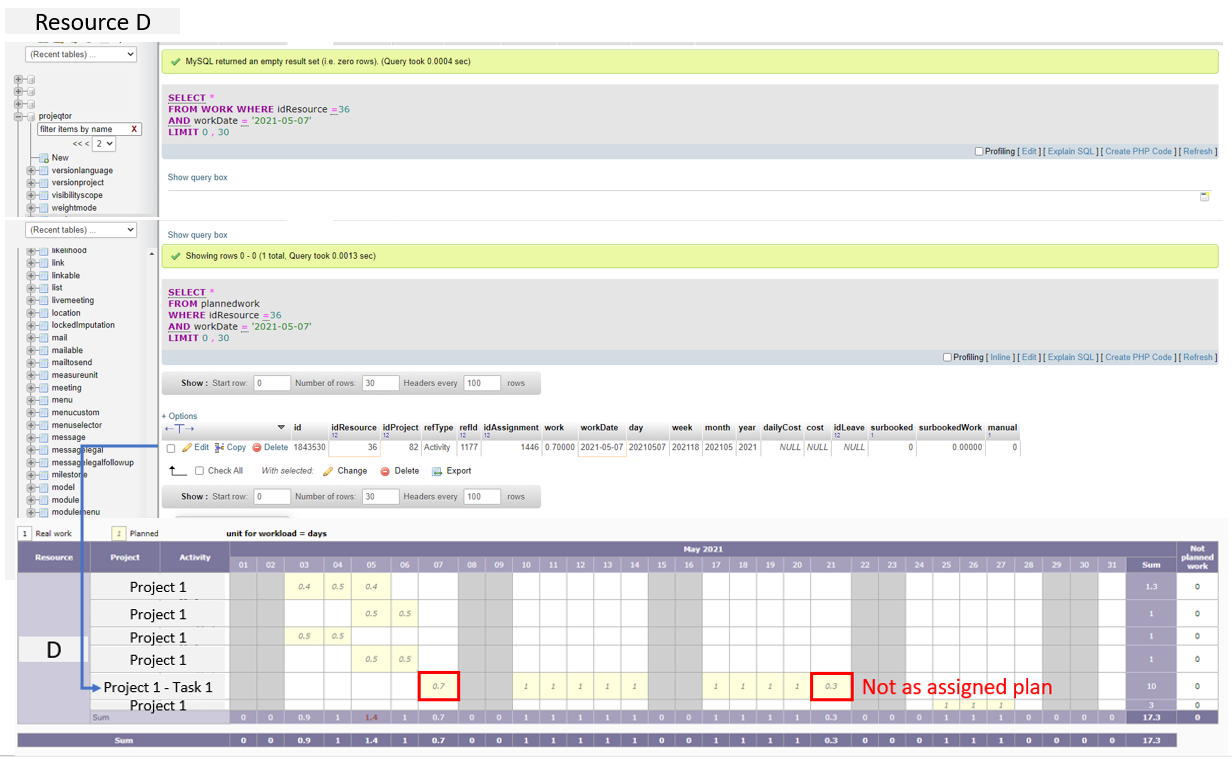

select * from plannedwork where idResource=X and workDate='2021-05-07';



Posté : 14 Avr PM 19:044
(@rainbow)
Posts: 84
Active Member
Début du sujet


I searched in the DB with the following results which is the same as the work plan report.

For resource D:


For resource F:




Posté : 15 Avr AM 06:044
(@babynus)
Posts: 14952
Membre Admin


Yesy, very strange.
Could you please try and reproduce use case on the demo ( https://demo.projeqtor.org) so that we can analyse the situation ?



Posté : 15 Avr AM 10:044
(@rainbow)
Posts: 84
Active Member
Début du sujet

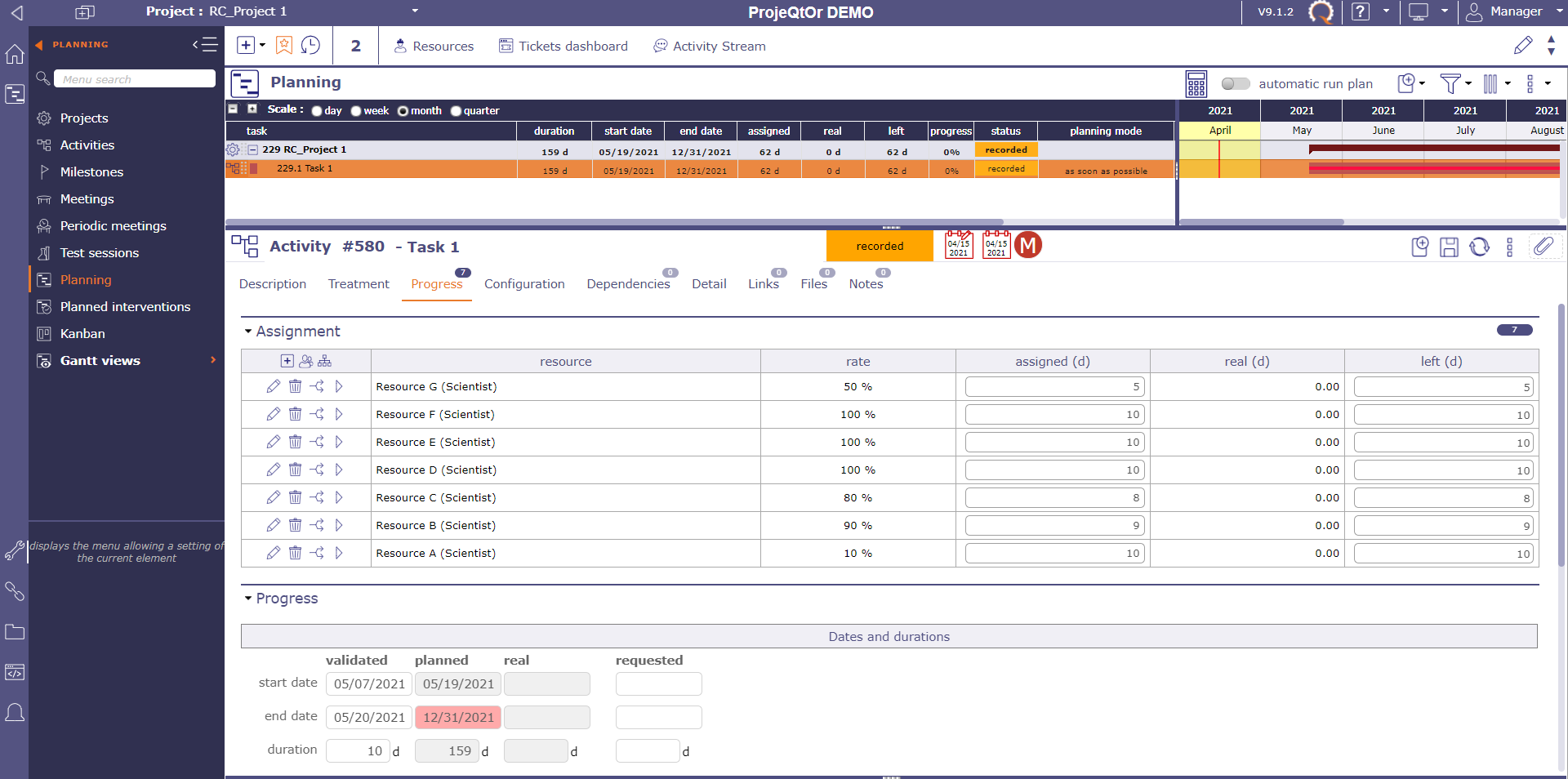

I inputted the task and the resource info for the task mentioned as activity #580, validated start date = '2021-05-07' and validated end date = '2021-05-20'. However, I tried to run the calculation but the planned start date couldn't be planned on '2021-05-07'.





Posté : 15 Avr PM 12:044
