Forum

Real cost doesn't r...

Notifications
Retirer tout

Real cost doesn't reflect Real Work

17 Posts
2 Utilisateurs
0 Reactions
8,959 Vu
(@cnguyen)
Posts: 38
Active Member
Début du sujet

[#5509]

Hi all,

I'm using Projeqtor 6.3.7

I've just done the following operations on a project.
3 resources on my project. Everyone has entered real work up to 31 october 2018.
On one of the resource, i have just entered a cost (C EUR) on the expert profile (This profile is the one my resource is assigned with for the projet / activity)
There was no other cost in the system for the resource.

On the project before entering the cost, real work was X days and real cost was 0 EUR
I saved the cost for the function of my resource on the project (Expert)
Back to the activity, the real cost is still 0 EUR.

Then I enter 1 day on the real wok allocation screen
Real work is now X+1
And real cost is now C EUR, which is the cost I have just allocated for the function.

Seems like real cost has not change for the already existing work.

Any idea ?
Thanks in advance.
Cyril



Posté : 28 Oct AM 11:1010
(@babynus)
Posts: 14952
Membre Admin


Seems like real cost has not change for the already existing work.

It should, I think current code does.

Any idea ?

Migrate to latest stable (V7.2.6).
(there were some fixes on the subject on V6.5)

NB : we won't analyse issues on older versions our of Support Service



Posté : 28 Oct PM 17:1010
(@cnguyen)
Posts: 38
Active Member
Début du sujet


Hi babynus,
Just upgraded to 7.2.6 and the issue remains the same.

Could you help ?

Thanks in advance
Best regards,
Cyril.



Posté : 1 Nov PM 16:1111
(@cnguyen)
Posts: 38
Active Member
Début du sujet


Hi everyone,

@Babynus, we upgraded to 7.2.6 and real cost still doesn't reflect real work for already submitted "work".
We are a bit stuck with this and it's difficult to follow costs for these projects.

By the way : the upgrade to 7.2.6 has brought a lot of new functionalities for us that are really nice and helpful. Thanks for all the good work on Projeqtor 🙂

Thanks in advance for your help.
Best regards
Cyril



Posté : 13 Nov AM 10:1111
(@babynus)
Posts: 14952
Membre Admin


@Babynus, we upgraded to 7.2.6 and real cost still doesn't reflect real work for already submitted "work".
We are a bit stuck with this and it's difficult to follow costs for these projects.

You need to have some resource cost change to update cost from work.
Try and delete cost for resource then recreate it.



Posté : 13 Nov AM 10:1111
(@cnguyen)
Posts: 38
Active Member
Début du sujet


As there is some real work assigned with this function, I can't delete the cost

Error message I get when I want to delete the cost assigned to the function.
Impossible to delete this element because of existing dependent elements
- Assignment (10)



Posté : 13 Nov PM 18:1111
(@babynus)
Posts: 14952
Membre Admin


Try just to change the value.



Posté : 14 Nov AM 11:1111
(@cnguyen)
Posts: 38
Active Member
Début du sujet


I've changed the cost on the resource. Then back on the activity, real cost has not changed.
I changed again the cost to the old cost, no change.



Posté : 14 Nov PM 12:1111
(@babynus)
Posts: 14952
Membre Admin


Hi,

I just did the test.
Resource with cost 100€/day

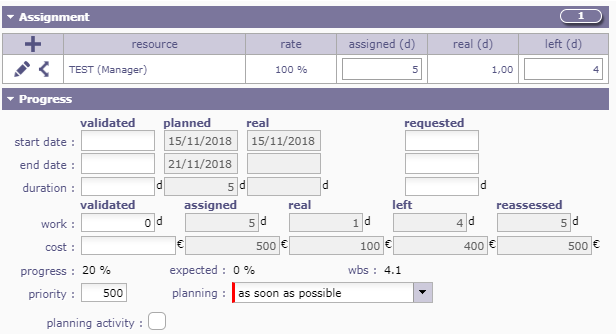

Assigned to activity with 5 assigned days, 1 real day, real cost of activity is 100€

Now update cost to 150€ / day

Real cost on activity is updated



Posté : 14 Nov PM 13:1111
(@cnguyen)
Posts: 38
Active Member
Début du sujet


The difference with our context is that at the beginning, my real cost is not ok (yours is 100 for 1 day, and after 150 for 1 day).
Everything is ok, even before changing the cost.
My context is :
a project on which real work was already entered. But no cost on the function for the resource.
Then add a cost and no change
Cyril



Posté : 14 Nov PM 14:1111
(@babynus)
Posts: 14952
Membre Admin


New test in your context.
Resource with no cost

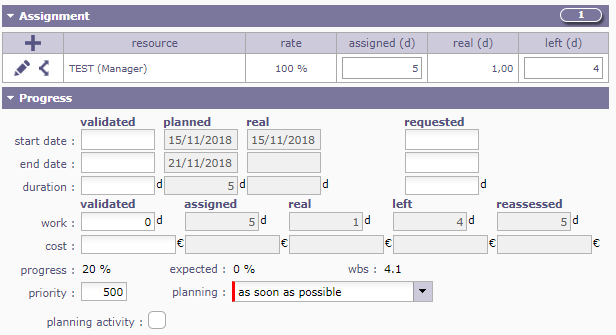

Assigned for 5 days, 1 real on activity : no cost

Add cost

Cost is updated on activity

All works fine.

Please post screenshots as I did to show your use case.



Posté : 16 Nov AM 01:1111
(@cnguyen)
Posts: 38
Active Member
Début du sujet


Hi,

The software is working well as you showed on the previous screenshot.
I can confirm that on project / activity that I have recently created or on which costs where added before real work allocation was saved in the tool.

My example is the following :

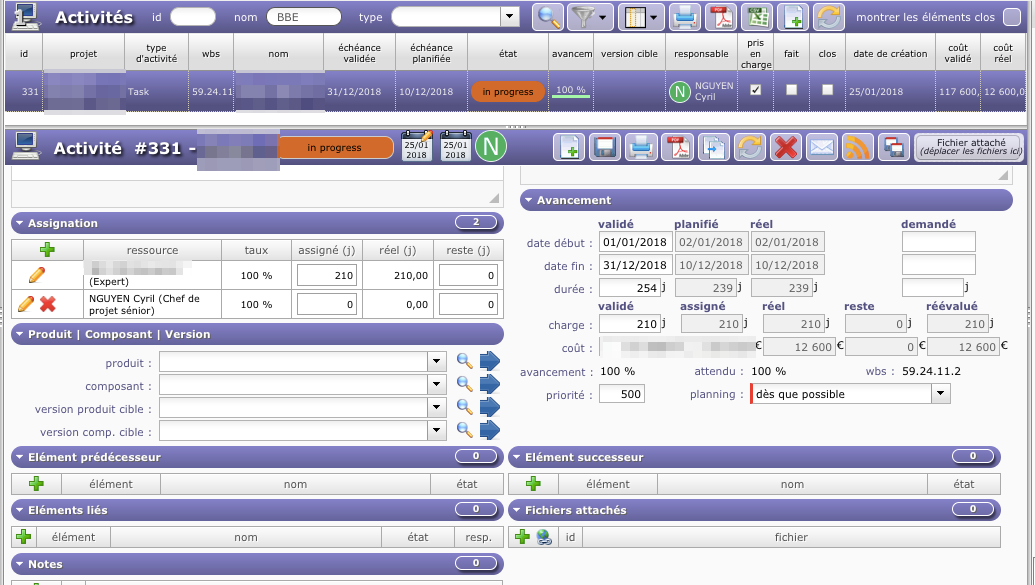

- ScreenShot 1 : On my project there is one activity that shows the following
210 days real work for my resource
Resource is assigned with expert function as you can see.
Real cost is 12 600 EUR

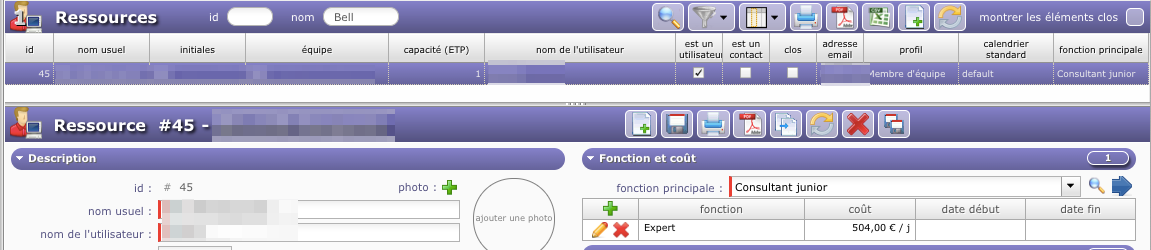

- Screenshot 2 : My resource cost is 504 EUR for Expert function.
Sorry you don't see the name of the resource on the screenshot but no doubt it's the resource that is assigned on the activity.

210 * 504 is 105 840 EUR, which is not 12 600 EUR.

So I don't understand why I get 12 600 EUR in real cost for the activity.

Best regards
Cyril



Posté : 26 Nov PM 19:1111
(@babynus)
Posts: 14952
Membre Admin


I think it is due to old versions of ProjeQtOr storing null and not zero.
It was changed because of PHP 7.1 than could not sum null+not null.
So ever you can test with PHP 7.0 and it should work correctly,
or you need to update database

update work set cost=0 where cost=null;

(don't forget to backup database before executing SQL statement)



Posté : 27 Nov AM 01:1111
(@cnguyen)
Posts: 38
Active Member
Début du sujet


Hi,

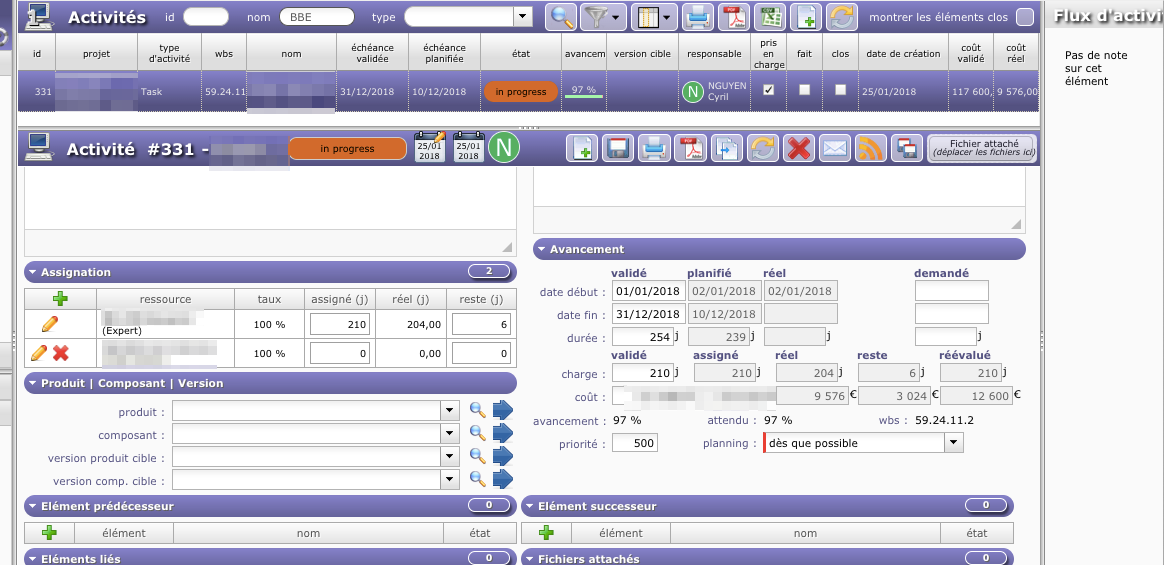

We have executed the query (see attached file).
Real cost is still not what it should be (see attached file).

Best regards
Cyril



Posté : 29 Nov PM 18:1111
(@babynus)
Posts: 14952
Membre Admin


Well, the upsate is not enough.
Now you have to change value for resource cost.
What would be best is to delete existing and create new one, but it won't be possible (you cannot delete resource cost if function is used on assignment)
What you can do is add new cost "far in the past" (for same function, with starty date before first day of real work)



Posté : 29 Nov PM 21:1111
Page 1 / 2
