[SOLVED] Same Assignement ID for 2 differents ressources

9 Posts
2 Users
0 Reactions
7,728 Views
(@bion)
Posts: 70
Active Member
Topic starter

[#5682]

Good Morning,

While using projeqtor on the timesheet view i get my real time on an activity "twice", on as "développeur" and the other one as "chef de projet"

2 ressources are working on that activty (id 165 and 191)

When i check on data base for these ressources i've got the same assignement ID for the same Activity and i don't know how it end up likes that.

Another thing is that when i go back into Activity screen and i update the assignement the ID are differents for the profil "Développeur" and "Chef de projet" so why are they equals in DataBase?

Developpeur A ssignement :

Chef de projet Assignement :

thanks for helping

Posted : 14 Jan 2019 11H54
(@bion)
Posts: 70
Active Member
Topic starter

As pictures are not rendering on my previous post here's a re-upload

While using projeqtor on the timesheet view i get my real time on an activity "twice", on as "développeur" and the other one as "chef de projet"

2 ressources are working on that activty (id 165 and 191)

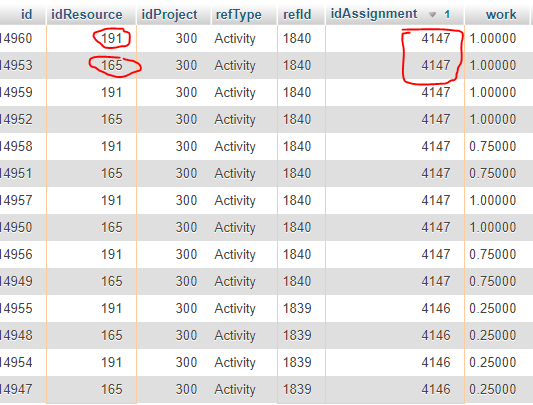

When i check on data base for these ressources i've got the same assignement ID for the same Activity and i don't know how it end up likes that.

Another thing is that when i go back into Activity screen and i update the assignement the ID are differents for the profil "Développeur" and "Chef de projet" so why are they equals in DataBase?

Developpeur A ssignement :

Chef de projet Assignement :

Posted : 14 Jan 2019 17H56
(@bion)
Posts: 70
Active Member
Topic starter

oops,
with developer's view i've got "aucune modification à sauver pour l'élément Assignation #4147 "

Posted : 14 Jan 2019 18H13
babynus
(@babynus)
Posts: 14966
Main Contributor Admin

Hi,

It is possible if resources entered work on assignement of a pool to which they belong.
The idAssignement refers to the assignement of the pool.

Posted : 16 Jan 2019 21H05
(@bion)
Posts: 70
Active Member
Topic starter

hi ,

unfortunately they don't belong to any pool as shown below

Posted : 22 Jan 2019 11H06
babynus
(@babynus)
Posts: 14966
Main Contributor Admin

It may also possible (I think) if work is entered through Ticket.
Does the work lines have non null idWorkElement ?

Posted : 22 Jan 2019 18H06
(@bion)
Posts: 70
Active Member
Topic starter

Hello,
Work isn't enter through Ticket (we use timesheet screen only). Also in DataBase every line of work got Null idWorkElement

We get this "Bug" once again yesterday and i think it occur when a ressource input time for another ressource.

For example Ressource A input time for Ressource B From Monday to Friday, 8 hours per day on the same activity. Ressource B will have it's time well input but ressource A will also get it so when it want to input time for his own activity it will get [Ressource A's activity + Ressource B's Activity] speaking of time spent

Posted : 23 Jan 2019 10H49
(@bion)
Posts: 70
Active Member
Topic starter

I just saw that on projeqtor V7.3.2 this bug is patch

We are currently on V7.3.0, i'll do the update

Posted : 23 Jan 2019 15H30
(@bion)
Posts: 70
Active Member
Topic starter

after upgrade every thing is fine

Posted : 29 Jan 2019 16H58
