Hello,
I have a question about gannt creation.

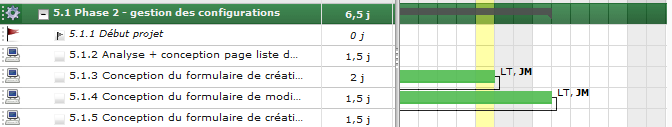

When i check my gantt i can see old done projects always planned to today ?
(As you can see in attachment :

)

All activities are done and also my project so i don't know why i can see this project.

Have a good day



Posted : 19 Aug 2016 12H46
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


1) Did you re-claculate plannig of your project ?
2) can you show print screen of the project detail ?



Posted : 19 Aug 2016 16H09
(@jonathan02500)
Posts: 21
Active Member
Topic starter


Yes i recalculated it.

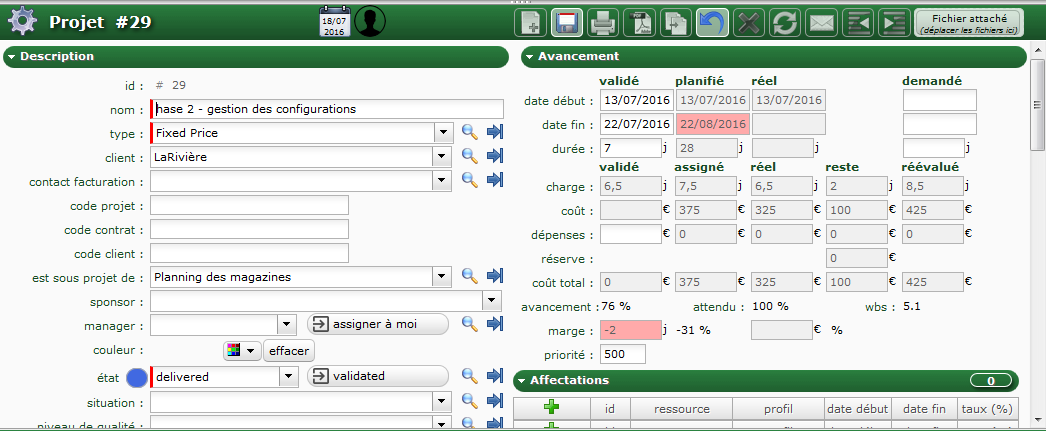

You can find in attachment the printscreen of my project



Posted : 19 Aug 2016 16H27
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


You project has 2 days of left work.
So these two days are always planned from recalculation of planning.



Posted : 22 Aug 2016 1H26
(@jonathan02500)
Posts: 21
Active Member
Topic starter


Ok thank you very much; problem solved !
But i have one more question please, with some project i can't modifie validate work, do you know why ?



Posted : 22 Aug 2016 16H20
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


If depends on "consolidation of validated work" option you selected on global parameters screen.
If you did not change defaut value, consolidation is "only if set".
This means that if you have sturture like
A
...B
...C
......D
......E
You can for instance define validated work on B and C.
Sum will be consolidated on A, so validated work on A is locked (because it is calculated).
If you don't set validated work on D and E does not matter : zero values will not overwrite existing value on C. But if you start and entrer validated work on D, you have to also define it on E, as sum will be consolidated on C.

Hope this is clear. :silly:



Posted : 25 Aug 2016 1H21
