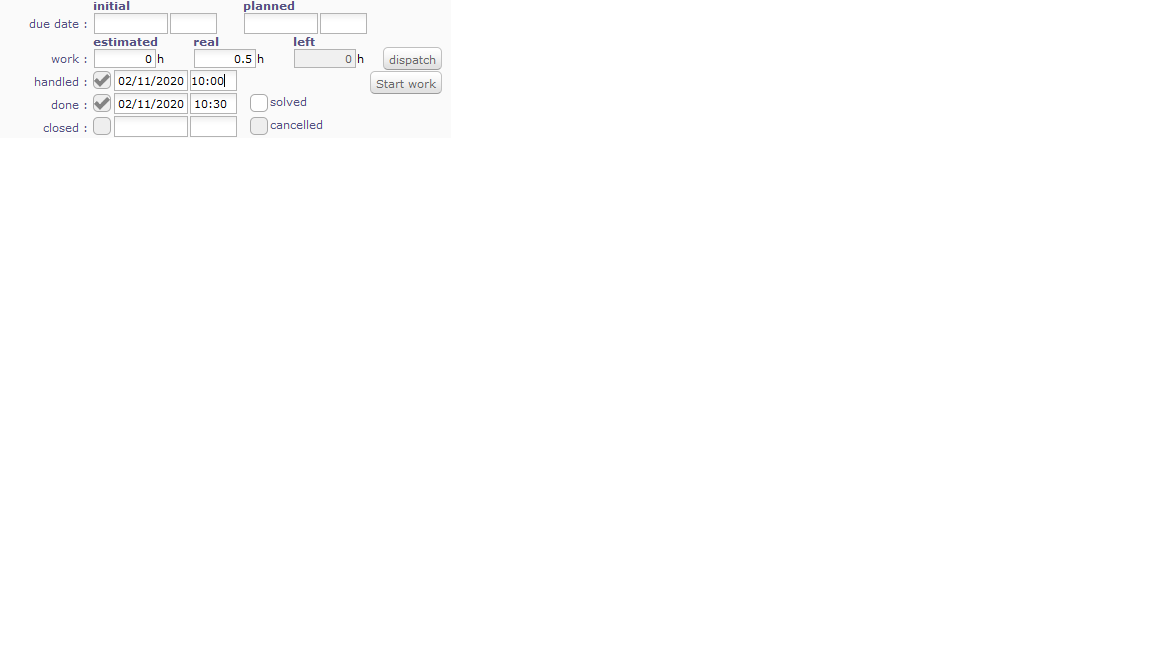

Activate Global Parameter "Manual progress of Fixed planning activities"
Then only use Fixed duration planning mode, without assignment.
You'll have access to enter manual progress and real work will be calculated as validated x progress
