Forum

Welcome to ProjeQtOr new Forum. We migrated old forum to the new website.
You will find all your posts here, with your usual account.
Just one point : you’ll have to reinitialize your password. Use “Lost password” feature.

[SOLVED] Burndown c...

Notifications
Clear all

[SOLVED] Burndown chart oscillation

13 Posts
2 Users
0 Reactions
7,834 Views
(@pipobru)
Posts: 180
Active Member
Topic starter

[#6112]

Hello,

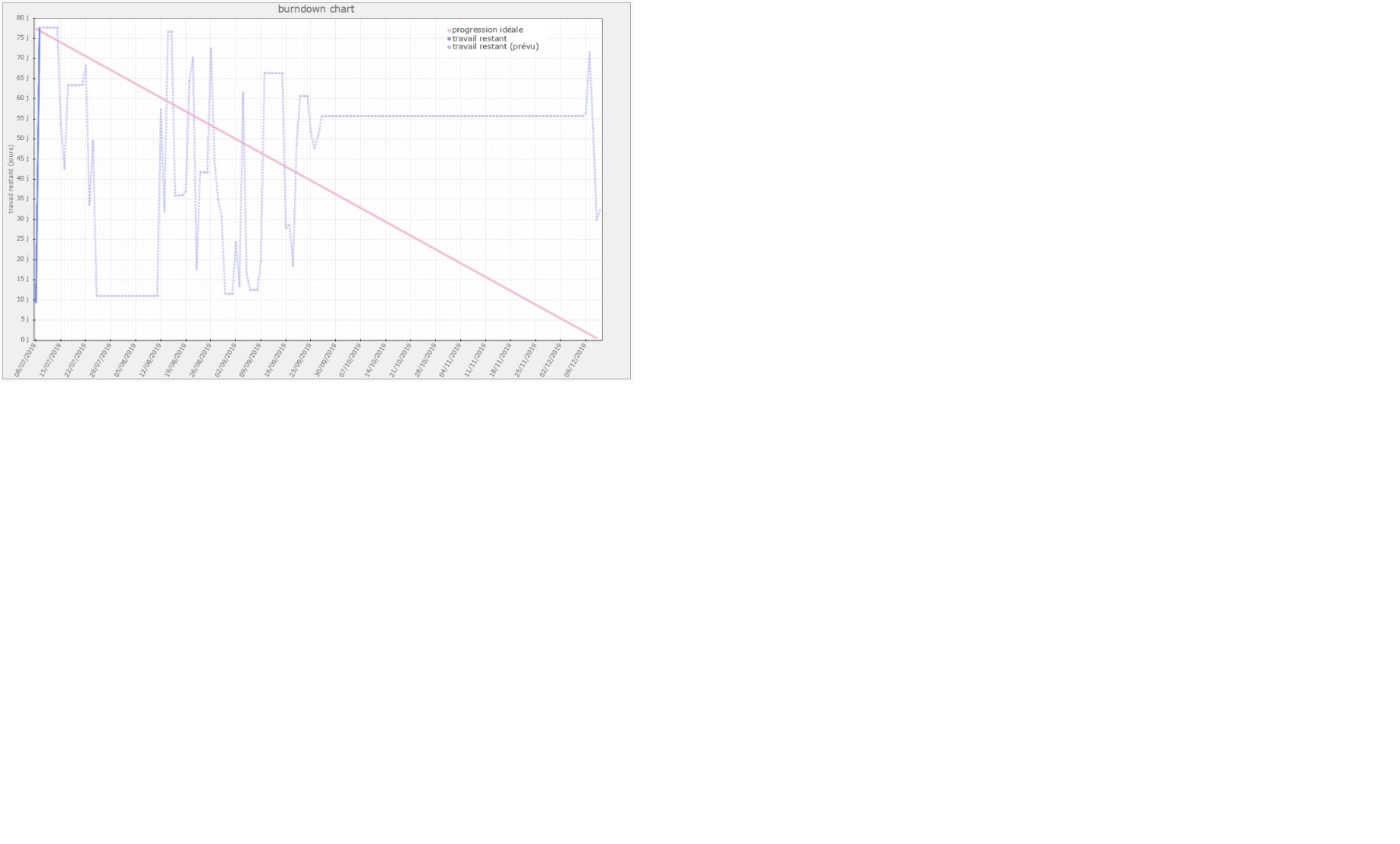

Can you explain to me how or why the burndown chart oscillates ? See the screen in attachment.

Thanks you



Posted : 09 Jul 2019 13H52
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


No, I cannot
(not with so few information)



Posted : 09 Jul 2019 14H04
(@pipobru)
Posts: 180
Active Member
Topic starter


Sorry, can you just explain how the burndown are construct ? may be a bug with the calendar calcul. Charge on activity are not correcly dispatch in the time ?
what information do you need? i have some tests on this subject you can contact me directly if you want some informations and after post a spcifict answer



Posted : 09 Jul 2019 14H20
(@pipobru)
Posts: 180
Active Member
Topic starter

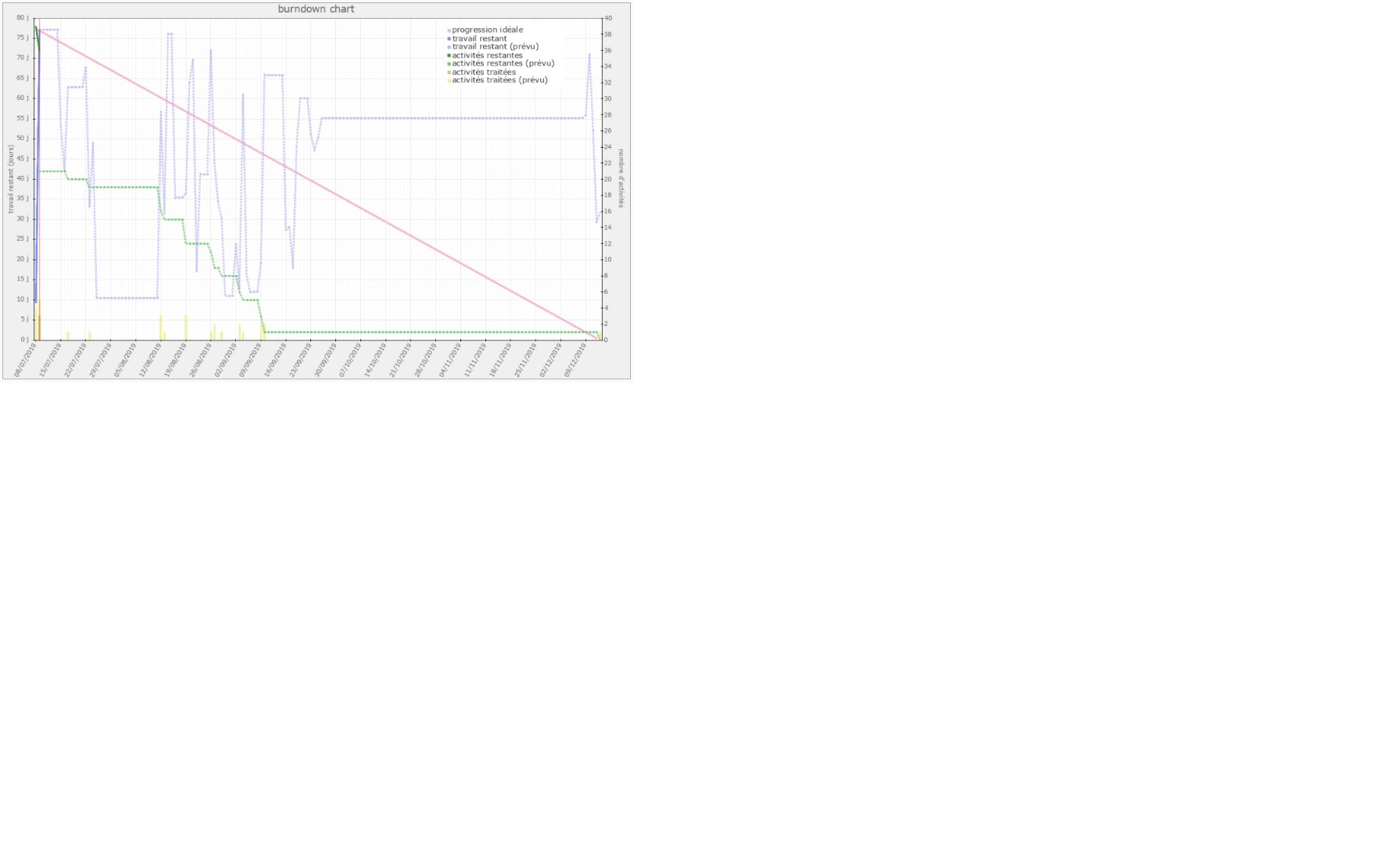

My main question is: why activitys lower but remaining work increases ? see the screen capture in attachement.



Posted : 09 Jul 2019 19H39
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


Hi,
Difficult to understand without all data.
But it's effectively strange to see left work increase...



Posted : 13 Jul 2019 20H45
(@pipobru)
Posts: 180
Active Member
Topic starter


Hello, the clock of the system (same system for apache and postgresql) can explain the oscilation ? If the clock have a problem and have 2h of late ? (Date is OK)



Posted : 18 Jul 2019 12H04
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


I don't kwon is clock time can have impact to this screen, but of course you should fix this and check



Posted : 18 Jul 2019 18H29
(@pipobru)
Posts: 180
Active Member
Topic starter


unbelievable, i give access to an external user, i test the rules acces with two differents navigators. One navigator have a administrator acount and the other navigator is loged with the new user acount. When i test on same project with same options, with my administrator count burbdown is OK and with the new acount, burndown oscillation are displayed. see my screenshot in attachement. (Clock on the server is ok now)



Posted : 19 Jul 2019 20H07
(@pipobru)
Posts: 180
Active Member
Topic starter


test this morning with an other computer, same test same result. I test withe a switch betwin the two navigators and same result. Conclusion the problem is on the server and source code not on local computer (cache navigator or other specific local environements)



Posted : 20 Jul 2019 11H52
babynus
(@babynus)
Posts: 14966
Main Contributor Admin


Possibly it is an access right issue : your project may have sub-projects and your user does not have access to sub-projects...



Posted : 25 Jul 2019 18H15
(@pipobru)
Posts: 180
Active Member
Topic starter


Hello,
thanks for your answer. No acces rules problem and no sub-project.



Posted : 25 Jul 2019 18H36
(@pipobru)
Posts: 180
Active Member
Topic starter


Hello,
after more tests i note the problem disappear after some time.

No no explanation, just an ascertainment

Thanks
Bruno.



Posted : 29 Aug 2019 16H07
(@pipobru)
Posts: 180
Active Member
Topic starter


Hello,
On last version and pearps after the the correction on pool for the blue line, the problem is solved.



Posted : 10 Apr 2020 10H26
