SOLVED[Full Time Equivalent] -planning doesn't change when daily rate modified

3 Posts
2 Utilisateurs
0 Reactions
1,393 Vu
(@bulle-it)
Posts: 2
New Member
Début du sujet

[#8555]

Hello everyone,
I suppose a simple project with a PM and an architect for a specific sequence, "think".
I set a PM with 1FTE and 100% daily rate and this architect with 1FTE but 50% daily rate on this project.

I expect the planning to get longer because I affected only this ressource for my 20d sequence "think".

However, even if I check "automatic run plan" nothing appends on the planning.

I tried changing the Architect FTE to 50% independing to the project or I tried to change the rate regarding the "think" activity within the project but no consequence on the planning

Thank you for your help

Regards,
Christophe FR




Posté : 12 Oct PM 20:1010
(@marylene)
Posts: 592
Membre Admin


Hello !

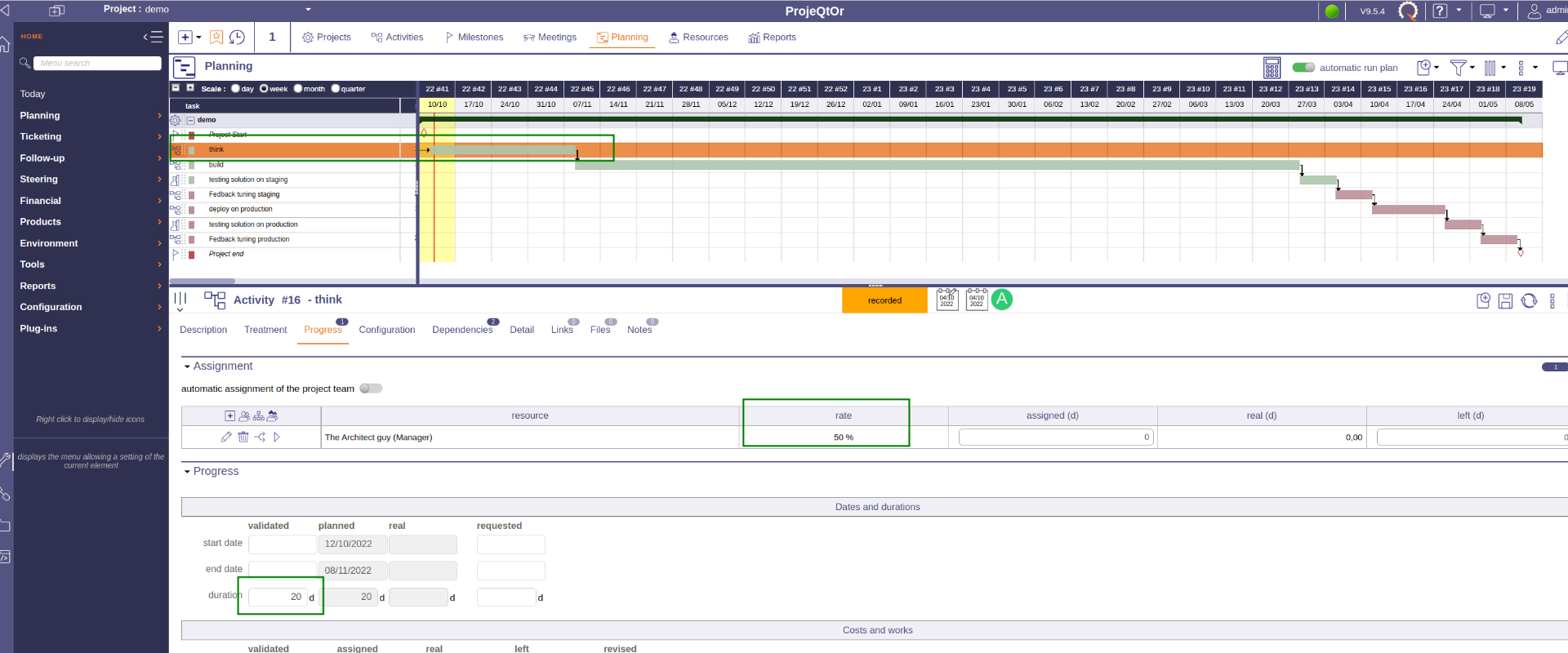

your bars are pale green. This indicates that you have not assigned a workload to your resource. Look at your assignment table, it has 0 days assigned.
The validated workload that you enter does not affect your planning and recalculating the planning will not change this.

A short tour here will give you better information on dates, durations, work and costs



Posté : 14 Oct AM 11:1010
(@bulle-it)
Posts: 2
New Member
Début du sujet


Hello Arkhanje,
You are so helpfull 🙂
I will test even if I believed I have tested it with a all green color but I should have made an error within this section
PS : I will update this topic to solved with my feedback when I am gonna to test it

Actually Arkhanje was true so I began to play with the assignement.
Regards, Christophe
