Hello,
We have a question about the management of ProjeQtOr.
But first, we have to explain how we use the application.
When we create a project and an activity in ProjeQtOr, we assign it to a team using the field « responsable » and the part « assignation » and we indicate the workload.
When all the necessary fields are completed, we go to the planning view and calculate the planning.

Thanks to this action, the activity appears in the reporting of the team.
Each team is made up of different people. When the team leader wants to assign someone of his team to an activity, he changes the field « responsable », putting the name of the person concerned and taking of the team and do the same thing for the part « assignation ».
Then, he doesn’t calculate the planning again.

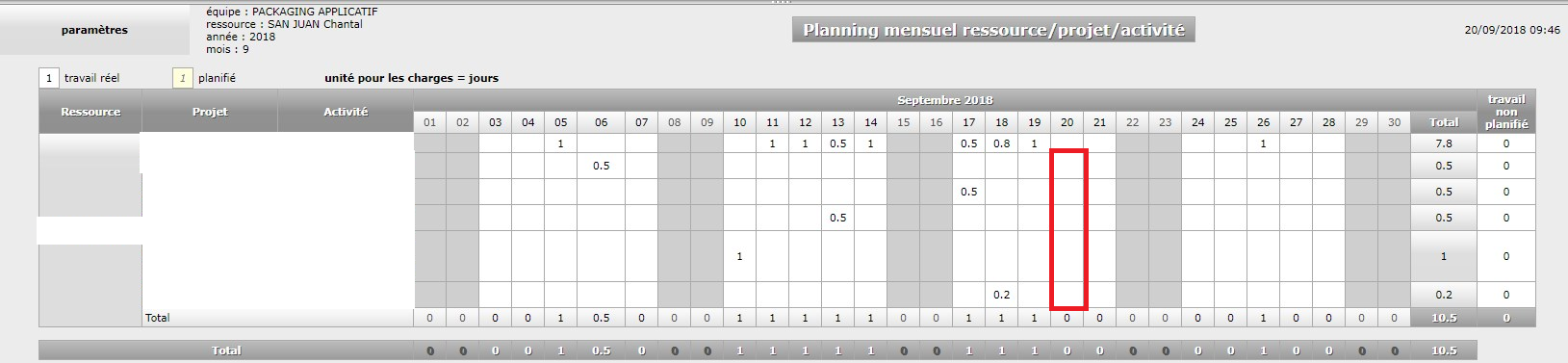

We have a problem because each information is distorted in the report of the teams. When the team leader looks at the activities of each person of his team in the report, there are some mistakes and the workload of the person doesn’t appear if he/she didn’t make his/her imputation.
My question is to know :
- If we are using the application correctly ;
- If ProjeQtOr allows us to manage named assignment when the assignment starts from a team.
I hope everything is clear, it isn’t easy to explain. Don’t hesitate if you have any question.
Thank you in advance.
Hi,
Using single resource for a Team should be used only for draft planning.
In your case, you should concider using "Pools"
Thank you for your reply.
What do you mean about "Pools" ?
Can you please give us a screenshot with this part.
Thank you in advance.
Environmental PArameters Pools of resources
F1 for help 😉
Actually we use Pools for our teams but we are not able to assign teams in Pools to the activity. We only can assign teams and people in resources.
Is it normal ?
Thank you in advance.
Yes.
Pools is sort of team.
Only individual resource can be allocated to pool.
This will constitue a Pool a resources, some kind of Team, that you can allocate to projects and assign to activitites (you cannot do that with teams, only with pools).
This will give possibilty to plan activities just konwing that "one resource of the pool" will work on the activity, but you don't know which yet.
This is important to allocate real resources to the pool as :
- sum of capacities of resources will generate global capacity of the pool
- planning of pool will take into account work planned for resources
- planning of resources will take into account work planned for pools, assuring that at least one real ressource is available to execute work planned for pool.
Check that you have access rights to screen "Pools"
We are administrators.
We have access to everything. I guess
No, it's not so simple...
Check access rights !
Which version are you using ?
the v7.0.8
👿
So I guess we have to update ?
From which version do "pools" appear ?
