Ok, thank you for your replies.
Hello,
Do you have another document about pool of resources. We have already readen the user guide (using f1) but have difficulties knowing how it works.
Here you can see the way we work in ProjeQtOr as mentioned in our former post.
"But first, we have to explain how we use the application.
When we create a project and an activity in ProjeQtOr, we assign it to a team using the field « responsable » and the part « assignation » and we indicate the workload.
When all the necessary fields are completed, we go to the planning view and calculate the planning.
Thanks to this action, the activity appears in the reporting of the team.
Each team is made up of different people. When the team leader wants to assign someone of his team to an activity, he changes the field « responsable », putting the name of the person concerned and taking of the team and do the same thing for the part « assignation ».
Then, he doesn’t calculate the planning again."
We would like to know the the charge assigned to the pool, and the charge imput by the human ressource...
Thank you in advance
Do you have another document about pool of resources. We have already readen the user guide (using f1) but have difficulties knowing how it works.
Unfortunately not.
Each team is made up of different people. When the team leader wants to assign someone of his team to an activity, he changes the field « responsable », putting the name of the person concerned and taking of the team and do the same thing for the part « assignation ».
Then, he doesn’t calculate the planning again."
You can just add assigned work for the resource, it will be substracted from the pool ,automatically.
Hello,
I have another question about pool of resources.
I have created a pool made of 2 resources (for a test).
To realize my test, I have created a project with 2 activities Inside.
The 1st resource of the pool have made his allocations in the activity assigned to the pool (he is reponsible of the activity).
The other one has done the same thing for the other activity (he is also the responsible of the activity).
When I check the reports (planning => monthly planning resource/project/activity), I find 2 different results for each resources. They have exactly the same profile.

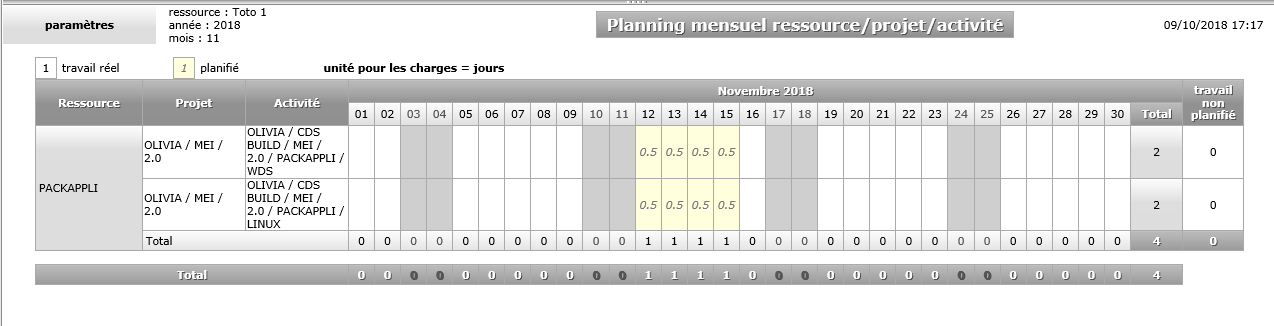

Here is the report for the 1st one :

Here is the report for the 2nd one :
Do you have any idea of where it can come from ?
Thank you in advance.
I guess PACKAPPLI is the pool, Toto 1 the first resource and Toto 2 is the second resource...
First report shows data for Toto 1, including work planned for the pool he belongs to.
As ha has nothing planned out of the pool, there is nothing else but pool data.
First report shows data for Toto 2, including work planned for the pool he belongs to.
Toto2 just sees his own real work additionnaly to pool data.
