"Work hours" for each resource (like for calendar)

8 Posts
2 Users
0 Reactions
10.5 K Views
(@ant740)
Posts: 20
Active Member
Topic starter

[#1574]

Hello,

Each resource can have a personal calendar
It will be usefull to have their own work hours (every resource don't work 7 or 8 hours per day and don't have same start and end time)

Thanks !
Anthony



Posted : 16 Jan 2014 11H54
(@babynus)
Posts: 14952
Member Admin


Work hours do not interfer with resource planning.
Work hours are only taken into account for :
- convertion from hours to days (and must be fixed for all resources)
- calculation of indicators in worked hours (and must be fixed for all projects)



Posted : 16 Jan 2014 11H59
(@ant740)
Posts: 20
Active Member
Topic starter


For exemple I've in my team some people who works 5 days/week and 7 hours/day
but I've other people who works 4 days/week and 8.75 hours/day

I can't manage this (or I don't find how...)



Posted : 16 Jan 2014 12H08
(@babynus)
Posts: 14952
Member Admin


No,
This case cannot be managed with ProjeQtOr. 🙁

And I don't know any Project Management Tool that can do it. :ohmy:



Posted : 16 Jan 2014 12H10
(@ant740)
Posts: 20
Active Member
Topic starter

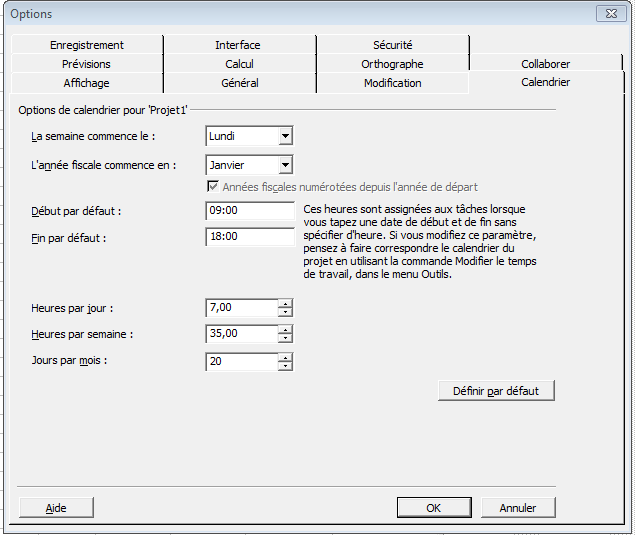

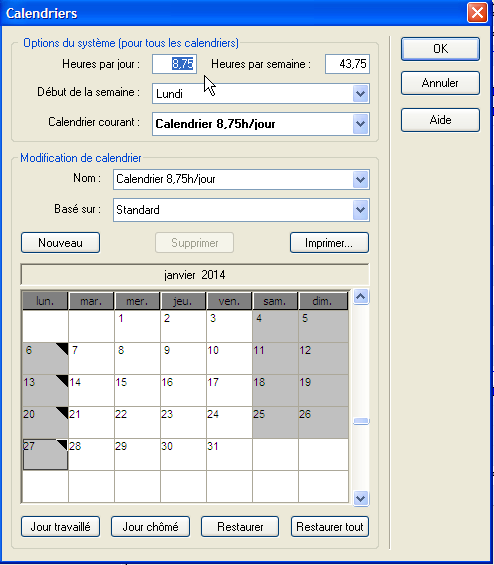

Yes, "Open Workbench" can do this
In fact, like Projeqtor, you can create calendar, but you can, in each calendar, chose numbers of working hours



Posted : 16 Jan 2014 12H24
(@babynus)
Posts: 14952
Member Admin


But how does it manage conversion from hours to days for all resources ?
When you display work for all project in days, how is done conversion from hours to days for all resources ?

I guess there is, like in MS-Project, some global definition of convertion.

So hours on resource calendar will only define working period.

You can get the same changing the capacity of the resource.
For instance, define work period of 8 hours a day.
Resource working 7 hours a day have capacity of 0,75.
Resource working 9 hours a day have capacity of 1,25, and a specific calendar with only 4 working days per week.



Posted : 16 Jan 2014 12H45
(@ant740)
Posts: 20
Active Member
Topic starter


" When you display work for all project in days, how is done conversion from hours to days for all resources ?"

"For instance, define work period of 8 hours a day.
Resource working 7 hours a day have capacity of 0,75.
Resource working 9 hours a day have capacity of 1,25, and a specific calendar with only 4 working days per week. "

==> it makes same thing than you propose to me
I've 1.25 days / day 🙂



Posted : 16 Jan 2014 13H06
(@ant740)
Posts: 20
Active Member
Topic starter


thanks for your help, your solution works perfectly !



Posted : 16 Jan 2014 13H19
