Export for MS project, wrong data for task duration

2 Posts
2 Utilisateurs
0 Reactions
1,728 Vu
(@ffornarini)
Posts: 1
New Member
Début du sujet

[#7559]

We have a problem exporting and reopening a project (gantt) from Projeqtor.
The duration of the tasks don't match.

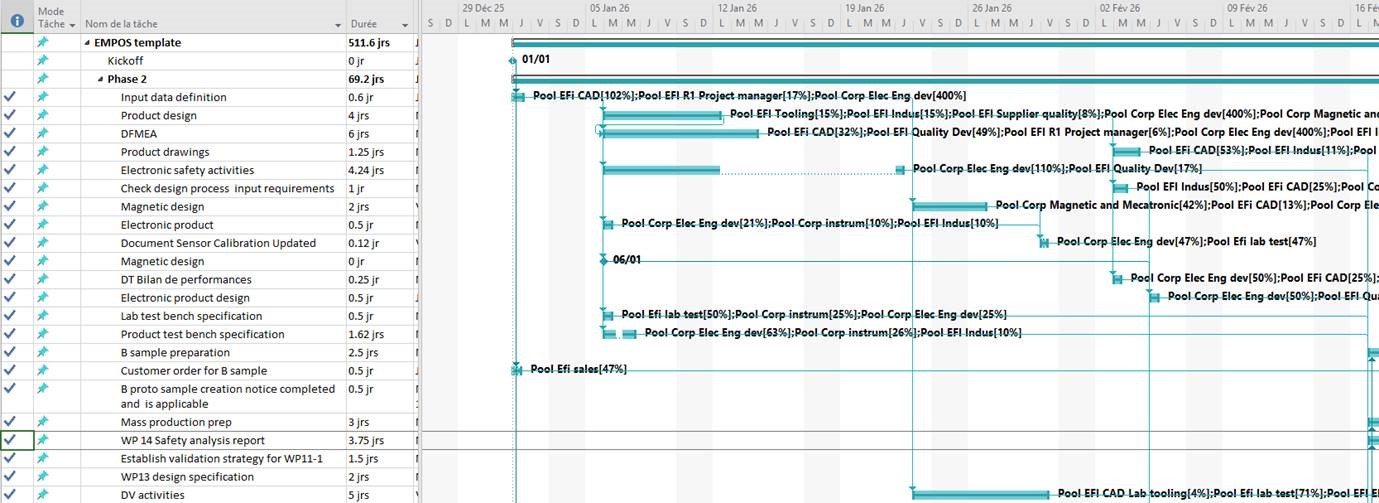

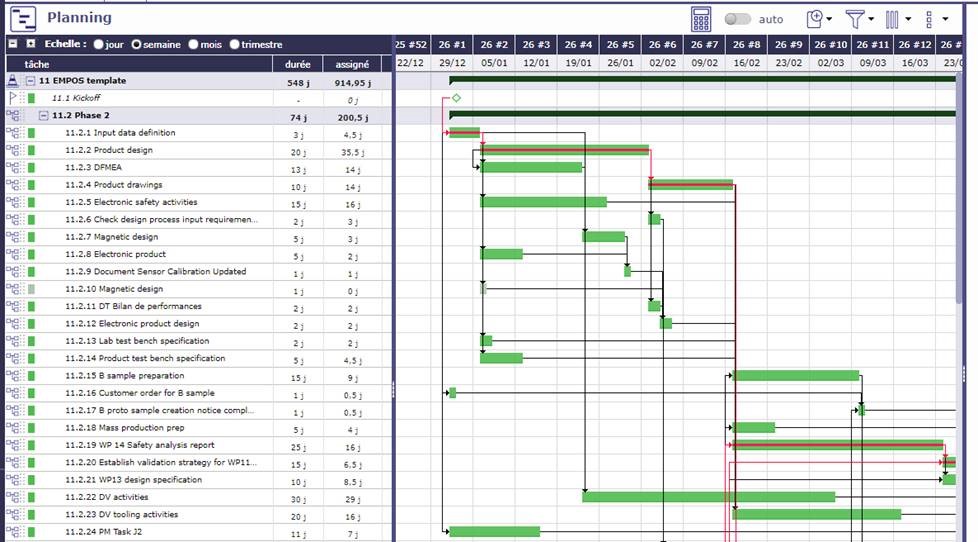

Example on the first 2 tasks on battached pictures :
- 'Input data definition ' task : 3 days on Projeqtor goes to 0.6day on MS project.
- "Product design" task : 20 days on projeqtor goes 4 days on MS project.


Have you ever seen this issues? Do you have a solution to are able to open the datas on MS project with the correct task durations.

Thanks for your help.



Posté : 31/05/2021 8:16 pm
(@babynus)
Posts: 14952
Membre Admin


I guess it is because MS-Project does not manage Pools.
Moreover, you are using a "unique resource" planning for the pools.
MS-Project does not understand and uses full pool capacity...

This is a limit of export/import with tools than don't plan the same way.



Posté : 04/06/2021 4:39 pm
