We encounter a logic problem in scheduling tasks. Here is the description of the problem:
Task to be prioritized
• Project Priority: 270
• Predecessor element ending on: 06/02/2020 (# 2192)
• Collab Assignment to project: 30% (without specified start and end dates) - NB: even tested with 100% without change
• Planning mode: as soon as possible
• Collaborator alone on the task
• Task priority: 500 (# 2279)
Task however planned before:
• Project Priority: 300 (# 16)
• Task priority: 500 (# 1957)
• Collab assignment to the project: 100% (all the time)
• Planning mode: as soon as possible
Many of the tasks in this second project are planned before, while the priority project task should be scheduled before.
Would you have a solution? a suggestion?
thanks in advance
Hello,
It could be plan after but never owe to be planed before or after. Planning calculation depend on dependencies and resources's disponibilities. Sometimes it could be explained also by the mode of planification you use on activities.
From now, it's missing some informations from your project to tell you why the calculation behaves this way.
Regards.
Thanks for your reply
No problem to give you more details on task or project concerned
Thank you for describing me the necessary additional information, I send it to you as soon as possible
ok
Hello,
I'm afraid we had a misunderstanding. Indeed, I need you to specify what you expect as additional information to identify the source of the problem. I would be happy to send you these items back.
Thanks
We need details (screenhshots) of 2 activities that you consider as not correcly planned : progress part, dependencies and assignments.
A screenshot of the planning showing the 2 activities.
Details of allocations of both projets.
Information of who is running planning calculation (profile, allocations,...).
You will show detailled information
First screenshoot : task must be planned just after predecessor end
Second screenshot : task planned between predecessor and task of first screenshot
Third screenshoot : task are from different project, then this screenshoot show project priority
Planning are calculated by admin, on all project.
Even each morning by automated task
Thanks for your help
Hello,
Please could you :
- highlight the lines to be read on Gant.
- SHow the resource allocations on projects and assignations on activities for each involved
- What about and where is the predecessor ? Do not really understand...
- Check the cell " show wbs " on Gantt view.
It will make it easy for me to understand the whole links.
Regards.
Dear team Projeqtor,
Thanks for this application, really important for us now since 4 years of current use
We encountered a new problem with planification
I will exposed task details that have problem
In the present case, a task without dependency, of type "activity", of a project of priority 290 is scheduled before a task without dependence, of type "activity", of a project of priority 100.
NB: the resource is unique and identical for the 2 tasks,
NB: the remaining charge is identical for the 2 tasks.
NB: the planning mode is at the earliest for the 2 tasks

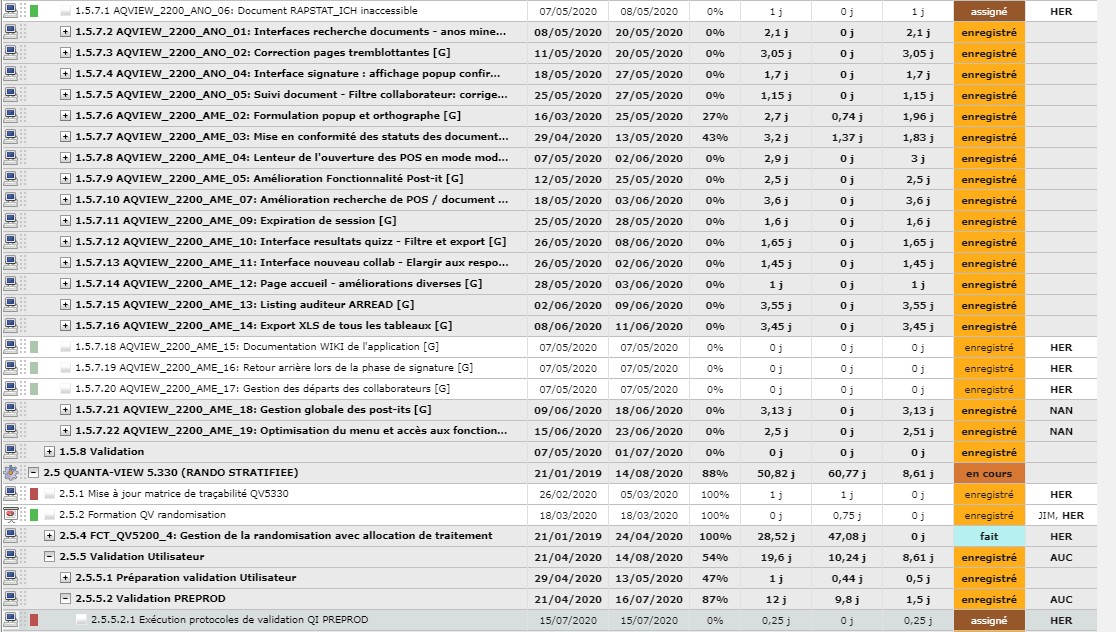

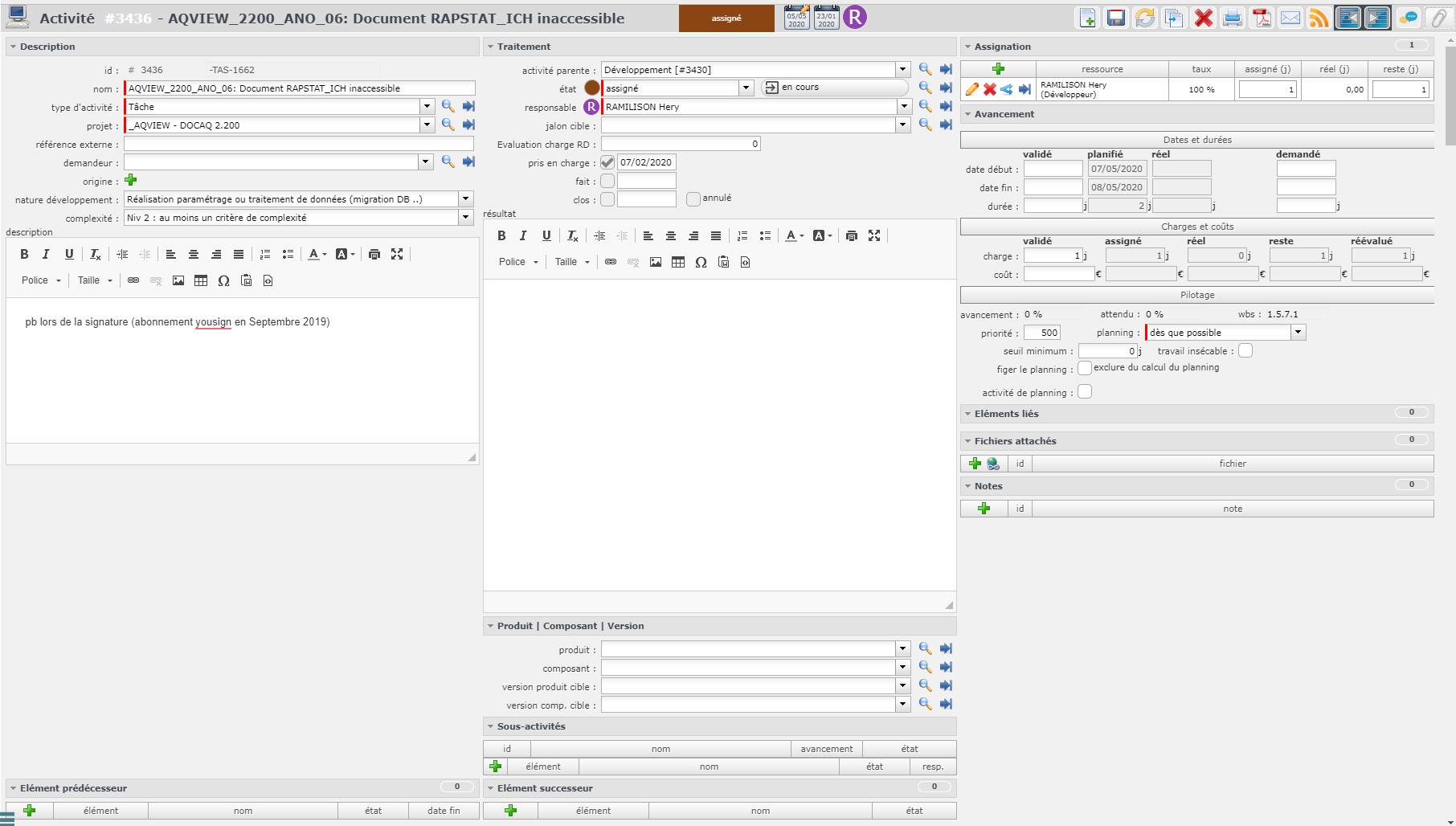

Task : AQVIEW_2200_ANO_06: Document RAPSTAT_ICH inaccessible (#3436)

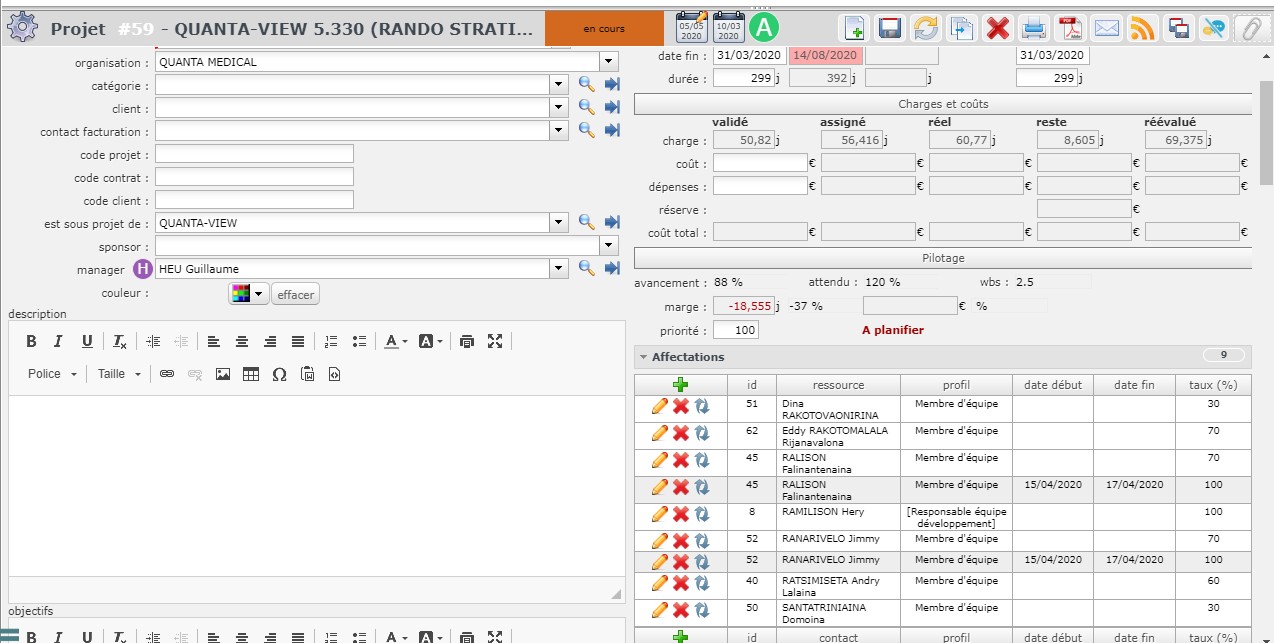

Project priority : 290

Ressource assigment on project "project manager" : 100% all date
Project type : internal
Task status : not started (assigned)
Task Type : Activity / task
Load : 1d
assigment of task : HER
Planned Start date : 07/05/2020
Planned End Date : 08/05/2020
Task Priority : 500
WBS : 1.5.7.1

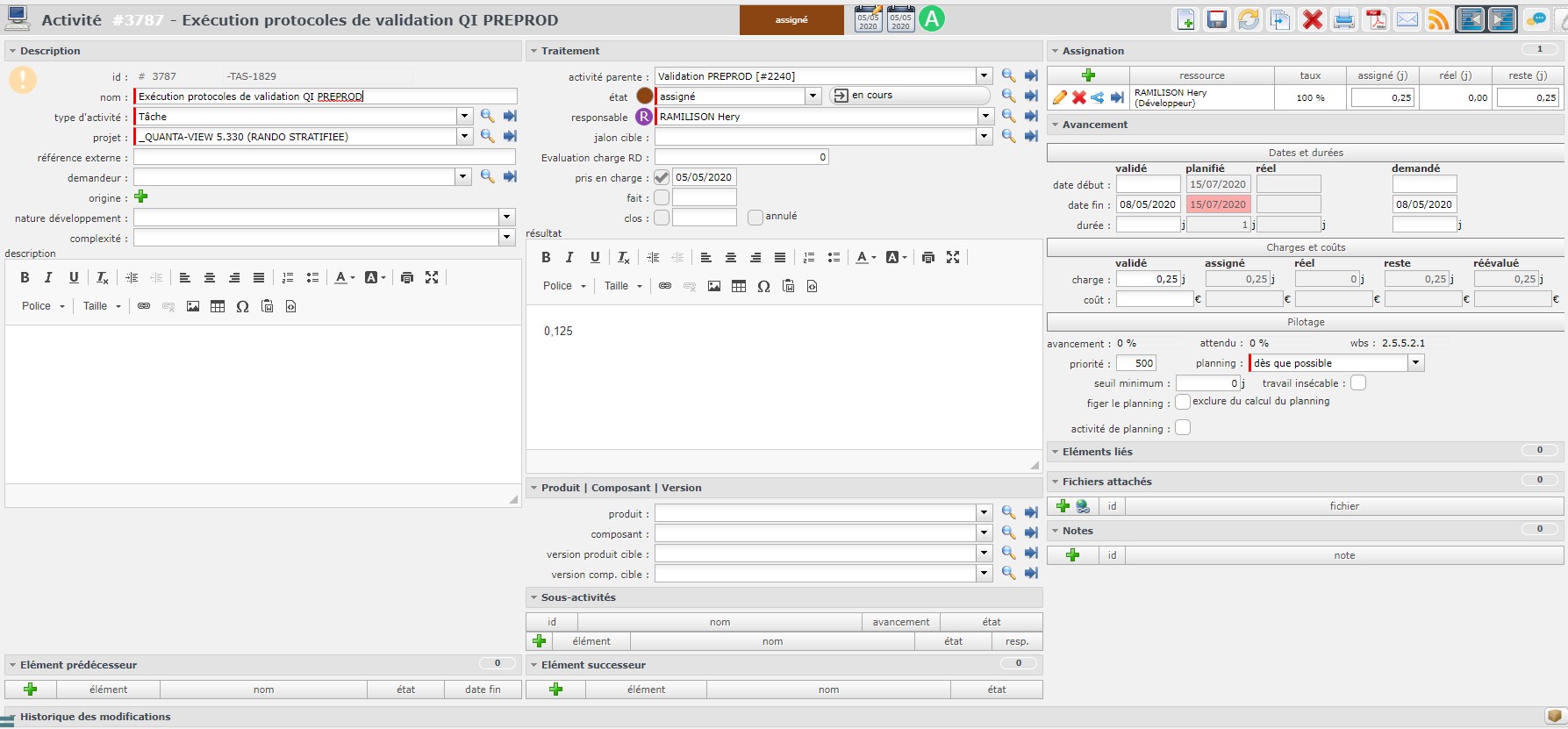

Task : Exécution protocoles de validation QI PREPROD (#3787)
Project priority : 100
Project type : internal
Ressource assigment on project "project manager" : 100% all date
Task status : not started (assigned)
Task Type : Activity / task
Load : 0,25d
assigment of task : HER
Planned Start date : 24/07/2020
Planned End Date : 24/07/2020
Task Priority : 500
WBS : 2.5.5.2.1

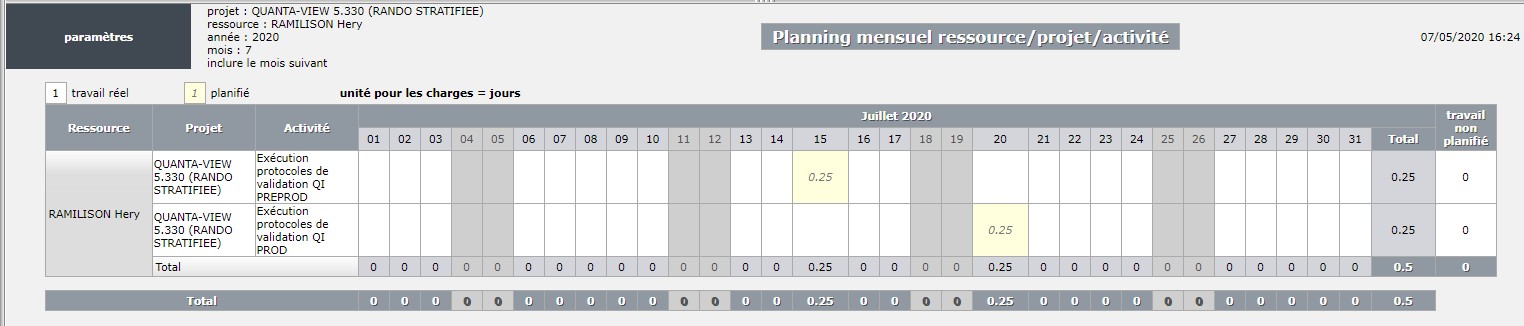

Plan task is runned each day by cron or by admin without any change
One of our developers is going to be working on this case next week, because it has a big impact for us, but we would be very interested in a solution that you could identify
Thanks for help
This can be due to dependencies.
When an activity or a project has a predecessor, even with better priority, it cannot be calculated before the predecessor, so will get the same priority as the predecessor.
