timesheet validation : orange but all seems ok

6 Posts
3 Utilisateurs
0 Reactions
1,572 Vu
(@groudillon)
Posts: 22
Eminent Member
Début du sujet

[#7931]

Hi,

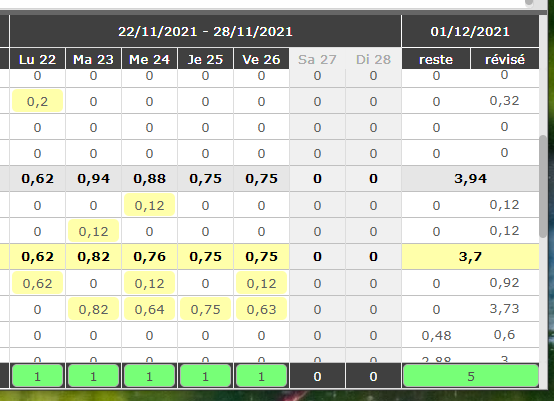

we have someone here who fulfilled his timesheet for week 47. All seems ok : all days green, and total of 5 for the week.



But on validation, it turns orange but green is expected since timesheet is ok







Posté : 01/12/2021 10:57 am
Flou
 Flou
(@flou)
Posts: 253
Reputable Member


Hello,

Indeed it's weird, what is your ProjeQtOr version ?
Your resource  have Overbooking or variation of resource capacity ?



Posté : 01/12/2021 5:24 pm
(@groudillon)
Posts: 22
Eminent Member
Début du sujet


we use projeQtoR v 9.3.4

no overbooking or capacity variation ...



Posté : 01/12/2021 5:27 pm
(@alain-fourastie)
Posts: 366
Membre Moderator


it's just a question of rounded numbers.
this is not a bug. Could be improved.



Posté : 01/12/2021 5:30 pm
(@groudillon)
Posts: 22
Eminent Member
Début du sujet


we tried to change data by canceling submission and enter other values in datasheet, then it turned green.

Then we entered original values, and after new submission, it s ok.

Yes, this was probably caused by rounded value... weird issue but now it s ok. Maybe there is something to do on submission process ?

anyway, it s ok now



Posté : 01/12/2021 5:47 pm
(@groudillon)
Posts: 22
Eminent Member
Début du sujet


same issue occured with another ressource : (this is not critical since we can validate timesheet with manual timesheet verification)

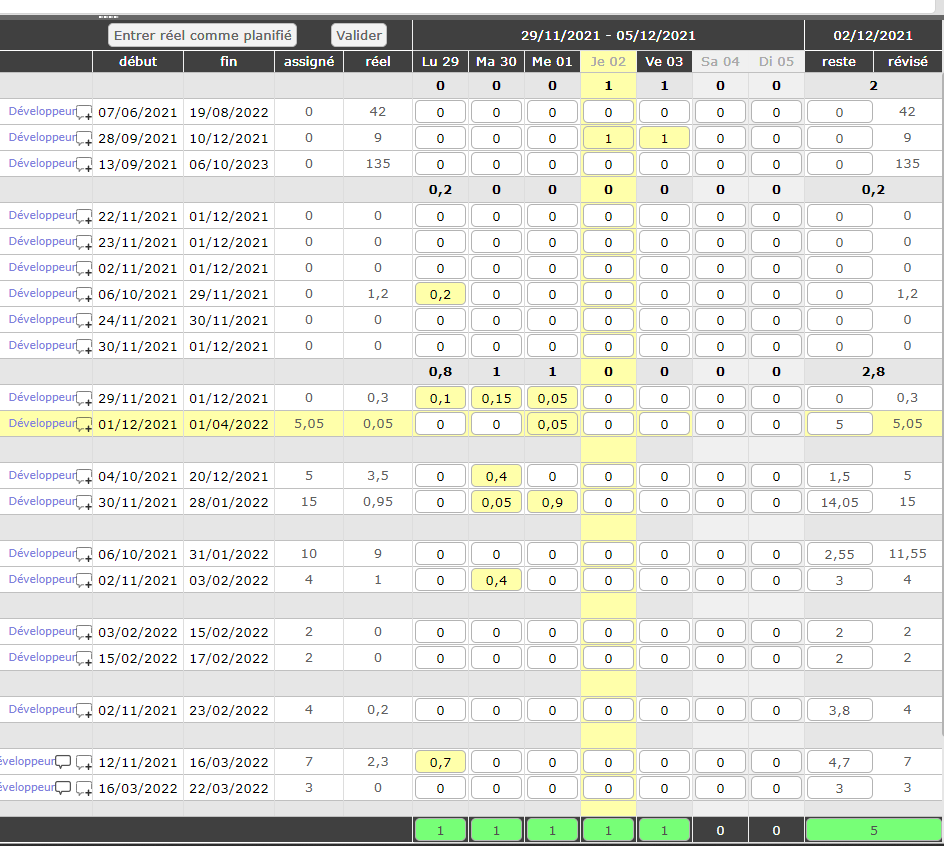

with this timesheet :





Posté : 02/12/2021 10:54 am
